A CMMS implementation checklist is a structured, phase-by-phase audit that verifies your goals, data, processes, integrations, and team are all ready before the software goes live. Studies show that 60% of CMMS rollouts miss at least one major goal — and the root cause is almost always a skipped pre-launch audit, not a bad product choice.
This guide gives you a 5-phase checklist you can copy and use today. Each phase lists the items to verify, who owns them, and what "done" looks like — so your maintenance management software gets adopted instead of becoming shelfware.

A CMMS implementation checklist is a written set of readiness criteria covering every stage of a software rollout — from goal-setting and data preparation through configuration, training, go-live, and the 90-day adoption review. It exists to catch missing pieces before they turn into expensive problems mid-project.
Teams typically use it three ways:
The checklist is owned by one project lead — usually the maintenance manager — with a named owner on every line item. Gartner research shows projects with a single accountable owner are roughly twice as likely to hit their original goals.
Research from McKinsey and Aberdeen Group consistently shows 50% to 70% of CMMS projects miss at least one major objective. The causes are predictable across industries:

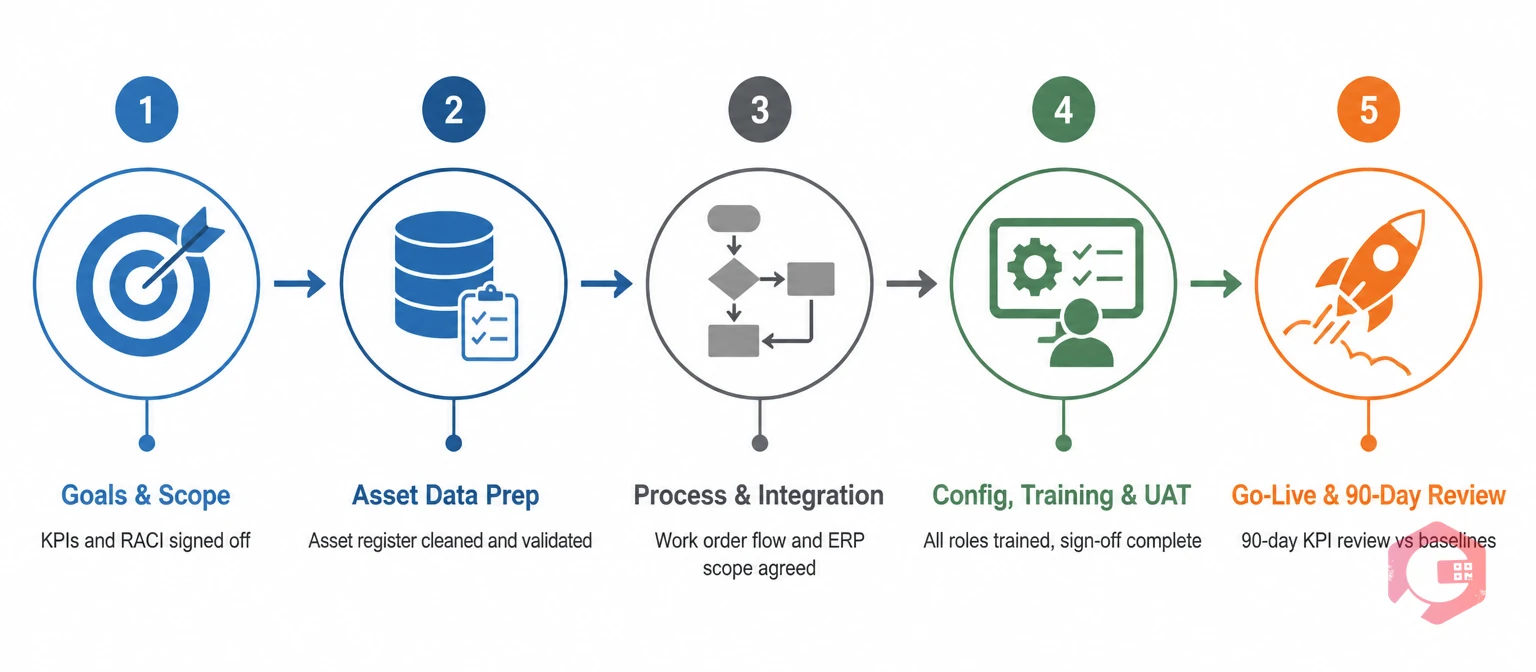

A pre-launch audit catches all five. The five phases below are that audit.

Before you talk to a vendor, lock down what success looks like and who's accountable. This is the phase most teams skip — and the most common cause of failed projects.
Pick 3 to 5 measurable targets tied to real operational pain. Common KPIs include cutting unplanned downtime by 25%, pushing preventive maintenance compliance above 90%, and reducing MTTR by 30%. Without these targets, you can't prove ROI — and you can't defend the project when it hits mid-implementation friction.
Every phase needs a Responsible, Accountable, Consulted, and Informed owner on every line item. Projects without a RACI matrix consistently lose track of who makes the final call when two departments disagree on a process — which happens in every multi-department rollout.
This is where most projects bleed time. The principle is simple: garbage in, garbage out. Three weeks cleaning data now saves three months of rework after go-live.
Start with a full export of your existing asset list — spreadsheet, EAM system, or paper forms. Flag duplicates, missing serial numbers, and assets with no location assigned. Many plants find 10% to 20% duplication when they audit names and serial numbers side by side. Resolve all duplicates before import — never after. If you're importing from spreadsheets, Cryotos supports bulk Excel imports and OCR-scanned forms via its asset tracking module, which cuts manual data entry significantly.
Document how work actually flows today before you try to digitize it. Systems built around how people think they work — not how they actually work — get abandoned within 90 days.
For ERP (SAP, Microsoft Dynamics, Oracle): which fields sync — purchase orders, asset master, cost codes? In which direction — one-way from ERP, one-way to ERP, or bidirectional? Who owns the field mapping spec? Cryotos supports native ERP integration with SAP and Microsoft Dynamics 365, and IoT connections via SCADA/PLC/edge devices. Defining scope in writing before configuration begins prevents the most common mid-project scope creep.
This phase makes or breaks adoption. The goal: every user touches the system on real work before go-live. If a technician's first interaction with the CMMS is a live work order on a critical asset, the system loses their trust permanently.

Go-live isn't the finish line — it's the start of the 90-day adoption window where most projects quietly fail. Set a structured review cadence before launch, not after.
Timeline is the question every project lead asks first. Here are realistic ranges based on implementation scope — single site vs. multi-site, and data readiness:
| Phase | Typical Duration | Key Milestone | Owner |
|---|---|---|---|
| Phase 1: Goals & Team | 1–2 weeks | KPIs and RACI signed off | Maintenance Manager |
| Phase 2: Asset Data | 2–4 weeks | Asset register validated | Data Lead / Planner |
| Phase 3: Process & Integration | 2–3 weeks | Work order flow and ERP scope agreed | IT + Operations |
| Phase 4: Config, Training & UAT | 3–5 weeks | All roles trained; UAT sign-off complete | Project Lead + Vendor |
| Phase 5: Go-Live & 90-Day Review | Ongoing (10–14 weeks post-launch) | 90-day KPI review vs. Phase 1 baselines | Maintenance Manager + Leadership |
| Total (single site, clean data) | 8–10 weeks | Live operations running | Executive Sponsor |
| Total (multi-site or complex ERP) | 4–9 months | All sites live and reviewed | Executive Sponsor |
Most implementation failures follow a predictable pattern. Here are the six mistakes that appear most often — and how to avoid each one:
Most single-site CMMS implementations take 8 to 16 weeks, depending on data readiness and integration scope. Multi-site rollouts typically run 4 to 9 months, usually phased one site at a time. Teams with clean asset data and a committed project lead consistently finish at the faster end of that range — Cryotos customers with clean data typically go live in 6 to 10 weeks instead of the industry-standard 12 to 16.
Total implementation cost includes software licensing, implementation services, internal labor (your team's time), integrations, and hardware. Small single-site deployments can run $15,000 to $40,000 all-in. Enterprise multi-site rollouts with complex ERP integration can reach $150,000 to $500,000+. Always budget a 15% contingency — integration scope creep is the most common cause of overruns.
The maintenance manager or operations director is the right project lead, with at least 30% of their time committed to the rollout. They need an executive sponsor (VP of operations or plant manager) for escalations and budget approvals, plus a site champion on the floor to handle day-to-day adoption questions from technicians.
For multi-site organizations, phased rollouts almost always win — start with one pilot site, capture lessons, then replicate. For a single-site deployment, go fully live once UAT passes. Running parallel systems for more than 2 weeks creates confusion and double data entry that actively hurts adoption.
At minimum: a clean asset register with unique IDs, locations, and criticality scores; 12 to 24 months of work order history (if migrating); your existing PM schedules and frequencies; and a spare parts list linked to assets. The cleaner this data is before import, the faster your team reaches productive use of the system.
A CMMS only delivers ROI if it gets adopted — and adoption starts with a disciplined pre-launch audit. Walk through the five phases above with your team, assign owners to every line item, and you'll already be ahead of the 60% of projects that miss their goals. Cryotos CMMS includes pre-built PM templates, OCR-based asset import, role-based access controls, and a dedicated onboarding lead — so most checklist items are pre-handled out of the box. Customers with clean data typically go live in 6 to 10 weeks instead of the industry-standard 12 to 16. Book a demo to walk through your specific checklist with our implementation team.
