How to Customize a Maintenance Checklist for Different Types of Machinery

Calendar
Duration:
10 min read
calendar today
Published on
May 20, 2026
Featured Image

A checklist built for a specific machine ensures technicians inspect what matters for that asset. Generic templates miss critical failure points. The Society for Maintenance and Reliability Professionals (SMRP) documents that tailored, asset-specific checklists reduce missed maintenance tasks by up to 38% compared to generic forms. This guide walks through a proven framework for building machine-specific checklists. It covers how to identify what makes each asset unique, how to structure the right fields, and how to deploy them at scale through a Computerized Maintenance Management System.

Key Takeaways

  • Machine-specific checklists target each asset's dominant failure mode — not a generic equipment category that applies to all machines.
  • Effective customization requires five analytical layers: failure mode, operating environment, usage intensity, regulatory obligations, and criticality class.
  • Every checklist needs three field groups: visual inspection, performance measurements, and safety or compliance checkpoints — each task mapped to a pass/fail outcome.
  • CMMS platforms auto-populate the right checklist per work order and escalate failed items to corrective work orders, removing manual routing from technicians.

What Is a Machine-Specific Maintenance Checklist?

A machine-specific maintenance checklist is a structured document built around an asset's failure modes and regulatory requirements. It differs from a generic template in one key way: every task maps to a real failure path for that machine type.

ISO 55000's asset management framework makes this point directly. Maintenance tasks should come from an analysis of failure consequences — not from copying industry templates without context. A centrifugal pump checklist focuses on shaft seal condition, bearing temperature, and vibration levels. An electrical panel checklist instead covers insulation resistance, busbar torque, and protective relay settings. Neither is wrong. But applying either checklist to the wrong machine creates systematic coverage gaps.

The gap matters most at high-criticality assets. A missed vibration check on a rotating shaft can cascade into an unplanned line shutdown. A missed insulation resistance test on aging switchgear creates a fire risk. Calendar compliance alone would never catch either failure. Machine-specific checklists exist because the consequences of missing a task depend on the asset. Generic templates cannot account for that difference at scale.

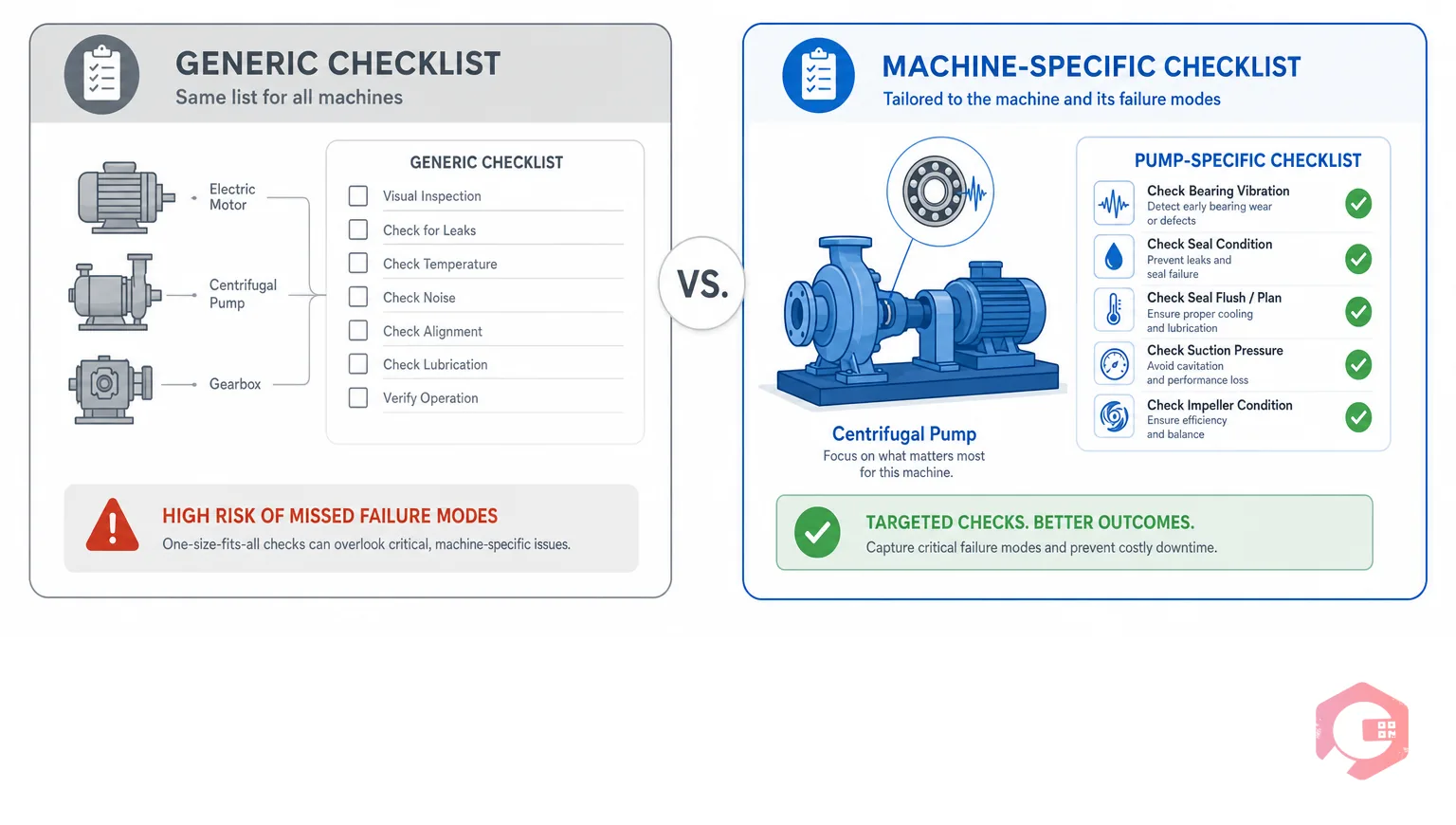

Why Generic Checklists Fall Short for Complex Machinery

In most maintenance operations, generic checklists persist not because they work, but because they look complete. Every field is filled in. Every technician signs off. Yet repeat failures keep happening. Facilities using equipment-specific checklists report a 27% lower rate of repeat failures compared to those using standardised forms. That gap reflects how much generic templates routinely miss.

The problem is structural. Generic checklists fail in four predictable ways:

  • Missed failure modes: A universal "check lubrication" task does not specify which lubrication point, what lubricant grade, or what contamination signs indicate a failing seal. That missing detail is what prevents bearing failure on high-speed rotating equipment.
  • Over-inspection on low-risk items: Technicians spend time on tasks with no failure consequence for that asset. This crowds out time for high-consequence checks that matter for that machine class.
  • No frequency logic tied to usage: A CNC spindle running three shifts degrades faster than one running single-shift. Calendar intervals ignore this. Checklist cadence should reflect actual wear cycles — not arbitrary monthly intervals.
  • Compliance gaps for machine-specific obligations: OSHA 29 CFR 1910.147 LOTO verification steps vary by energy source type. A hydraulic press has different isolation requirements than an electrical panel. A shared checklist cannot capture both correctly.

Maintenance teams that move to machine-specific checklists typically start with their highest-criticality assets first. They prove the model on one asset class, then expand. The payoff compounds as the checklist library matures and failure history informs iteration.

Key Fields Every Machine Maintenance Checklist Must Include

Regardless of machine type, every well-structured checklist organises tasks into three core field groups. The difference between machine types lies in the specific measurements and pass/fail criteria within each group. A downloadable starting point is the asset and equipment inspections checklist. You can adapt it to each asset class from there.

Visual and Physical Inspection Fields to Include

Visual checks form the first layer of any checklist. They require no instruments and catch the fastest-moving failure indicators. Every visual inspection block should cover:

  • Physical condition: Cracks, corrosion, structural deformation, missing guards, or exposed fasteners that signal impact events or material fatigue.
  • Cleanliness and contamination: Fluid pooling, dust buildup on intake vents, and coolant staining each point to a different failure path. Document them separately — not as a single cleanliness tick box.
  • Safety signage and guarding: Guards in place, interlocks functional, and emergency stop buttons unobstructed. Damaged guarding signals an impact event or unauthorised removal. Both require investigation before the machine is returned to service.
  • Seal and hose integrity: Bubbling, discolouration, or swelling at fittings indicates pressure or chemical degradation. Document the location and character of any anomaly — not just a pass/fail tick.

Performance Measurement and Threshold Fields to Capture

Performance fields translate observations into quantifiable pass/fail thresholds. Each task must specify the measurement method, the acceptable range, and the action required if the reading falls outside tolerance.

  • Temperature readings: Record bearing housing, motor winding, and hydraulic fluid temperatures against OEM-specified limits. Do not use general rules of thumb.
  • Vibration levels: Express in mm/s RMS for rotating equipment, referenced to ISO 10816-3 severity zones. Trending matters as much as the absolute reading. A value rising week-over-week inside Zone B warrants scheduled intervention before it crosses Zone C.
  • Pressure measurements: Record hydraulic system operating pressure versus rated pressure. Also check delta-P across filter elements to flag progressive clogging before it causes downstream damage.
  • Electrical parameters: Record amperage draw versus nameplate rating. Measure insulation resistance in megohms via megohmmeter. Compare each reading against the previous test date to detect a degradation trend.

Safety Compliance and Regulatory Checkpoint Fields

A safety checkpoint is a task that confirms a regulatory requirement has been met before work begins or before equipment is returned to service. Omitting these fields creates both injury risk and compliance exposure at the same time.

OSHA's hazardous energy control standard (29 CFR 1910.147) requires documented LOTO verification for every energy source on the machine. Your checklist must capture: energy isolation point confirmed, zero-energy verification completed, LOTO device serial number recorded, and authorised technician signature. Additional fields include: PPE type confirmed, permit status verified if applicable, and a corrective action field for any finding that prevents return to service.

How to Identify What Makes Each Machine Type Unique

The failure mode is the most critical input to any machine-specific checklist — it defines which tasks prevent breakdowns for that asset. The fastest way to identify it is to ask: what mechanism causes this machine to fail in this facility, under these specific conditions?

The reliability-centered maintenance (RCM) framework formalises this through systematic failure mode identification. Apply the following five-layer assessment before writing a single task for a new asset class.

The Five-Layer Machine Failure Profile:

  • Layer 1 — Dominant failure mode: What mechanism causes most failures for this asset class? Rotating equipment fails through bearing degradation and lubrication breakdown. Hydraulic systems fail through fluid contamination and seal degradation. CNC equipment fails through geometric drift and spindle wear. The dominant mode defines the anchor tasks — non-negotiable regardless of how brief the checklist needs to be.
  • Layer 2 — Operating environment: A pump in a food processing plant faces different contamination risks than the same pump in an automotive paint shop. Ambient temperature, humidity, chemical exposure, and dust concentration all change inspection priorities. Document these before setting task frequencies.
  • Layer 3 — Usage intensity: An asset running three shifts degrades faster than one running single-shift on identical components. High-utilisation equipment should use meter-based scheduling — operating hours or production cycles, not calendar intervals. Check total operating hours since last service before setting any task frequency.
  • Layer 4 — Regulatory obligation: What standards govern this asset class at this facility? Pressure vessels follow ASME Section VIII intervals. Electrical systems fall under NFPA 70B for thermographic surveys. Lifting equipment carries statutory inspection requirements. Each obligation adds mandatory checklist fields.
  • Layer 5 — Criticality class: What is the consequence of failure for safety, production, and cost? Class A critical assets warrant detailed checklists with the highest frequency. Non-critical assets can use simplified templates with longer intervals. Start checklist customisation with Class A assets and expand the model from there.

Checklist Requirements by Machine Type

Applying the Five-Layer Machine Failure Profile across five common machine classes produces the following priorities. Use these as starting points. OEM documentation and your site-specific failure history must refine every row.

Machine TypeDominant Failure ModesPriority Checklist ItemsFrequency LogicCompliance Reference
Rotating Equipment (pumps, motors, fans)Bearing degradation, lubrication breakdown, shaft imbalanceVibration mm/s vs ISO 10816-3, bearing housing temperature, lubrication point condition and gradeMeter-based (operating hours); weekly at high load or elevated temperatureISO 10816-3, OSHA 1910.147 LOTO
Hydraulic SystemsFluid contamination, seal degradation, hose fatigue failureFluid condition (NAS cleanliness code), system pressure vs rated, hose integrity, filter delta-PCalendar plus condition-based; increase after hose or seal replacementISO 4406 fluid cleanliness, OSHA 1910.147
Electrical and Control SystemsThermal degradation, insulation breakdown, loose terminal connectionsInfrared thermal imaging, megger insulation resistance in MΩ, connection torque, arc flash label conditionQuarterly thermographic survey; annual full condition assessment per NFPA 70BNFPA 70B, OSHA 1910.303, NFPA 70E
CNC and Precision MachineryGeometric drift, spindle wear, coolant contaminationSpindle runout in µm, axis backlash test, coolant concentration (Brix), auto-lube cycle confirmDaily pre-shift for spindle and coolant; monthly axis calibration per ISO 230-2ISO 230-2 geometric accuracy, OEM service intervals
HVAC and Utility EquipmentFilter clogging, refrigerant loss, belt and drive wearFilter static pressure drop, coil cleanliness, refrigerant pressure vs design, belt tension and alignmentMonthly filter check; quarterly coil and refrigerant; semi-annual belt serviceASHRAE 180, local refrigerant handling regulations

Each row reflects a different balance between frequency and specificity. Rotating equipment needs continuous vibration trend monitoring. Electrical systems need periodic but high-effort thermographic surveys. No single template can cover all five correctly. Asset-class-specific checklists are the baseline requirement — not an optional enhancement.

Step-by-Step Guide to Customizing Your Maintenance Checklist

Customising a checklist is a structured process — not a single document edit. These six steps produce a checklist that reflects both the asset's engineering requirements and your facility's operational constraints.

  • Step 1 — Extract from the OEM manual: Start with the original equipment manual. It is the primary source for service intervals, lubricant grades, torque specifications, and critical wear limits. Document every interval and tolerance before adding any site-specific tasks. OEM documentation sets the floor — regulatory and environmental factors build on top of it.
  • Step 2 — Apply the Five-Layer Machine Failure Profile: Work through each layer for this specific asset instance — not just the asset class. Two identical pump models in different process environments can produce significantly different checklists once the failure profile is applied.
  • Step 3 — Set frequency based on actual usage: Match each task to the right scheduling trigger. Calendar-based intervals work for low-utilisation assets or fixed degradation timelines. High-utilisation assets should use preventive maintenance software with dynamic scheduling via IoT meter reading. This triggers inspections based on actual operating hours or production cycles — not elapsed calendar time.
  • Step 4 — Write actionable task fields: Every task must specify: what to measure or inspect, the instrument or method to use, the acceptable range or pass/fail threshold, and the immediate action if the threshold is exceeded. "Check bearing" is not a task. "Measure bearing housing temperature with contact thermometer; record reading; escalate immediately if reading exceeds 85°C above ambient" is a task.
  • Step 5 — Set mandatory compliance checkpoints: Add LOTO verification, PPE confirmation, and asset-class regulatory fields as non-skippable blocks. These must appear as mandatory fields in your CMMS — not optional comment boxes that a pressured technician can leave blank.
  • Step 6 — Pilot, review, and iterate: Launch the checklist on one asset instance first — not facility-wide. After 30 days, review for tasks consistently skipped, measurements that never fell outside tolerance, and any failures the checklist did not catch. Adjust frequency, thresholds, and task specificity before scaling to the full asset class.

Use the Cryotos maintenance checklists feature to build, version-control, and deploy asset-specific checklists directly from your CMMS. Every work order auto-populates with the right inspection set for that machine.

How CMMS Software Makes Checklist Customization Scalable

Building the right checklist for one machine is manageable. Maintaining accurate machine-specific checklists across a facility with hundreds of assets is a different challenge. Keeping them current as equipment ages and regulations update requires systematic digital support.

Cryotos supports checklist customisation at scale through several key capabilities. Excel and OCR import converts existing paper-based or spreadsheet checklists into structured digital templates — no full re-entry required. Each template links directly to an asset record. When a work order is created for a hydraulic press, the hydraulic press checklist auto-populates. Technicians see only the tasks relevant to that specific machine.

Pass/fail logic with auto-escalation removes the manual triage step after inspections. A failed vibration reading on a rotating asset automatically generates a corrective work order with the correct priority, parts list, and craft assignment already attached. The technician logs the finding — the system routes the corrective action. Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. These results compound as machine-specific checklist compliance rates rise over time.

A full compliance audit trail is stored against each asset record. Every completed checklist, every failed item, and every corrective action is traceable. This supports internal audits and regulatory inspections — without manual record consolidation at the end of each period.

Frequently Asked Questions

What should a machine-specific maintenance checklist include?

It should include visual inspection fields tailored to that asset's failure indicators, performance measurement tasks with defined pass/fail thresholds, safety and compliance checkpoints including LOTO verification, and a corrective action field for any failed items. Every task must specify what to check, how to check it, the acceptable range, and what to do if the result falls outside tolerance.

How often should a maintenance checklist be updated for machinery?

Review checklists at least annually and immediately following any equipment failure, OEM service bulletin, regulatory change, or process modification. Also review after the first 30 days of deploying a new checklist. Tasks consistently skipped — or measurements that never fell outside tolerance — may signal that the checklist needs recalibration, not that the asset is healthy.

Can you use the same maintenance checklist for all types of machines?

No — a single generic checklist misses the critical failure modes specific to each machine class. A pump checklist built around vibration and bearing temperature will miss the thermal degradation and insulation breakdown that characterise electrical panel failures. Each machine type requires tasks derived from its own dominant failure modes, operating environment, and applicable compliance standards.

How does CMMS software help with maintenance checklist customization?

A CMMS like Cryotos links each checklist template to an asset record. The right checklist auto-populates whenever a work order is created for that machine. Digital templates enforce mandatory fields, log completion data against asset history, and automatically generate corrective work orders when items fail. This replaces manual paper workflows with a traceable, scalable system.

What is the difference between a pass-or-fail and a step-by-step maintenance checklist?

A pass-or-fail checklist verifies that a specific condition meets an acceptable standard — for example, confirming that bearing temperature is below 85°C above ambient. It gives a binary outcome and suits routine checks that operators can complete without specialist tools. A step-by-step checklist provides detailed procedural instructions for complex tasks, such as replacing a pump seal or performing a hydraulic flush. It walks technicians through every action in sequence so no critical step is missed.
