In SLAs for maintenance contractors, response vs resolution is the gap between how fast a contractor starts work on a fault and how fast the asset is back in service. Response time measures engagement. Resolution time measures the fix. A contract that tracks only one of them lets a contractor hit every target while your equipment stays down.

Most contractor disputes don't come from the targets in a service-level agreement itself. They come from vague clock rules: who starts the clock, what pauses it, and what counts as "resolved." This guide explains response vs resolution in plain terms, gives typical targets by priority, and lists the clock rules to write into every contract. It also shows how a Computerized Maintenance Management System (CMMS) measures both clocks from the same data.

Key Takeaways

  • Two clocks, not one: Response time proves a contractor engaged; resolution time proves the asset is fixed and verified.
  • Clock rules decide disputes: Define the start event, pause reasons, and resolution criteria before you argue about targets.
  • Priority sets the target: A P1 critical failure needs a 30-minute to 1-hour response, while a P4 request can wait days.
  • System timestamps end the debate: A CMMS records every stage of the job, so both sides report the same SLA number.

Response vs Resolution Time: Key Differences

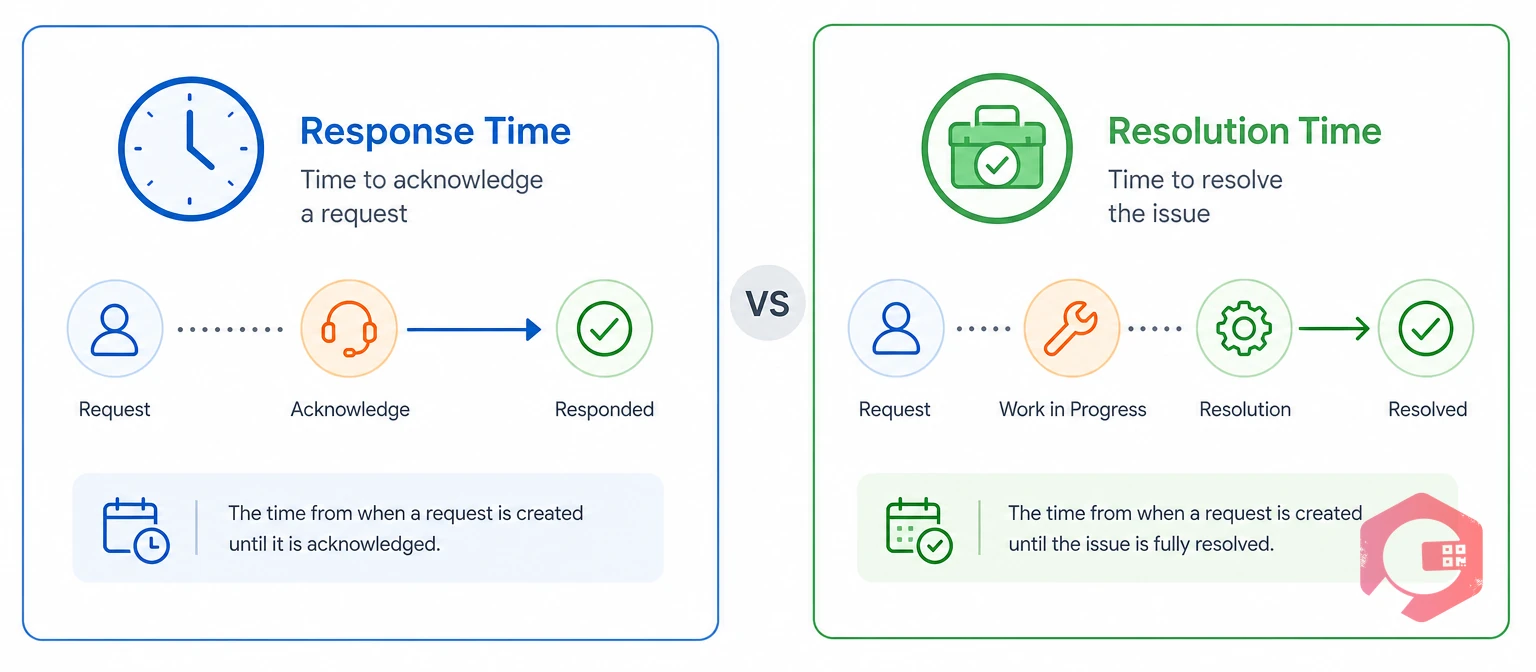

Response time versus resolution time comparison in a maintenance contractor SLA | Cryotos

Response time is the elapsed time from a logged request until a technician starts working on it. Depending on the contract, "starting" means remote diagnosis or physical arrival at the asset.

Resolution time is the elapsed time from a logged request until the fault is fixed, and the job is verified closed. It proves the problem won't come straight back next week.

FactorResponse TimeResolution Time
What it measuresHow fast the contractor engagesHow fast the asset is back in service for good
Clock stops whenTechnician starts diagnosis or checks in on siteRoot cause is fixed and the job is signed off
What it provesSomeone is working on the faultThe fault is gone
Typical P1 target30 minutes to 1 hourRestore in 4 hours, permanent fix in 24 hours
Risk if measured aloneFast arrivals, long downtimeSilent triage, no early warning

What Asset Management Standards Say About Repair Time

Asset management standards such as ISO 55000 judge maintenance by the value an asset delivers, not by activity logged. Reliability programs built on SMRP metrics also track mean time to repair (MTTR) as its own measure, apart from response speed.

The short version of response vs resolution: response time tells you the contractor showed up, and resolution time tells you the job is actually done.

The Five Clock Events in a Contractor SLA

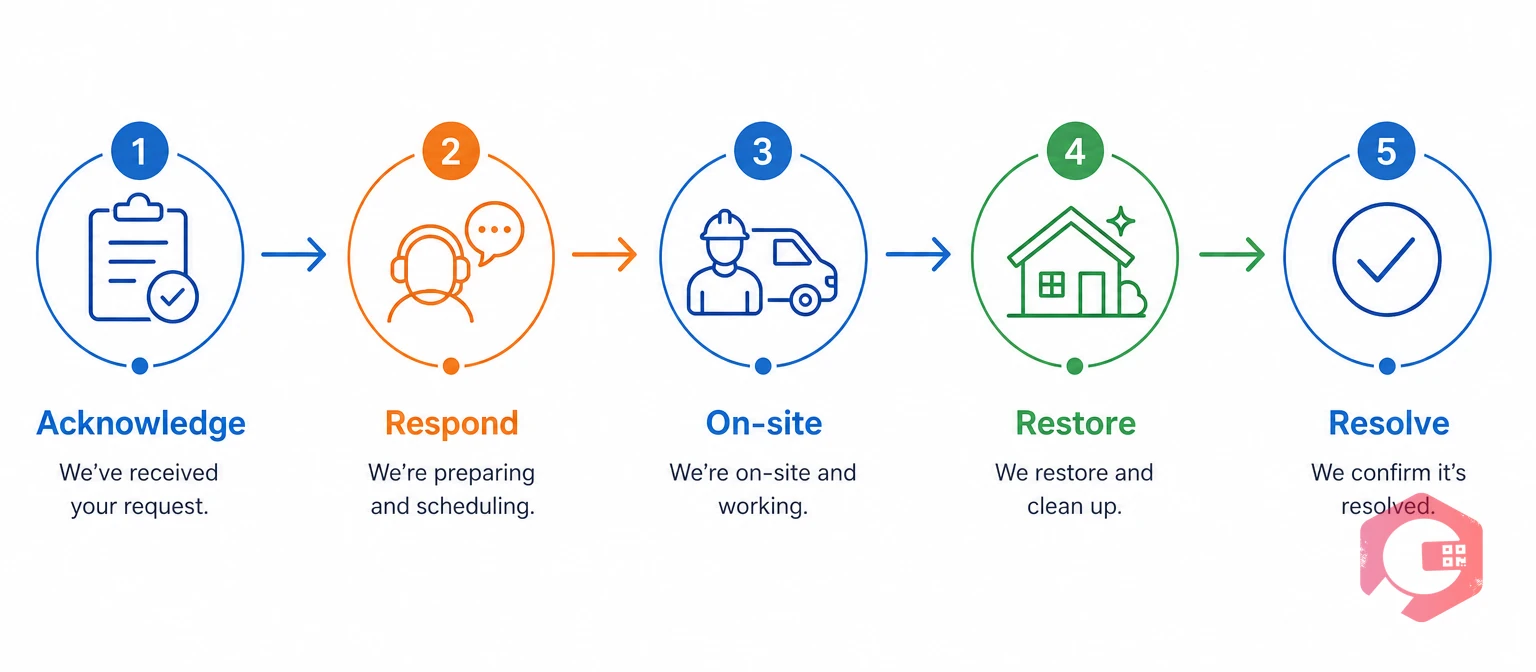

The five clock events in a contractor SLA from acknowledgement to resolution | Cryotos

Every contractor job passes through five events, and each one needs a timestamp. This is where response vs resolution becomes concrete: both clocks start at the same moment, but they stop at different points.

  • Acknowledgement: The contractor accepts the job, which proves they saw it.
  • Response: A technician starts diagnosis, remotely or on site, and the response clock stops.
  • On-site attendance: The technician checks in at the asset, for jobs that need a physical visit.
  • Restoration: The asset runs again on a temporary fix, so operations can continue.
  • Resolution: The root cause is fixed and verified, and the resolution clock stops.

Restoration is a temporary fix that gets an asset running while the permanent repair is planned. Many contracts set a separate restoration target for critical assets, because production can't wait for parts to arrive.

Logging every fault through digital work requests gives each job one reliable start time. Without that, every other timestamp in the SLA is open to argument.

Why Measuring Only One Clock Fails

A contract that measures one clock lets a contractor meet the SLA while the business still loses production. Most facilities discover this after a month of green SLA reports and red downtime numbers.

  • Response only: A technician arrives fast, logs "attended," and leaves for days to fetch parts. The report shows 100% compliance.
  • Resolution only: The contractor delays acknowledgement and triages quietly. You can't plan around the outage or escalate early.
  • Closure without verification: Jobs get closed early, then come back as "new" requests. Repeat failures stay hidden.

Tracking response vs resolution together, plus a reopen rule, lines up contractor incentives with uptime. It also gives you early warning, because a missed response target usually predicts a missed resolution target.

Want escalations to fire before a target slips? See how Cryotos workflow automation handles SLA escalations.

How to Set Response vs Resolution Targets by Priority

Set targets by priority, and set priority from asset criticality and failure impact. Don't let the loudest caller decide.

PriorityTypical TriggerResponse TargetResolution TargetCoverage
P1 CriticalSafety risk, line down, critical asset failed30 min to 1 hRestore in 4 h, fix in 24 h24x7
P2 HighAsset degraded, backup lost, compliance risk2 to 4 h24 to 48 h24x7 or extended hours
P3 MediumNon-critical fault, workaround exists1 business day3 to 5 business daysBusiness hours
P4 LowMinor or cosmetic request2 to 3 business days10 business days or next visitBusiness hours

These are common industry ranges, not fixed rules. Manufacturing and healthcare sites usually sit at the tight end. Commercial buildings usually sit at the looser end.

Use a Criticality Matrix to Assign Priority

Rate each asset A (critical), B (important), or C (non-critical). Then cross that rating with the failure impact: stops operations, degrades operations, or no impact. A critical asset that stops production is always P1, while a non-critical asset with no impact is P4.

A written matrix keeps priority consistent across shifts, sites, and contractors, so the right response vs resolution target applies every time.

The Two-Clock SLA Framework for Contractor Contracts

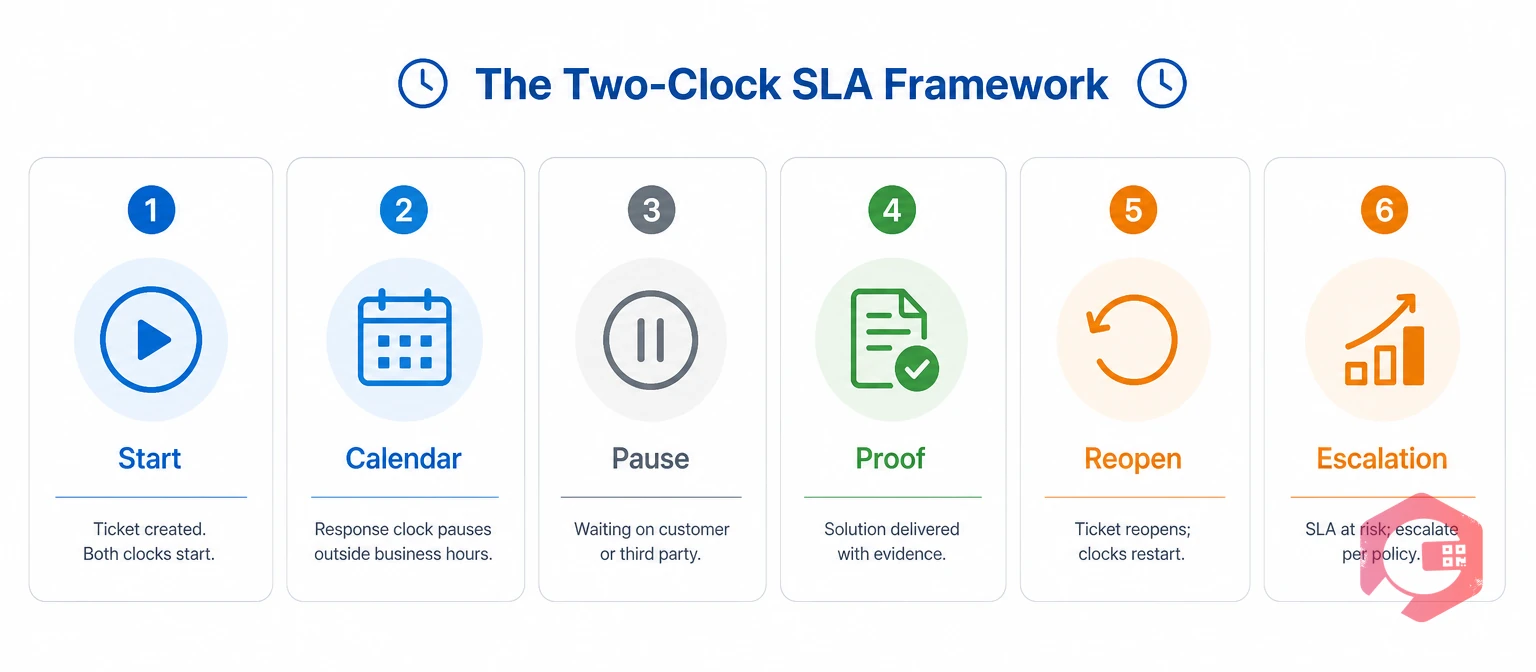

The two-clock SLA framework six contract clock rules for maintenance contractors | Cryotos

Clear clock rules prevent most response vs resolution disputes. Write them into the contract and set up the same rules in your maintenance system, so both sides calculate the same number.

The Two-Clock SLA Framework:

  • Start rule: Both clocks start when the request is logged in the system, not when someone phones the contractor.
  • Calendar rule: P1 and P2 run on 24x7 clocks; P3 and P4 run on business hours, with site holidays and time zone defined.
  • Pause rule: The clock stops only for client-caused delays, such as access denied, quote approval, or a permit-to-work hold, and each pause needs a reason and timestamp.
  • Proof rule: Resolution needs the asset running to spec, a completed checklist, and client sign-off within an agreed window.
  • Reopen rule: The same fault on the same asset within 7 to 14 days reopens the original job and its clock.
  • Escalation rule: Alerts go out at 50% and 80% of the target, with escalation to contractor management at breach.

What Should Never Stop the Clock

Contractor-sourced parts, technician availability, and travel time stay on the contractor's clock. If the contract allows these as pauses, the resolution target means very little.

Six written rules turn a vague SLA into one that both sides can measure and trust.

How to Measure Contractor SLA Compliance

Report response vs resolution compliance separately, by priority and by contractor, every month. One blended number hides where the problem sits.

SLA compliance is the share of jobs closed within target: jobs within target divided by total jobs in the period, times 100. Effective elapsed time is the stop time minus the start time, minus any approved pause time.

  • Response compliance: Aim for 95% or higher on P1 and P2 jobs.
  • Resolution compliance: Aim for 90% or higher on P1 and P2 jobs.
  • Mean time to repair: Track the trend by contractor and asset class.
  • First-time fix rate: Aim for 80% or higher, since repeat visits signal poor diagnosis or missing parts.
  • Reopen rate: Keep it at 5% or lower to confirm jobs are truly resolved.
  • Pause ratio: Review how much time sits on hold, because heavy pausing often hides slow work.

Service credits usually scale with how far a contractor falls below target, with a monthly cap. A maintenance KPI dashboard lets you review these numbers from live data instead of a month-end spreadsheet.

Separate response and resolution reports show exactly which contractor, priority, or site needs attention.

Common Mistakes in Contractor SLA Management

The most common mistake is running SLAs on phone calls, WhatsApp chats, and paper job sheets. When timestamps live in five places, nobody can prove what happened.

  • No single start time: The logged time is whenever someone gets round to typing up the request.
  • Self-reported arrival: Contractors fill in attendance times on paper, often after the fact.
  • Closure mistaken for resolution: Jobs close when the technician leaves, not when the asset is verified.
  • Untracked pauses: "Waiting for parts" is claimed verbally and can't be audited.
  • Late escalation: Managers learn about a breach only after it happens.

Each of these is a process gap, not a contractor problem, and it blurs the response vs resolution picture. Each one closes once the SLA clocks run inside one shared system.

How Cryotos Tracks Response and Resolution Time

Cryotos turns each SLA clock event into a system timestamp on the work order. Your team and your contractors see the same record, so compliance comes from data, not memory.

  • One start time: Requests raised by QR code scan, web portal, or mobile app are time-stamped on submission.
  • Priority-based targets: Priority and asset criticality sit on the work order, so the right target applies automatically.
  • Time-stamped status changes: Accept, start, on hold, and complete are logged from the mobile app, even offline.
  • Auditable pauses: On-hold status carries a reason, so only approved pauses come off the clock.
  • Verified closure: Mandatory maintenance checklists, photos, and digital signatures confirm resolution.
  • Early alerts: Email and WhatsApp notifications warn supervisors before a target is breached.

Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. Much of that comes from seeing a slipping job while there's still time to act.

With work order management as the single source of truth, the monthly SLA review becomes a report you open, not a dispute you settle.

Frequently Asked Questions

What does response vs resolution mean in a maintenance SLA?

Response time is how long a contractor takes to start working on a logged fault. Resolution time is how long it takes to fix the fault and have the job verified closed. Strong SLAs set separate targets for each, by priority.

What is a good response time for a critical maintenance failure?

Most contracts set a 30-minute to 1-hour response for P1 critical failures, with 24x7 coverage. Restoration within 4 hours and a permanent fix within 24 hours are common resolution targets for the same priority.

When should the SLA clock be paused for a contractor?

Pause the clock only for delays the client causes, such as denied site access, waiting for quote approval, or a permit-to-work hold. Each pause needs a recorded reason and timestamp. Contractor-sourced parts and travel time should stay on the clock.

How do I stop contractors from closing jobs before the fault is fixed?

Require a completed checklist, photos, and client sign-off before a job counts as resolved. Add a reopen rule, so the same fault on the same asset within 7 to 14 days reopens the original job and its clock.

Can a CMMS track contractor SLA compliance automatically?

Yes. A CMMS time-stamps each stage of a work order, applies targets by priority, and sends alerts before a breach. It then reports response and resolution compliance by contractor without manual spreadsheets.
