Maintenance Planner vs Scheduler: What Each Role Should (and Shouldn't) Do

Calendar
Duration:
9 min read
calendar today
Published on
June 11, 2026
Featured Image

A maintenance planner and a maintenance scheduler are two distinct roles in a preventive maintenance programme, and confusing them is one of the most common reasons maintenance teams underperform. The planner prepares the work — defining scope, gathering parts, writing instructions, and estimating labour. The scheduler coordinates execution — assigning technicians, sequencing jobs, managing windows, and communicating timing to production. Both roles are essential, and when one person tries to do both without clear boundaries, both suffer.

According to a study by the Reliable Plant, facilities with dedicated planning and scheduling functions report 20–25% higher wrench time than those running combined or informal roles. This guide breaks down each role's responsibilities clearly — including what each role should never do — so you can structure your maintenance team for maximum output.

What Is a Maintenance Planner?

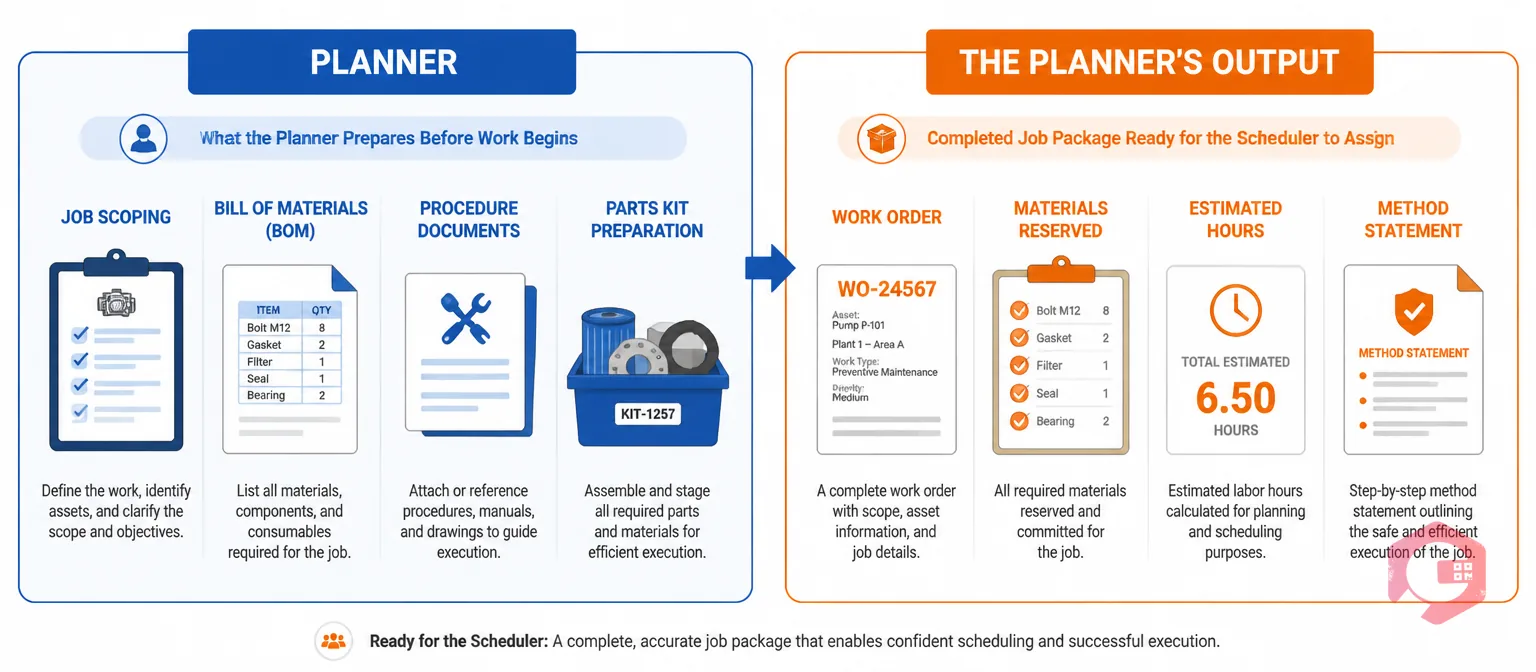

What is a maintenance planner - role and output concept illustration | Cryotos

A maintenance planner is responsible for preparing maintenance work so that technicians can execute it efficiently and completely the first time. The planner answers the question: what needs to be done, and what is needed to do it?

Planners work ahead of execution — typically one to three weeks out. They review work order backlogs, scope each job, identify the tools, parts, permits, and skills required, and write step-by-step job plans. A good planner removes every obstacle that would cause a technician to stop, wait, or improvise mid-job.

In facilities with formal work order management systems, planners are also the custodians of job plan libraries — building reusable templates that improve every time the same task is completed. They capture feedback from technicians after each job and update plans with better instructions, corrected parts lists, or revised time estimates.

What Is a Maintenance Scheduler?

A maintenance scheduler is responsible for coordinating when and by whom approved, planned work gets executed. The scheduler answers the question: who does this, when, and in what order?

Schedulers work in a shorter time horizon — typically one to two weeks, with a specific focus on the weekly and daily schedule. They take planned work orders from the planner's queue and match them to available technicians, open production windows, and parts availability. They sequence jobs to maximise efficiency, minimise travel time, and reduce unnecessary machine downtime.

Schedulers are the primary communication link between maintenance and operations. They negotiate shutdown windows with production supervisors, manage crew capacity across shifts, and adjust the schedule in real time as priorities change or emergencies arise. In facilities using a preventive maintenance software platform, schedulers often manage the scheduling board, capacity views, and daily dispatch lists.

Maintenance Planner vs Scheduler: Key Differences

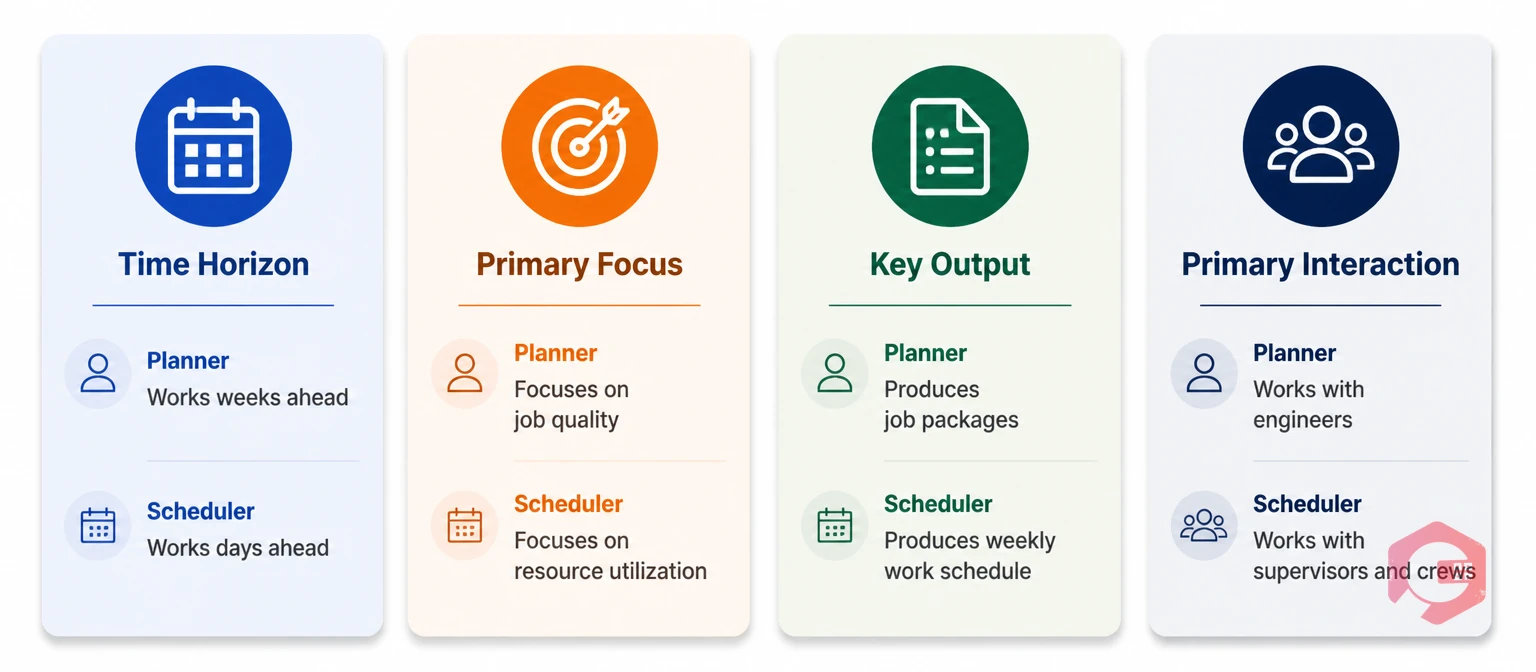

Maintenance planner vs scheduler key differences - 4 comparison cards | Cryotos

The clearest way to understand the distinction is to look at both roles across common dimensions. Here is a structured comparison:

DimensionMaintenance PlannerMaintenance Scheduler
Primary questionWhat needs to be done and what is needed?Who does it, when, and in what order?
Time horizon1–3 weeks ahead1–2 weeks, daily focus
OutputJob plans, parts kits, permit lists, work packagesWeekly schedule, daily dispatch list, crew assignments
Primary data sourceWork order backlog, asset history, OEM manualsTechnician availability, production schedule, parts status
Key relationshipTechnicians (job quality feedback)Production supervisors (timing and access)
Success metricJob plan quality, first-time completion rateSchedule compliance rate, wrench time
Reactive work involvementPlans emergency work packages after the factManages crew reallocation in real time

What a Maintenance Planner Should Do

The planner's value is in preparation quality. Every hour a planner spends on a thorough job plan typically saves two to four hours of technician time on the floor. Here is what planners should own:

  • Scope every work order before it enters the schedule: Review each new work order, visit the asset if needed, and define the full scope of work — what exactly needs to be done, what the acceptance criteria are, and what special conditions apply (confined space, hot work, LOTO requirements).
  • Build and maintain job plan libraries: Create reusable, step-by-step job plans for recurring tasks. Use technician feedback after each job to refine instructions, correct parts lists, and update time estimates. A job plan library built over 12 months becomes one of a maintenance team's most valuable assets.
  • Identify and reserve all required materials: Determine every part, consumable, tool, and piece of test equipment needed. Coordinate with the storeroom to confirm availability and reserve or procure items before the job enters the schedule. A job should never reach a technician with parts still outstanding.
  • Estimate labour accurately: Define the skill type, crew size, and estimated hours for each job. Accurate estimates allow the scheduler to load capacity without overloading crews or leaving gaps.
  • Manage permits and access requirements: Identify which jobs require permits to work, LOTO procedures, confined space entry, or working-at-height permits. Complete the advance paperwork so execution is not delayed by safety admin on the day.
  • Manage the ready-to-schedule backlog: Maintain a clean, prioritised queue of fully planned work orders. Flag any job that cannot be fully planned due to missing information, parts on long lead times, or access constraints.

What a Maintenance Planner Should NOT Do

Planners are most effective when they stay out of execution. Crossing these lines reduces planning quality and confuses accountability.

  • Not supervise technicians in the field: The planner's job ends when the job plan is handed to the scheduler. Planners who follow technicians around, redirect work mid-job, or act as field supervisors undermine both roles. Supervision belongs to the maintenance supervisor or team leader.
  • Not assign work orders to technicians: Assigning specific people to specific jobs is scheduling, not planning. Planners hand ready-to-schedule work to the scheduler; they do not decide who does what or when.
  • Not react to daily emergencies: Planners who spend their day responding to breakdowns stop building the backlog of planned work that makes the whole system work. Emergency response is the scheduler's (and supervisor's) domain. Planners focus on preparing future work.
  • Not skip the asset visit to save time: Planners who write job plans from memory or old records without verifying current asset condition generate inaccurate plans that waste technician time. Visit the asset before writing the plan — especially for complex or infrequent jobs.
  • Not approve or prioritise work orders unilaterally: Work order priority and approval are management decisions. Planners provide input (scope, estimated cost, risk level) but should not set priorities on their own authority.

What a Maintenance Scheduler Should Do

The scheduler's value is in maximising the productive output of the maintenance crew. A skilled scheduler ensures that technicians always have approved, fully planned work ready to execute — and that production never loses access to assets longer than agreed. Here is what schedulers should own:

  • Build the weekly schedule from the ready-to-schedule backlog: Each week, pull fully planned work orders and build a schedule that loads technicians to approximately 90% of available capacity (leaving 10% for reactive work and schedule slippage). Use the wrench time calculator to benchmark crew utilisation.
  • Coordinate access windows with production: Negotiate with production supervisors to secure the machine downtime and area access needed for each planned job. Confirm windows in advance and protect them from ad-hoc requests wherever possible.
  • Match jobs to technician skills and certifications: Assign work orders based on the skill requirements the planner defined. Never assign electrical work to an uncertified technician to save time, or give complex jobs to a crew without the right training.
  • Manage crew capacity across shifts: Track absences, overtime limits, and cross-shift dependencies. Adjust the schedule proactively when capacity changes rather than leaving gaps that erode wrench time.
  • Conduct the weekly schedule review meeting: Facilitate the weekly planning meeting with maintenance supervisors, operations representatives, and the planner. Lock the schedule for the week ahead, confirm parts availability and access windows, and document any carryover work.
  • Track and report schedule compliance: Measure what percentage of the scheduled work was completed on time each week. Report compliance trends to maintenance management and use low compliance periods to identify systematic barriers — not to blame individuals.

What a Maintenance Scheduler Should NOT Do

Schedulers operate in the short term. Overstepping into planning or supervision creates gaps in both functions.

  • Not write job plans: If a planner's work order lacks a complete job plan, the scheduler should send it back to planning — not improvise instructions or forward an incomplete package to a technician. Poorly planned jobs derail schedules.
  • Not ignore parts availability before building the schedule: Scheduling a job before its parts are confirmed in stock is one of the most common sources of wasted wrench time. Always verify parts status before locking a job into the weekly schedule.
  • Not overload crews to clear the backlog faster: Loading technicians beyond sustainable capacity leads to rushed work, safety incidents, and higher rework rates. Schedule to achievable capacity; reduce the backlog through systematic planned work, not by burning out the crew.
  • Not make unilateral decisions on priority changes: When production requests a priority change mid-week, the scheduler facilitates the discussion between maintenance management and production — they do not decide unilaterally which job gets dropped or delayed.
  • Not schedule unplanned work into prime planned slots: Reactive work orders that haven't gone through planning should not displace planned, packaged jobs in the schedule without deliberate management sign-off. Normalising this practice collapses the planning function over time.

When One Person Does Both Roles

In smaller facilities with five to fifteen technicians, having a dedicated planner and a dedicated scheduler is often not economically practical. One person frequently covers both functions — and this can work, but only with strict discipline about keeping the two mindsets separate.

The most common failure mode is that the combined planner-scheduler spends all their time reacting to the week's schedule (the scheduler mindset) and never builds the backlog of planned work (the planner mindset). Within a few months, unplanned work dominates the schedule, wrench time drops, and the team is effectively reactive.

If you run a combined role, protect planning time explicitly. Block two to four hours per day as planning-only time — no schedule adjustments, no emergency calls. Use this time to scope new work orders, build job plans, and manage the ready backlog. Many facilities use the morning for planning and the afternoon for scheduling coordination.

A maintenance management software platform makes the combined role more manageable by automating routine scheduling tasks — generating PMs on schedule, surfacing the ready-to-schedule queue, and tracking parts availability — so the planner-scheduler can focus on judgement rather than administration.

How CMMS Software Supports Both Roles

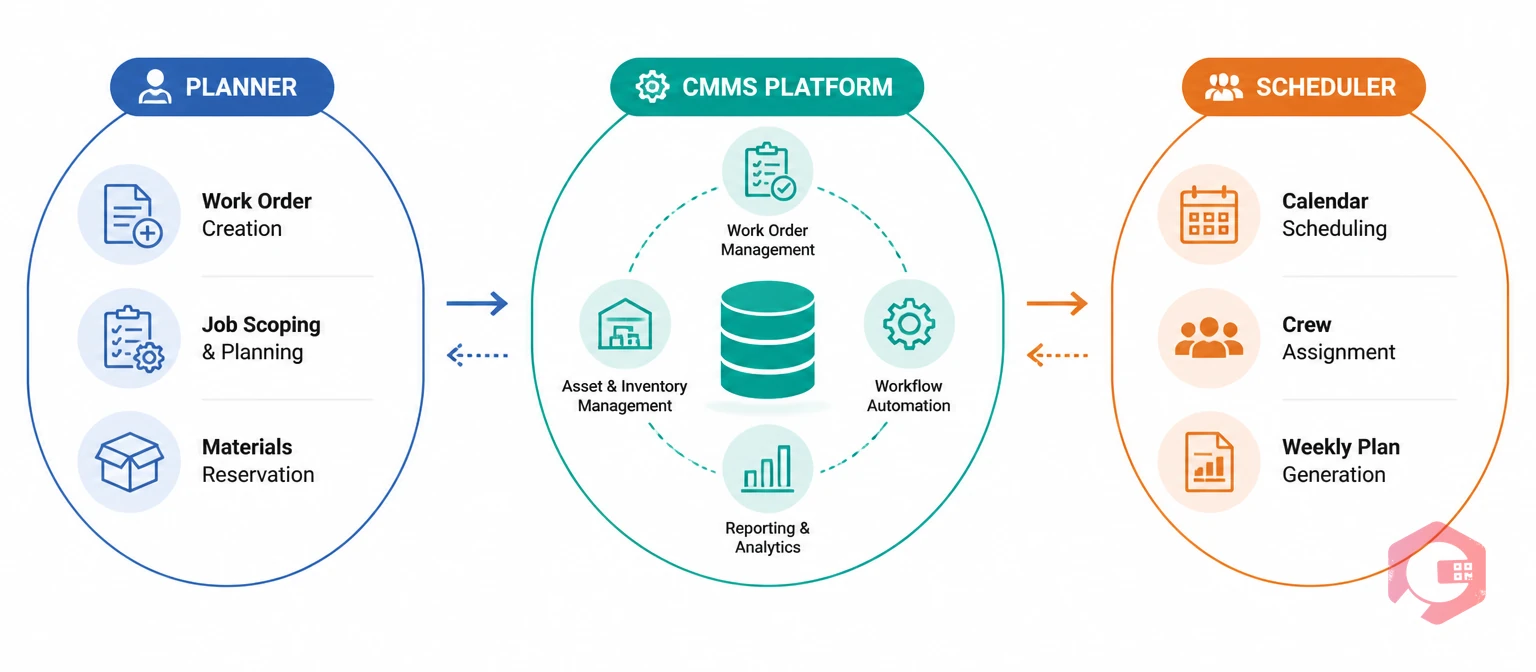

How CMMS software supports maintenance planner and scheduler roles | Cryotos

A CMMS does not replace planners or schedulers — it gives both roles the data and tools they need to do their jobs more effectively. Here is how a well-configured work order management system supports each function:

For the planner, a CMMS provides complete asset history so job plans are based on actual failure patterns rather than guesswork. It stores job plan libraries and makes them reusable across similar assets. It links parts requirements directly to work orders, with real-time visibility into storeroom stock. Cryotos's maintenance checklists allow planners to build step-by-step inspection and repair procedures that technicians complete on mobile — with numeric readings, photos, and sign-off fields built in. After each job closes, the planner can review technician notes and update the job plan immediately.

For the scheduler, a CMMS provides real-time visibility into technician availability, open work order status, and preventive maintenance due dates. Cryotos's drag-and-drop PM scheduling calendar gives schedulers a visual tool for building the weekly plan without manual spreadsheet work. Automated WhatsApp and email notifications keep technicians and production supervisors informed of schedule changes without the scheduler manually contacting each person. The BI dashboard tracks schedule compliance, wrench time, and backlog size in real time — giving schedulers the KPI data they need to improve week over week.

According to Reliability Engineering resources, organisations that digitise their planning and scheduling workflow report 15–20% improvements in planned maintenance percentage (PMP) within the first year. Cryotos customers have reported a 30% reduction in unplanned downtime and 25% faster repair times, outcomes that depend directly on strong planning and scheduling discipline supported by the right platform.

Frequently Asked Questions

What is the main difference between a maintenance planner and a maintenance scheduler?

The planner prepares the work — scoping jobs, writing instructions, identifying parts, and managing permits. The scheduler coordinates execution — assigning technicians, securing production windows, and sequencing jobs. Planners work two to three weeks ahead; schedulers focus on the current week and daily dispatch.

Can a maintenance planner also be the scheduler?

Yes, in smaller facilities one person often covers both roles. The key is to protect dedicated time for each function. Without explicit planning time blocked on the calendar, the scheduling demands of the current week will crowd out the preparation work that prevents next week's problems.

What metrics should a maintenance planner be measured on?

Key planner metrics include job plan quality (measured by rework rate and technician feedback), first-time completion rate, percentage of work orders fully planned before scheduling, and parts availability rate at job start. Measuring planners on schedule compliance is a mistake — that is the scheduler's metric.

What is a good schedule compliance rate for maintenance?

World-class maintenance organisations target 90% or higher schedule compliance. A rate below 75% consistently indicates systematic problems — either too much reactive work overwhelming the schedule, inaccurate job plans generating delays, or parts not confirmed before jobs are scheduled.

How does CMMS software help maintenance planners and schedulers?

A CMMS gives planners access to complete asset history, job plan libraries, and real-time parts availability. It gives schedulers a visual scheduling board, automated PM generation, and live capacity views. Together, these tools reduce the administrative burden on both roles and give them the data needed to make better decisions — replacing manual spreadsheets with a single source of truth for all planned maintenance work.

What happens when planning and scheduling roles are not separated?

When the boundaries are unclear, reactive work tends to dominate. The person nominally covering both roles spends their day on today's schedule and emergencies, never building the backlog of planned work. Over time, unplanned maintenance percentage climbs, wrench time drops, and the maintenance team becomes permanently reactive — addressing failures rather than preventing them.
