Construction Site HSE Audits: Integrating Safety, Asset Inspections, and Maintenance Compliance

Calendar
Duration:
18 min
calendar today
Published on
October 7, 2026
Featured Image

A construction site HSE audit is a structured review of how well a project controls health, safety, and environmental risks. It measures the site against the law, client rules, and standards such as ISO 45001. The best audits go further than PPE and signage. They also confirm that cranes, scaffolds, excavators, and generators are inspected, maintained, and documented on schedule.

That last part is where many sites fall short. Equipment failure sits behind a large share of serious site incidents, yet maintenance records often live apart from safety findings. This guide shows you how to run construction site HSE audits that join safety checks, asset inspections, and maintenance compliance into one process. You'll get a 7-step method, a scorecard template, and the SAFER Site Audit Framework.

Key Takeaways

  • Integration matters: An HSE audit that skips equipment inspection and maintenance records misses the root cause behind many struck-by, caught-in, and electrocution incidents.
  • SAFER framework: Scope, Assess, Fix, Evidence, and Review give you one repeatable loop for safety and maintenance compliance.
  • Risk over volume: Score findings by severity and likelihood, then track every finding to closure with an owner and a deadline.
  • Digital wins on evidence: Mobile checklists, QR codes, and linked work orders turn findings into a record that holds up with clients and regulators.

What Is a Construction Site HSE Audit?

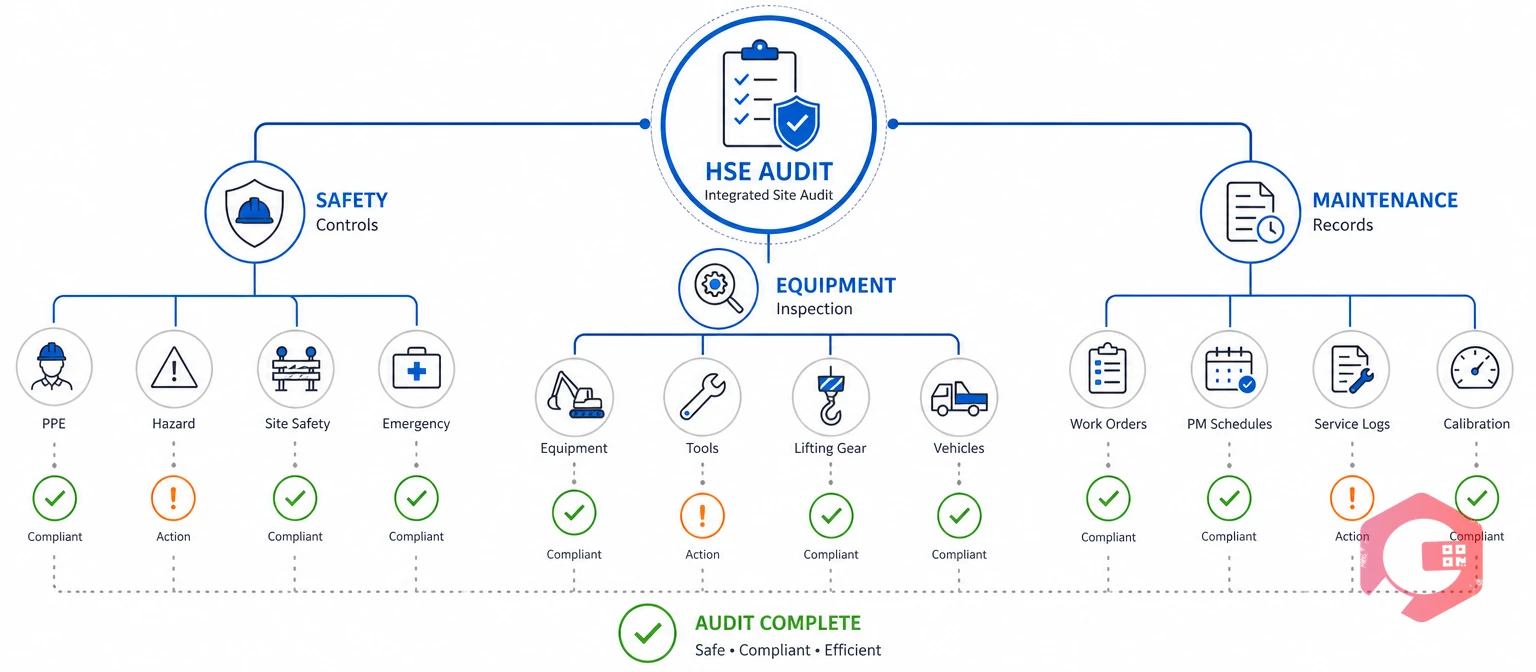

What a construction site HSE audit integrates | Cryotos

A construction site HSE audit is a documented review of how a project manages HSE risk against set criteria. Those criteria usually include national law, the client's contract terms, the contractor's own HSE management system, and international standards.

In the US, the legal anchor is the federal construction standard, 29 CFR 1926, which OSHA enforces on construction sites. Globally, most contractors align their management systems with ISO 45001 for occupational health and safety and ISO 14001 for environmental management.

How an HSE audit differs from a daily site inspection

  • Daily inspection: A quick check of current conditions, such as a missing guardrail or a blocked exit. A supervisor usually does it at the start of a shift.
  • HSE audit: A deeper review of whether the whole system works, including training, permits, equipment records, contractor control, and how fast past findings were closed.
  • Scope: An inspection asks "Is this safe right now?" while an audit asks "Will this stay safe next month, and can we prove it?"

An asset inspection is a recorded check of one piece of equipment against a defined checklist, signed by a competent person. On a construction site, these records are the evidence auditors need to confirm that plant and tools are fit for use. A sound audit treats them as core HSE evidence, not as a separate maintenance matter.

Why Safety and Maintenance Compliance Belong in One Audit

Safety and maintenance compliance belong in one audit for a simple reason. Many serious site incidents start with equipment that was overdue for inspection or repair. OSHA's "Focus Four" hazards on construction sites are falls, struck-by, caught-in or between, and electrocution. Fall protection has topped OSHA's list of most-cited standards for more than a decade.

Look closely and most of these hazards have a maintenance link. Here are common ways a missed inspection becomes a safety incident:

  • Struck-by: An excavator with an overdue brake service or a faulty reversing alarm strikes a worker on foot.
  • Caught-in or between: A worn guard on a concrete mixer or a failed hydraulic hose on a loader traps a hand or limb.
  • Falls: A scaffold keeps its green tag after a storm, even though nobody re-inspected the ties and base plates.
  • Electrocution: A site generator runs for months without an earth continuity test or a working ground-fault breaker.
  • Dropped loads: A crane works past its annual inspection date, or lifting slings carry no current inspection tag.

The cost of keeping safety and maintenance data apart

Most sites keep safety findings in an HSE spreadsheet. Equipment records sit in a plant manager's binder or a rental company's portal. When an auditor asks, "Show me that every crane on site has a current inspection," the team spends hours chasing paper. Gaps hide in the space between those two systems.

A Computerized Maintenance Management System (CMMS) closes that gap by holding asset registers, inspection checklists, and work orders in one place. When the data sits together, one construction site HSE audit can answer two questions in the same walk. Is the work safe? Is the equipment fit for use?

Types of HSE Audits on Construction Sites

Construction sites use five main types of HSE audits, and each answers a different question. Most projects run several types at once, on different schedules.

Internal audits run by the contractor's own team

Your HSE team or a senior site manager checks the project against company procedures, usually monthly or quarterly. Internal audits catch drift early, before a client or regulator finds it.

External audits by clients and certification bodies

Clients audit contractors to confirm contract HSE terms are met. Certification bodies audit against ISO 45001 or ISO 14001 to grant or renew certification, often once a year with surveillance visits in between.

Regulatory compliance audits and agency inspections

These reviews confirm that the site meets local law. Examples include OSHA 29 CFR 1926 in the US and the CDM Regulations in the UK. Many contractors run a mock regulatory audit before major milestones so there are no surprises.

Equipment, plant, and maintenance compliance audits

This audit focuses on plant and tools: inspection dates, statutory examinations, operator certificates, and open defects. It is often the weakest link on busy sites, which is why the SAFER framework below folds it into every audit cycle.

Behavioral safety audits and leadership site walks

Observers watch how people work, not just what the paperwork says. These audits spot shortcuts, such as skipped lockout steps or missing spotters, that never show up in a document review. The audit type sets the scope, but the evidence standard stays the same: every finding needs proof, an owner, and a deadline.

Want a ready-made starting point? Use our free safety compliance checklist to structure your next site audit.

What a Construction Site HSE Audit Should Cover

A complete construction site HSE audit covers six areas. They are work at height, plant, electrical safety, health, the environment, and documents. Use the lists below as the backbone of your audit checklist.

Site safety controls and working at height

  • Fall protection: Guardrails, edge protection, covers over openings, and harness anchor points are in place and inspected.
  • Scaffolds: Each scaffold has a current tag, an inspection within the last seven days, and a re-check after any storm or change.
  • Ladders and MEWPs: Ladders are tagged and in good repair, and mobile elevating work platforms have current pre-use checks.
  • Traffic management: Pedestrian routes are separated from plant routes, and banksmen or spotters are present where needed.

Plant, equipment, and lifting operations on site

  • Asset register: Every item of plant on site is listed, including rented equipment, with its owner and inspection due dates.
  • Pre-use checks: Operators complete and sign daily checks before starting excavators, loaders, telehandlers, and dumpers.
  • Lifting equipment: Cranes, hoists, slings, and shackles carry current thorough examination or inspection records.
  • Isolation: Maintenance on plant follows a written lockout tagout procedure, with locks and tags available on site.
  • Defect reporting: Faulty equipment is tagged out of service, and the defect is logged with a repair deadline.

Electrical safety and temporary power systems

  • Temporary supplies: Distribution boards are locked, labeled, and protected by ground-fault breakers.
  • Portable tools: Power tools and leads carry current test tags and show no visible damage.
  • Generators: Earthing, fuel storage, and service intervals are recorded and current.
  • Overhead and buried services: Live lines are marked, and permits are in place before any digging.

Health, hygiene, and occupational exposure controls

  • Dust and silica: Water suppression or on-tool extraction is used for cutting, and extraction units are maintained.
  • Noise and vibration: Exposure is assessed, hearing protection is worn, and tool vibration ratings are known.
  • Welfare: Toilets, wash stations, drinking water, and rest areas are clean and adequate for the workforce.

Environmental controls, waste, and spill management

  • Spill readiness: Spill kits sit near fuel and chemical stores, and plant has drip trays where needed.
  • Waste: Waste is segregated, stored safely, and removed by licensed carriers with transfer records.
  • Water and dust: Silt fences, wheel washes, and dust controls work and are checked after rain.

Documentation, permits, competence, and training records

  • Permits: Hot work, confined space, excavation, and electrical permits are issued, signed, and closed. A permit to work software system makes this trail far easier to audit.
  • Competence: Operator licenses, crane certifications, and first-aid cards are current for everyone on site.
  • Risk assessments: Method statements match the work actually happening today, not last month's plan.

Cover all six areas in every audit cycle, even if you rotate how deep you go in each one.

The SAFER Site Audit Framework for Integrated Compliance

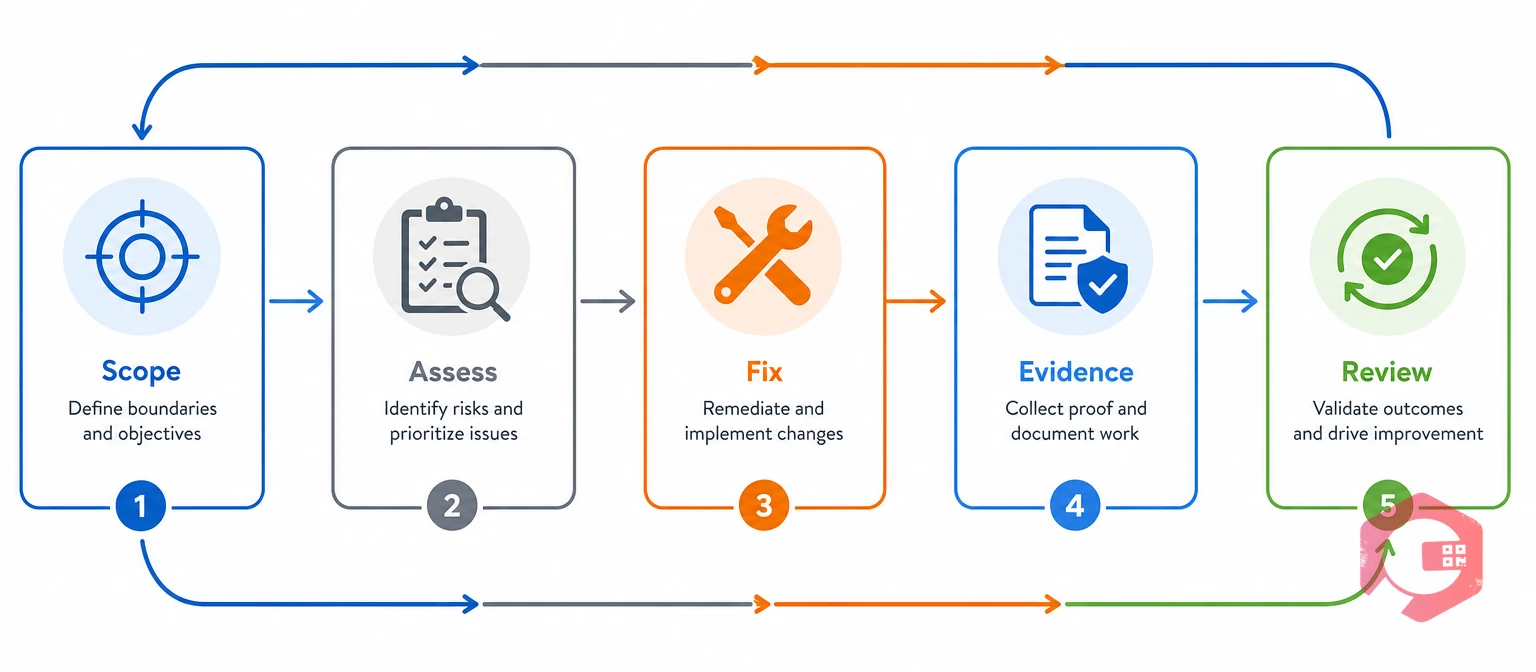

The SAFER site audit framework five-stage loop | Cryotos

The SAFER Site Audit Framework is a five-stage loop. It joins safety checks, asset inspections, and maintenance actions into one audit process. It gives your team a shared method, so HSE managers and plant managers stop working from separate lists.

The SAFER Site Audit Framework:

  • Scope: Map each high-risk activity to the assets it depends on, such as "tower crane lift" to the crane, its slings, and its operator certificate.
  • Assess: Inspect people, conditions, and equipment in the same site walk, using mobile checklists tied to each asset.
  • Fix: Turn every finding into a work order or corrective action with an owner, a priority, and a due date.
  • Evidence: Capture photos, signatures, timestamps, and closure notes so every claim in the audit report can be proven.
  • Review: Track repeat findings and overdue actions, then adjust inspection frequencies and training where the data points.

How the SAFER framework works on a live project

Picture a mid-sized building project with two tower cranes, six excavators, and a fleet of rented generators. Under SAFER, the auditor scans each crane's QR code, sees its last inspection, and flags a sling that is two days overdue. The finding becomes a work order for the lifting supervisor, due before the next lift.

  • Before SAFER: The overdue sling sits in a plant spreadsheet that the HSE auditor never opens.
  • With SAFER: The sling is quarantined, re-inspected, and closed out with a photo the same day.
  • At the next audit: Review data shows sling inspections slip on Mondays, so the team moves them to Friday afternoons.

Real-time asset tracking makes the Scope and Assess stages much faster, because you always know which equipment is on site and where. Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. The same habits shorten the time between an audit finding and a safe fix.

SAFER works because it treats a missed inspection as a safety finding, not a paperwork issue.

How to Conduct a Construction Site HSE Audit in 7 Steps

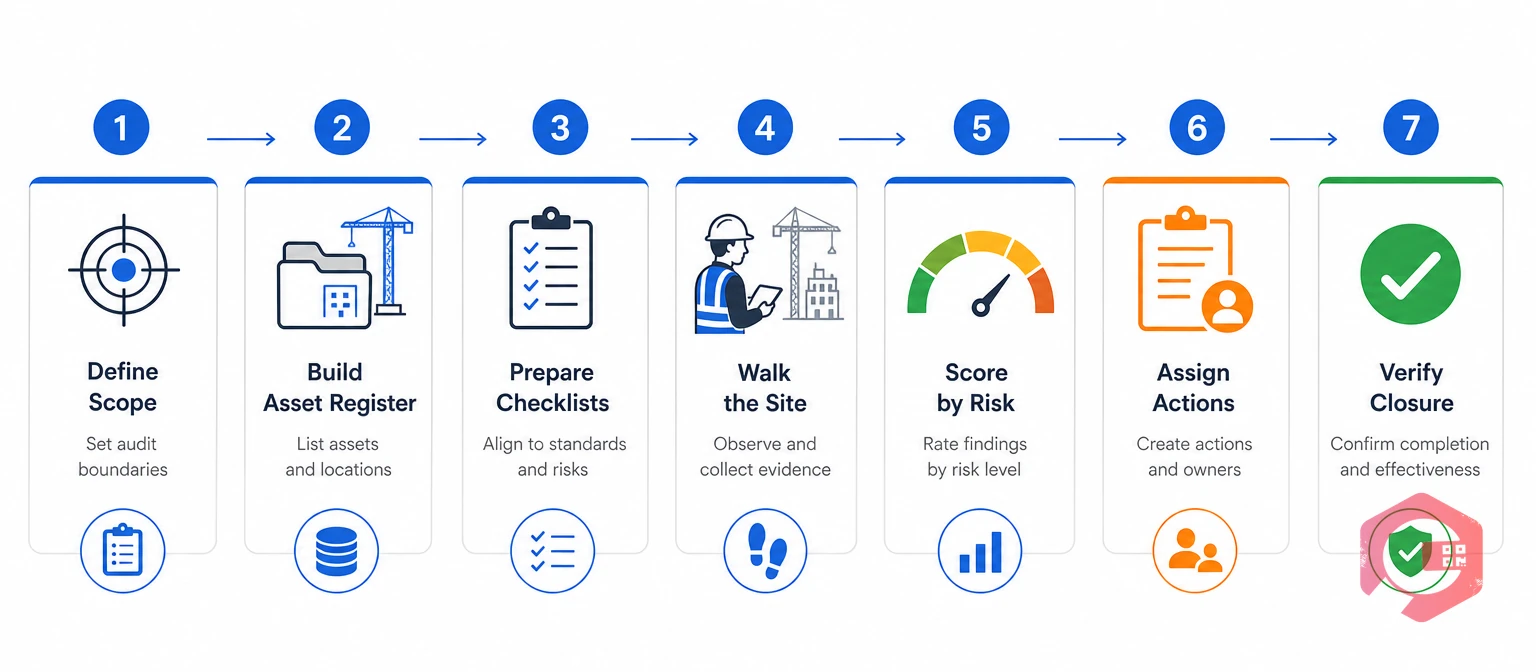

Seven steps to conduct a construction site HSE audit | Cryotos

You can conduct a construction site HSE audit in seven steps. Define the scope, build the asset register, and prepare linked checklists. Then walk the site, score by risk, assign actions, and verify closure. Each step below includes what to do and what to avoid.

Step 1: Define the audit scope, criteria, and team

Decide which areas, contractors, and work phases the audit will cover. List the criteria you'll audit against, such as OSHA 29 CFR 1926, the client's HSE plan, and ISO 45001 clauses.

  • Team: Pair an HSE auditor with someone who knows plant and equipment, such as the plant manager or a lead mechanic.
  • Independence: Avoid having supervisors audit their own work areas.

Step 2: Build the asset register before you walk

Pull a current list of all plant, lifting gear, and power equipment on site. Include rented and subcontractor equipment. Note the last inspection date, next due date, and any open defects for each asset.

This step alone often reveals the biggest gaps, such as rented equipment that arrived without inspection certificates.

Step 3: Prepare checklists that link hazards to assets

Build checklists where each hazard question points to the asset it depends on. For example, "Is the excavation protected?" should link to the shoring equipment and its last inspection.

  • Keep questions specific: "Is the scaffold tag dated within seven days?" beats "Is scaffolding safe?"
  • Go digital: Digital maintenance checklists let you attach photos and signatures to each answer on a phone or tablet.

Step 4: Walk the site and gather objective evidence

Observe work in progress, interview workers, and check records at the point of use. An operator's daily check sheet in the cab tells you more than a clean folder in the site office.

  • Photograph everything: Capture both good practice and findings, with timestamps.
  • Talk to operators: Ask how they report defects and how long fixes usually take.
  • Check tags in person: Confirm that inspection tags on equipment match the dates in the register.

Step 5: Score each finding by risk, not by count

Rate each finding on severity and likelihood, using a simple 1-to-5 scale for each. A single overdue crane inspection outweighs ten untidy walkways, so your report should say so.

  • Critical: Stop the work or quarantine the equipment immediately.
  • High: Fix within 24 to 48 hours.
  • Medium or low: Fix within a set window, usually 7 to 30 days.

Step 6: Convert every finding into a tracked action

Every finding needs an owner, a due date, and a closure standard. Findings left in a PDF report rarely get fixed on time.

Raising digital work orders for equipment findings sends the task straight to the mechanic or rental firm. Photos stay attached, and everyone can see the deadline.

Step 7: Verify closure and report trends to leadership

Check that each action was completed and that the fix actually worked. Close findings only with evidence, such as a photo, a new inspection record, or a signed sign-off.

  • Report trends: Show leadership repeat findings, overdue actions, and the riskiest assets.
  • Feed the next audit: Use this cycle's weak spots to set the scope of the next one.

A construction site HSE audit only creates value when its findings are closed, verified, and used to improve the next cycle.

Construction Site HSE Audit Scorecard Template

A construction site HSE audit scorecard records each check, the evidence needed, its risk rating, and who owns the fix. Use the sample below as a starting template and adapt the rows to your project.

Audit AreaCheck ItemEvidence RequiredRisk RatingOwnerClose-Out Target
Work at heightScaffold tags dated within 7 daysTag photo + inspection recordHighScaffold supervisor24 hours
LiftingCrane annual inspection currentInspection certificateCriticalLifting coordinatorBefore next lift
LiftingSlings and shackles taggedColor-code tag + register entryHighRigging leadSame shift
PlantExcavator daily checks signedSigned pre-use checklistMediumPlant operatorDaily
PlantBrake and alarm service on scheduleClosed PM work orderHighPlant manager48 hours
ElectricalGround-fault breakers testedTest record with dateHighSite electrician24 hours
EnvironmentalSpill kits stocked near fuelPhoto + stock checkMediumEnvironmental officer7 days
DocumentationHot work permits closedSigned permit with fire watchHighPermit issuerEnd of shift

Score each row on a simple scale: 2 for compliant, 1 for partly compliant, and 0 for non-compliant. Then work out a percentage for each audit area. Track that percentage over time so you can see whether each area is improving or slipping.

Paper vs Digital HSE Audits: A Practical Comparison

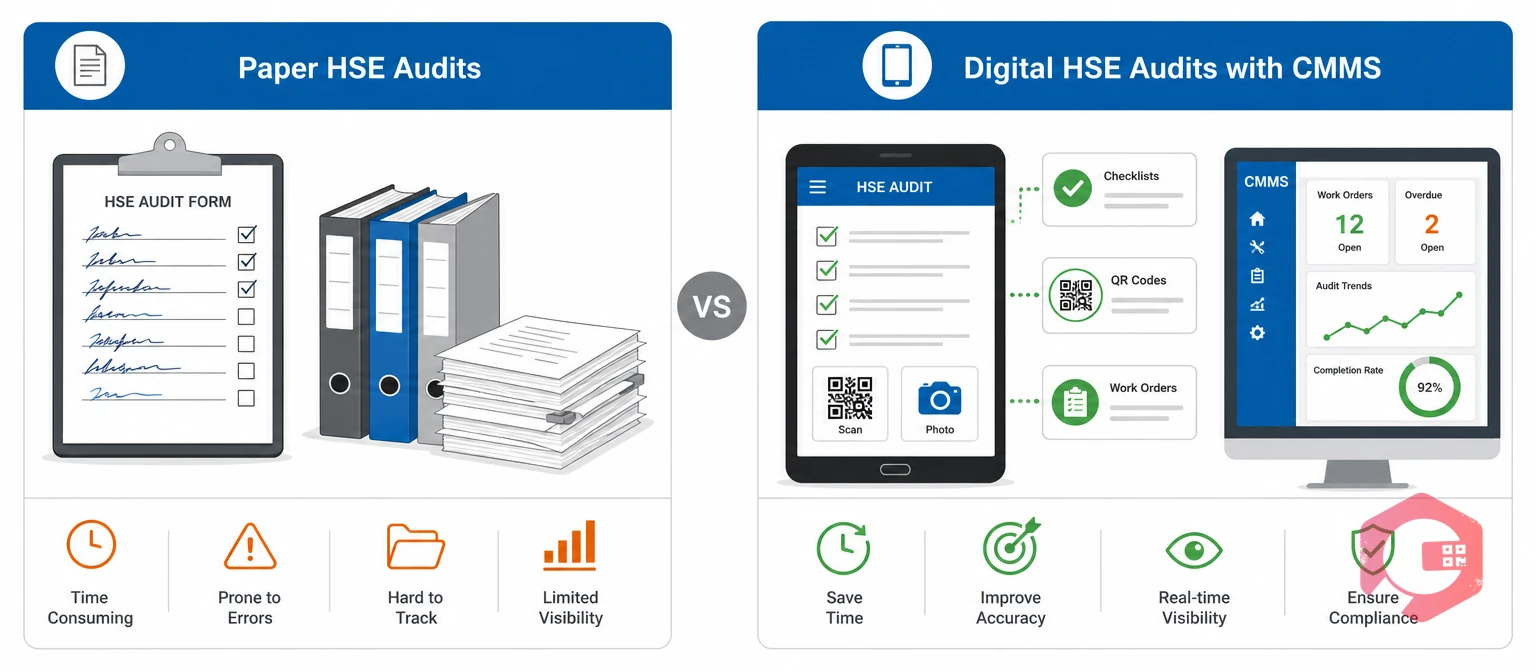

Paper versus digital HSE audits comparison | Cryotos

Digital HSE audits beat paper audits on speed, evidence, and follow-up. The main reason is that findings turn straight into tracked actions. Here is how the two approaches compare on a construction site.

FactorPaper and Spreadsheet AuditsDigital Audits with a CMMS
Data captureHandwritten notes, typed up laterMobile checklists with photos and signatures on the spot
Asset linkEquipment records kept in a separate fileQR code scan shows inspection history for each asset
Follow-upActions listed in a report, chased by emailFindings become work orders with owners and deadlines
Evidence trailEasy to lose, hard to searchTimestamped audit trail for every change
ReportingManual summaries that take daysLive dashboards for overdue actions and repeat findings
Remote sitesForms travel by hand or photoOffline mobile mode that syncs once a signal returns

Paper still works for very small jobs with a handful of assets. Once a project runs multiple contractors and a rented plant fleet, digital audits save hours per cycle and close the gaps that paper leaves open.

Common Mistakes That Weaken Construction Site HSE Audits

Three mistakes weaken construction site HSE audits most often. Teams leave equipment out of scope, audit paperwork instead of the work, and leave findings without owners. Teams that successfully avoid these mistakes usually share one habit: they audit what actually happens on site.

  • Leaving rented plant out of the audit: Rented and subcontractor equipment often makes up most of the fleet, yet its inspection records sit with someone else. Ask for them at mobilization, not after an incident.
  • Auditing the office, not the site: A neat permit file means little if the permit on the job doesn't match the work in progress.
  • Counting findings instead of weighing them: Fifty minor findings can hide one critical one. Always lead the report with risk.
  • No owner, no deadline: A common mistake is listing actions with "site team" as the owner. Name a person and a date for every one.
  • Closing findings without proof: "Done" in an email is not evidence. Require a photo or a new inspection record.
  • Ignoring repeat findings: The same finding in three audits in a row points to a system problem, such as an inspection interval that is too long.
  • Skipping leading indicators: Most sites track injuries, which lag. Track overdue inspections and open actions too, because they warn you before something goes wrong.

Fix these seven habits and your audits will catch real risk, not just missing paperwork.

KPIs to Track After Every Construction Site HSE Audit

Three KPIs matter most after a construction site HSE audit: action close-out rate, overdue inspections, and repeat findings. They show whether risk is going down. Pair them with lagging injury rates for a complete picture.

  • Action close-out rate: The percentage of audit actions closed by their due date. Many contractors aim for 90% or higher.
  • Overdue critical inspections: The number of cranes, scaffolds, and lifting accessories past their inspection date. The target here is zero.
  • Preventive maintenance compliance on critical plant: The share of scheduled services on high-risk equipment completed on time.
  • Repeat finding rate: How often the same issue appears in back-to-back audits. A rising rate signals a weak fix.
  • Audit score by area: The scorecard percentage for each area, tracked across audit cycles.
  • Total recordable incident rate: A lagging measure that should fall as the leading indicators improve.

A leading safety indicator is a measure that predicts future incidents, such as overdue inspections or open corrective actions. Lagging indicators, like injury rates, only tell you about harm that already happened. To keep legal requirements in view while you track these KPIs, work through our regulatory compliance checklist each quarter.

Watch these KPIs between audits, not just on audit day, so problems surface while they are still small.

Frequently Asked Questions

How often should a construction site HSE audit be carried out?

Most contractors run a full internal HSE audit monthly on active sites and a deeper system audit every quarter. High-risk phases, such as heavy lifting or deep excavation, may need audits every week. Daily and weekly inspections continue in between, and certification bodies audit once a year.

Who is qualified to conduct an HSE audit on a construction site?

A qualified HSE auditor should know the relevant law, the company's HSE management system, and construction methods. Many hold certifications such as NEBOSH, OSHA 500, or ISO 45001 lead auditor training. For equipment-heavy sites, pair the auditor with a plant or maintenance specialist.

What is the difference between an HSE audit and an HSE inspection?

An HSE inspection checks current site conditions, such as a missing guardrail, at a point in time. An HSE audit reviews whether the whole safety system works over time, including training, permits, equipment records, and how findings get closed. Inspections feed evidence into audits.

Why should equipment maintenance records be part of an HSE audit?

Many serious construction incidents, including struck-by, caught-in, and electrocution events, trace back to equipment that was overdue for inspection or repair. Checking maintenance records during the audit confirms that plant is fit for use. It also gives auditors hard evidence instead of verbal assurances.

What documents should I prepare before a construction site HSE audit?

Prepare the HSE plan, risk assessments, method statements, permits, training and competence records, and incident reports. Also prepare the asset register with inspection certificates, pre-use checklists, and open maintenance work orders. Having these ready can cut audit time in half.

Can a CMMS help with construction site HSE compliance?

Yes, a CMMS helps by keeping asset registers, inspection checklists, preventive maintenance schedules, and work orders in one system. Auditors can scan an asset's QR code and see its full inspection history on the spot. Findings become tracked work orders, which creates a clear audit trail.

Integrated construction site HSE audits only work when every inspection, defect, and fix is recorded and easy to prove. Schedule a free demo to see how Cryotos links your safety checks, asset inspections, and maintenance work orders into one audit-ready record.

Want to Try Cryotos CMMS Today?

Get Free Demo

Let AI Take Control of Your Maintenance

Cryotos AI predicts failures, automates work orders, and simplifies maintenance—before problems slow you down.

Try AI-Powered CMMS
🡢
