Leading vs Lagging Maintenance Indicators: What to Track

Calendar
Duration:
15 min read
calendar today
Published on
June 17, 2026
Featured Image

Leading maintenance indicators are metrics that predict future equipment performance and reliability — they measure the quality of actions taken before failures occur. Lagging maintenance indicators measure outcomes after the fact — breakdowns, downtime hours, repair costs, and MTTR. Both matter, but most maintenance teams track almost exclusively lagging indicators: they know their MTTR after a breakdown, but have no visibility into the leading conditions that made that breakdown predictable weeks earlier. According to the Society for Maintenance and Reliability Professionals (SMRP), best-practice maintenance organisations track a balanced scorecard of 4–8 KPIs covering both leading and lagging dimensions — teams that track only lagging indicators consistently react to problems they had the data to prevent. This guide explains the difference between leading and lagging indicators, which specific metrics belong in each category, and how to build a dashboard that gives you early warning, not just a post-mortem.

Key Takeaways

  • Lagging indicators tell you what happened; leading indicators tell you what will happen: A high MTTR after a breakdown is a lagging signal. A declining PM compliance rate four weeks earlier was the leading signal that predicted it.
  • Most maintenance teams are 100% lagging — and don't know it: MTTR, MTBF, breakdown frequency, and repair costs are all lagging. If those are your only metrics, you are measuring failures, not preventing them.
  • The most powerful leading indicators are ratio-based: Planned-to-reactive ratio, PM completion rate, and scheduled work compliance rate all signal the direction your reliability is heading before it arrives.
  • A CMMS makes leading indicators trackable without manual effort: PM completion rate, work order backlog age, and parts availability at PM are automatically calculable from CMMS work order data — no spreadsheet required.

What Are Leading and Lagging Maintenance Indicators?

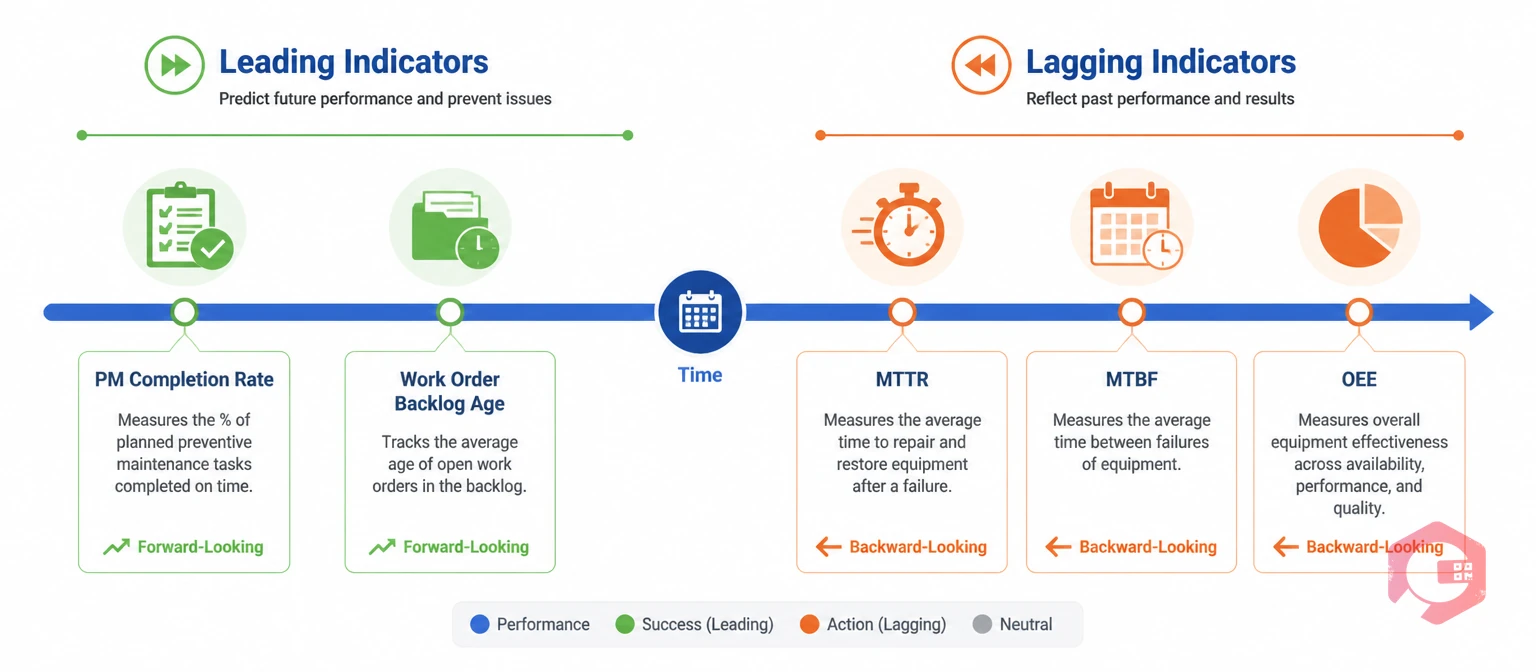

Leading vs lagging maintenance indicators concept illustration showing timeline with predictive and retrospective KPIs | Cryotos

The distinction between leading and lagging is a timing distinction. Lagging indicators measure results — what happened after the fact. Leading indicators measure inputs and process quality — what is happening now that will determine tomorrow's results.

In maintenance, every outcome you care about — equipment availability, unplanned downtime hours, repair cost per asset, mean time to repair — is a lagging indicator. It is the measurement of something that has already happened. A MTTR of 6 hours tells you your last repair took too long. It does not tell you why, and it does not tell you how to prevent the next one from taking as long or arriving as soon as it might.

Leading indicators work in the opposite direction. A PM completion rate of 68% this quarter tells you that roughly a third of your scheduled maintenance is not being executed. That gap is not yet a breakdown — but it is a reliable predictor that breakdowns are accumulating. The same logic applies to planned-to-reactive work ratio, parts availability at PM, open work order backlog age, and technician utilisation on planned versus unplanned work.

The practical value of leading indicators is that they give you time to act. When your PM completion rate drops below 80%, you have weeks to investigate and correct before the reliability consequences land. When your MTTR rises, the consequence has already occurred — the only question is whether the root cause will repeat.

The Core Lagging Indicators and What They Actually Tell You

Lagging indicators are not useless — they are the scoreboard. They quantify the cost of your current maintenance approach and measure whether that cost is improving or worsening over time. The mistake is treating them as the complete picture.

  • MTTR (Mean Time to Repair): The average time from failure detection to production restoration. MTTR tells you how effectively your team recovers from failures — it reflects parts availability, technician skill, diagnostic accuracy, and work order process efficiency. High MTTR on a specific asset often reveals a parts stocking issue or a skills gap rather than a hard equipment problem. Use the MTBF calculator alongside MTTR to understand both failure frequency and recovery speed for each critical asset.
  • MTBF (Mean Time Between Failures): The average operating time between unplanned failures on the same asset. Rising MTBF means your PM programme is working. Falling MTBF means degradation is accelerating — either PM is insufficient or the asset is operating beyond its design envelope. MTBF is the clearest lagging signal of whether your preventive maintenance programme is effective.
  • Planned-to-reactive work ratio (as an outcome): The proportion of total maintenance hours spent on planned versus unplanned work. A ratio below 70% planned/30% reactive indicates a maintenance programme that is still predominantly reactive. World-class operations target 80–90% planned. This ratio is simultaneously a lagging indicator (measuring the consequence of last period's programme quality) and a leading indicator (signalling whether the next period is likely to be reactive or controlled).
  • Overall Equipment Effectiveness (OEE): The composite measure of Availability, Performance, and Quality. OEE translates maintenance outcomes directly into production impact — it is the business-level lagging indicator that justifies maintenance investment to leadership. Track it using the OEE calculator at the asset level for the most actionable view.
  • Maintenance cost per asset: Total maintenance spend (labour plus parts) divided by the number of assets maintained. Rising cost per asset signals either ageing equipment requiring more intervention, inefficient work practices, or parts pricing escalation. It is a financial lagging indicator that supports replace-versus-repair and capital planning decisions.

Leading vs. Lagging Indicators: A Side-by-Side Comparison

IndicatorTypeWhat It MeasuresWhen It SignalsAction Window
MTTRLaggingRecovery speed after failureAfter breakdown occursPost-event review only
MTBFLaggingFailure frequency per assetAfter pattern of failures emergesPost-event review only
OEELaggingOverall production impact of downtimeAfter production period endsPost-period review only
PM Completion RateLeading% of scheduled PMs executed on timeWeekly — while gap is still correctableWeeks before reliability impact
Planned-to-Reactive RatioBothProgramme health and reactive loadWeekly/monthlyIndicates trajectory
Work Order Backlog AgeLeadingDeferred maintenance accumulationReal-timeDays to weeks before impact
Parts Availability at PMLeadingInventory readiness for scheduled workPre-PM triggerDays before PM execution
Wrench TimeLeading% of time technicians spend on actual workWeeklyIndicates scheduling efficiency

The action window column is the key differentiator. Lagging indicators have no action window — by the time they signal a problem, the cost has already been incurred. Leading indicators give you days or weeks to course-correct before the consequence lands in your downtime log.

The Five Most Valuable Leading Indicators and How to Calculate Them

Five most valuable leading maintenance indicators: PM completion rate, backlog age, wrench time, parts availability, corrective ratio | Cryotos

These five leading indicators are consistently cited by maintenance engineering bodies as the highest-value predictive metrics for industrial and commercial maintenance operations. All five are calculable directly from CMMS work order data — no additional sensors or manual tracking required.

  • PM Completion Rate: The percentage of scheduled PMs that are completed on or before their due date within a defined period. Formula: (PM work orders closed on time ÷ PM work orders scheduled) × 100. Target: 90%+. A PM completion rate below 80% is a reliable predictor of rising reactive work volume within 4–8 weeks. According to Reliable Plant's maintenance benchmarking research, facilities with PM completion rates above 90% consistently achieve planned-to-reactive ratios above 75% — the threshold that separates controlled maintenance from reactive firefighting.
  • Work Order Backlog Age: The average age of all open work orders in the queue. Formula: sum of (today's date minus creation date) for all open work orders ÷ number of open work orders. A rising backlog age — particularly on preventive work orders — means deferred maintenance is accumulating. When critical asset PMs sit open for 2–3 weeks beyond their due date, the probability of a reactive failure on that asset increases measurably. Review backlog age by asset criticality, not just as a fleet-wide average.
  • Scheduled Work Compliance Rate (Wrench Time): The percentage of total maintenance labour hours spent on planned and scheduled work versus reactive and emergency work. Track using the wrench time calculator. Target: 65–75% of total labour on planned work. Wrench time is a leading indicator because it measures whether technicians are working on planned prevention or reactive response — a technician team spending 50% of their time on reactive work is systematically under-investing in prevention, and the breakdown rate will reflect that within weeks.
  • Parts Availability at PM Execution: The percentage of PM work orders that had all required parts in stock when the PM was due to execute. Formula: (PM work orders with all parts available at due date ÷ total PM work orders due) × 100. Parts unavailability is one of the most common reasons PM compliance rate drops — a PM that fires but cannot execute because a filter or seal is not in stock is deferred, adding to backlog age and reducing completion rate. A parts availability rate below 95% for scheduled PMs indicates an inventory management gap that is directly suppressing your maintenance programme effectiveness.
  • Corrective-to-Preventive Work Order Ratio: The proportion of corrective (reactive, breakdown) work orders relative to preventive work orders in a given period. Formula: reactive work orders ÷ total work orders. A rising ratio signals that reactive work is consuming capacity that should be allocated to preventive work — which accelerates the cycle. Target: reactive work orders below 20–25% of total work orders. This ratio is a leading indicator because it measures the direction of travel before MTBF and downtime statistics reflect the full deterioration.

How to Build a Balanced Maintenance KPI Dashboard

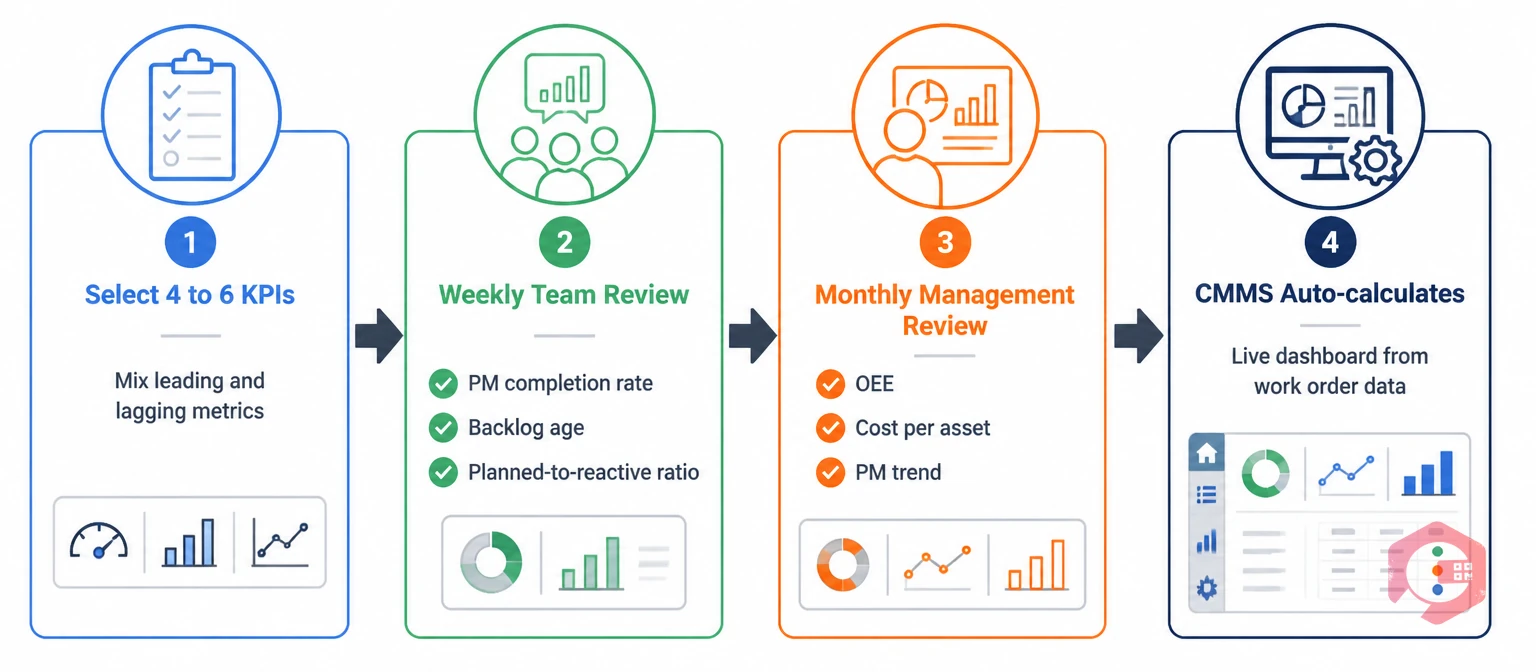

How to build a balanced maintenance KPI dashboard: select KPIs, weekly team review, monthly management review, CMMS auto-calculation | Cryotos

A practical maintenance KPI dashboard tracks 4–6 metrics — not 20 — covering both leading and lagging dimensions at the right update frequency. More metrics create noise; fewer miss the picture.

The recommended structure for most industrial or facility maintenance operations is two leading indicators, two lagging indicators, and one financial indicator reviewed weekly by the maintenance team and monthly by management.

For the weekly team review: PM completion rate (leading — are we executing the programme?), work order backlog age by criticality (leading — is deferred maintenance accumulating on critical assets?), planned-to-reactive ratio (both — are we trending toward control or reactivity?), and MTTR on critical assets (lagging — how is recovery performance trending?).

For the monthly management review: OEE or availability percentage (lagging — what is the business impact?), maintenance cost per asset (lagging — is spend trending correctly?), and PM completion rate trend (leading — is the programme maintaining discipline?).

Cryotos's BI Dashboard surfaces all of these metrics automatically from work order data — PM completion rates, backlog age, planned-to-reactive ratios, MTTR, and cost per asset are all calculated live without any manual data extraction or spreadsheet work. Maintenance managers see the full leading-and-lagging picture in a single view, updated in real time as work orders are created, assigned, and closed. The report builder lets teams customise which metrics surface in which view — so the weekly team review shows the leading indicators that drive decisions, while the monthly management report shows the lagging outcomes that demonstrate programme value.

The Leading Indicator Trap to Avoid

Leading indicators are only useful if you act on them. The most common failure mode is tracking PM completion rate, seeing it drop to 72%, noting it in a spreadsheet, and doing nothing different. The leading indicator fired — but without a defined response protocol, it is just another number in a dashboard that nobody acts on.

Each leading indicator in your dashboard needs a defined response threshold and a specific action trigger. PM completion rate below 85%: maintenance planner reviews all overdue PMs that week, identifies whether the cause is parts, technician capacity, or scheduling, and takes specific corrective action before next reporting cycle. Work order backlog age above 10 days on a critical asset: automatic escalation to maintenance manager for resource reallocation decision. Parts availability at PM below 90%: procurement review triggered to investigate which parts categories are causing execution delays.

According to Plant Maintenance Resource Center, maintenance teams that define and enforce response protocols for leading indicator thresholds reduce reactive work order volume by 25–40% within 12 months — the direct result of acting on early warning signals before they become breakdown events.

Build these thresholds and response protocols into your CMMS workflow configuration — so when a leading indicator crosses its threshold, the system generates the appropriate alert or work order automatically, rather than waiting for a human to notice the number in a report and decide what to do about it.

Frequently Asked Questions

What is the difference between a leading and lagging maintenance indicator?

A leading maintenance indicator measures the quality of inputs and processes — what your team is doing now — and predicts future reliability outcomes. A lagging maintenance indicator measures the outcomes of past actions — breakdowns that occurred, downtime that happened, costs incurred. PM completion rate is a leading indicator: it tells you whether your PM programme is executing as planned before the reliability consequences arrive. MTTR is a lagging indicator: it tells you how well you recovered from a failure that has already occurred. Effective maintenance measurement requires both.

What is a good PM completion rate?

A PM completion rate of 90% or above is the benchmark for best-practice maintenance operations. At this level, 9 out of 10 scheduled PMs execute on or before their due date — close enough to 100% that the reliability programme is essentially intact. PM completion rates between 80–90% indicate a programme under pressure, with some PMs consistently deferred. Below 80% is a significant programme health risk — at this level, the backlog of deferred PMs is large enough to generate measurable increases in reactive work volume within 4–8 weeks.

How many maintenance KPIs should you track?

Four to eight KPIs is the practical range for a maintenance team. Below four, you miss critical dimensions — either leading or lagging perspectives are absent. Above eight, the dashboard becomes noise and review meetings turn into data discussions rather than decision meetings. The priority is a balanced mix: 2–3 leading indicators that give you early warning, 2–3 lagging indicators that measure outcomes, and 1–2 financial indicators that connect maintenance performance to business cost.

Can a CMMS automatically calculate leading maintenance indicators?

Yes — all of the highest-value leading indicators are directly calculable from CMMS work order data without any manual extraction. PM completion rate comes from the ratio of PM work orders closed on time to PM work orders scheduled. Work order backlog age comes from the age distribution of open work orders. Parts availability at PM comes from inventory records cross-referenced against PM work order parts lists. Cryotos calculates and surfaces all of these automatically in the BI Dashboard — giving maintenance teams real-time leading indicator visibility without any spreadsheet work.

Tracking the right combination of leading and lagging indicators is what separates a maintenance team that manages its programme from one that simply reacts to it. Cryotos gives you the automated KPI dashboard — PM completion rates, backlog age, planned-to-reactive ratios, MTTR, OEE, and cost per asset — calculated live from your work order data and surfaced in a single view. Schedule a free demo to see how leading maintenance teams use Cryotos to track the indicators that predict problems, not just the ones that report them.
