How to Perform Life Cycle Cost Analysis (LCCA) for Equipment Decisions

Calendar
Duration:
9 min
calendar today
Published on
October 22, 2026
Featured Image

Life cycle cost analysis (LCCA) is a method that totals every cost of owning equipment over its service life. You convert each cost to present value, then compare options on one number instead of the purchase price.

A cheap machine that fails often can cost far more than a pricier, reliable one. This guide shows how to perform life cycle cost analysis in six steps. It includes a worked 10-year example and the records you need from your maintenance system. It also covers the biggest challenge teams face, missing cost history, and how Cryotos solves it.

Key Takeaways

  • Total cost wins: Life cycle cost analysis counts acquisition, energy, maintenance, downtime, and disposal, so the lowest bid does not automatically win.
  • Present value is the common scale: Discounting lets you compare options whose costs arrive in different years.
  • Your own data decides: Work order, downtime, and parts history make the result defensible.
  • Test the assumptions: Sensitivity checks show which input can flip the decision.

What Is Life Cycle Cost Analysis (LCCA)?

Life cycle cost as the total of all equipment costs from purchase to disposal | Cryotos

Life cycle cost is the total of all costs an asset creates between purchase and disposal. Life cycle cost analysis compares equipment options on that total over a fixed study period.

ASTM E917 and NIST Handbook 135 document the method, and ISO 55000 frames asset decisions around whole-life value. The Whole Building Design Guide overview of LCCA is a useful public primer. Teams use it for three kinds of decisions.

  • Repair or replace: Decide whether to overhaul an aging asset or buy a new one.
  • Bid evaluation: Compare quotes with different prices, efficiency, and service needs.
  • Specification: Choose between standard and premium-efficiency models.

Most maintenance teams feel the gap between price and cost every year. For continuously running motors, energy typically dwarfs the purchase price. The Hydraulic Institute and Europump guide to pump life cycle costs reaches a similar conclusion.

LCCA is closely related to total cost of ownership, but it adds discounting and a defined study period. It also treats maintenance costs and downtime as core inputs, so it turns a purchase debate into a cost model you can defend.

Step 1: Define the Decision and the Study Period

Start by writing the decision as one question, such as "overhaul this compressor or replace it." Then fix one study period for every option. A 10-year period is common for rotating equipment.

If options have different lives, keep the same study period and credit any remaining value as salvage, or compare equivalent annual cost.

  • Options: Name each alternative, including doing nothing.
  • Study period: Use the same number of years for all options.
  • Scope: List which costs are in and out of the model.
  • Sign-off: Name who approves the assumptions.

A clear question and a fixed period keep the analysis honest.

Step 2: Map Every Cost With the Six-Bucket Framework

The six-bucket life cycle cost framework: acquire, operate, maintain, fail, hold, retire | Cryotos

Sort every cost into six buckets so nothing hides outside the analysis.

The Six-Bucket Life Cycle Cost Framework:

  • Acquire: Purchase price, freight, installation, commissioning, and training.
  • Operate: Energy, consumables, and operator labor.
  • Maintain: Planned labor, parts, and service contracts.
  • Fail: Corrective repairs and lost output from unplanned downtime.
  • Hold: Spare parts inventory, insurance, and floor space.
  • Retire: Removal and disposal, minus any salvage value.

Downtime is the bucket teams most often leave out, and it is often the largest. Give it a cost per hour from lost margin, overtime, and scrap, and agree on that number with finance.

To size your own maintenance bucket, try the mean maintenance cost calculator.

Step 3: Collect Real Cost and Failure Data

Collect actual cost and failure data from your maintenance records before you estimate anything. Vendor brochures supply price and rated energy use, but your own history shows repair frequency, repair cost, and downtime hours.

  • Repairs and labor: Closed work orders show hours, parts, and failure causes per asset.
  • Downtime: Downtime tracking gives hours stopped, MTTR, and MTBF.
  • Parts: Inventory records show spares usage and stock cost.
  • Energy: Meter readings or utility bills give kWh per running hour.

A Computerized Maintenance Management System keeps these records on one asset, so the cost history becomes a report instead of a research project. Real history makes the analysis defensible when finance asks where a number came from.

Step 4: Convert Costs to Present Value

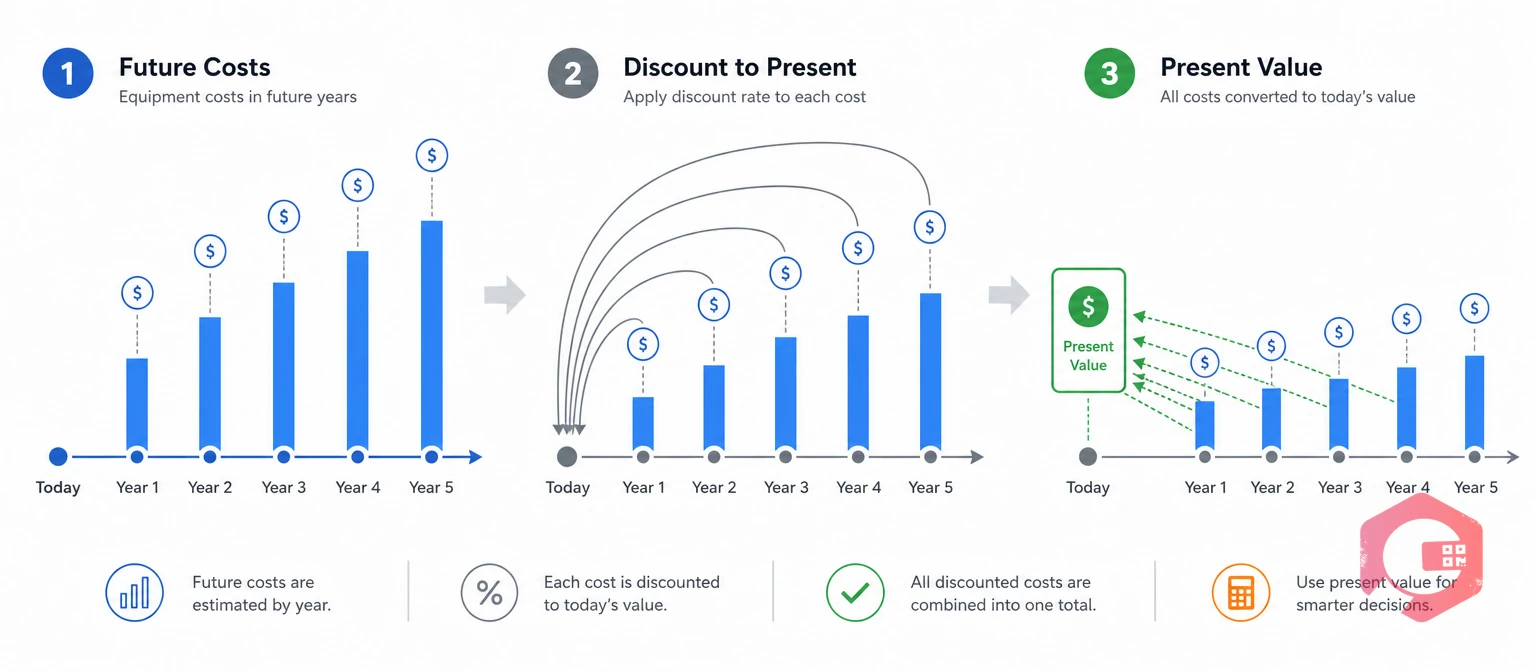

Converting future equipment costs to present value with a discount rate | Cryotos

Net present value is the sum of all costs, each discounted back to today's money. The net present value method lets you compare options that spend money in different years.

The discount rate is the yearly percentage used to convert future costs into present value. Agree on it with finance, because it reflects your cost of capital.

  • Present value: PV = C ÷ (1 + r)^t, where C is the cost, r is the rate, and t is the year.
  • Repeating annual costs: Multiply by the annuity factor, which is 6.71 at 8% over 10 years.
  • Consistency: Pair a real rate with constant dollars, or a nominal rate with inflated dollars, never both.

Equivalent annual cost is the yearly cost of owning an asset once all costs are spread over its life. Use EAC = NPV × r ÷ (1 − (1 + r)^−n) to compare options with different lives.

Step 5: Compare Equipment Options With a Worked Life Cycle Cost Analysis Example

Comparing options means running every cost bucket through the same present value math. This illustrative example uses a 10-year study, an 8% discount rate, flat costs, and downtime valued at $1,250 per hour. The figures are assumptions, not customer data.

  • Keep and overhaul: $18,000 overhaul now, then $38,000 energy, $6,000 planned maintenance, $10,000 repairs, and 18 downtime hours per year.
  • Replace: $150,000 purchase, then $31,000 energy, $7,000 planned maintenance, $3,000 repairs, and 6 downtime hours per year, with $15,000 salvage in year 10.
Cost BucketKeep and Overhaul (Present Value)Replace (Present Value)
Acquire (overhaul or purchase)$18,000$150,000
Operate (energy)$255,000$208,000
Maintain (planned work)$40,300$47,000
Fail (corrective repairs)$67,100$20,100
Fail (downtime)$151,000$50,300
Retire (salvage value)$0-$6,900
Total present value$531,400$468,500
Equivalent annual cost$79,200$69,800

Replacing is about $62,900 cheaper in present value, even though it costs $132,000 more up front. Downtime and repair savings drive most of the gap. Figures are rounded to the nearest $100, and the example leaves out the Hold bucket for simplicity.

Step 6: Stress-Test the Result With Sensitivity Checks

Stress-test the result by changing one assumption at a time and watching whether the ranking flips. In the compressor example, one input matters far more than the rest.

  • Downtime cost: At zero downtime cost, keeping the unit wins by about $37,800. Replacement wins once the old unit loses more than roughly 10.5 hours a year.
  • Half the downtime rate: At $625 per hour, replacing still leads by about $12,500.
  • Discount rate: Replacing stays ahead at 5% (by about $93,400) and at 12% (by about $31,000).
  • Energy savings: If the new unit saves only half the expected energy, replacing still leads by about $39,300.

The decision hinges on downtime hours, so verify that number with maintenance records, not vendor claims.

Avoid These Common Life Cycle Cost Analysis Mistakes

Most life cycle cost analysis errors come from five habits that are cheap to fix.

  • Leaving out downtime: It is often the largest bucket, so omitting it favors the cheaper, less reliable option.
  • Trusting rated energy figures: Brochure numbers assume ideal load, so use your actual duty cycle.
  • Counting sunk costs: The price you paid for the existing asset is gone, so only future costs belong in the model.
  • Mixing rate types: A nominal rate with constant dollars quietly skews the ranking.
  • Using one estimate: Without sensitivity checks, a single guess can drive a six-figure decision.

Fixing these five habits makes the result far easier to defend.

The Challenge: Equipment Decisions Made Without Cost History

The biggest challenge in life cycle cost analysis is rarely the math. It is finding trustworthy cost history for the asset you are judging.

Picture a plant deciding whether to overhaul or replace an 11-year-old compressor. This scenario is a composite of patterns common to maintenance teams, not a single customer account.

  • Scattered repair costs: Labor sits on paper job cards and parts sit in a store ledger, with nothing tied to one asset.
  • Unrecorded downtime: Stoppages live in shift notes, so the true hours per year are a guess.
  • Unmetered energy: The compressor shares a utility bill with the whole building.
  • Price-led approval: Finance sees only the purchase quote, so the cheaper overhaul wins by default.

Without history, the team argues from opinion, and the lowest upfront cost usually wins.

How Cryotos Supports Life Cycle Cost Analysis

Cryotos solves the data problem by keeping every cost and failure record on one asset history. The inputs to life cycle cost analysis then come from reports, not memory.

  • Work orders: Technicians log labor, parts, and failure causes against the asset from a mobile app, including offline.
  • Inventory: Parts are tracked by QR code or barcode, with FIFO, LIFO, or average costing.
  • Reporting: A BI dashboard and 50+ reports, plus custom ones, show MTBF, MTTR, and maintenance spend by asset, with scheduled email delivery.
  • Budget: Project and budget tracking records maintenance spending against projects and budgets.
  • ERP link: SAP and Microsoft Dynamics 365 integration links maintenance records with ERP data.

In the compressor scenario, the team exports the asset's work orders, downtime hours, and parts spend. They enter those figures into the present value model. Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. Downtime is the input that moves the result most.

Cryotos does not replace the discount rate from finance or the engineering judgment behind the study period. It supplies the records, and a spreadsheet runs the present value math.

Frequently Asked Questions

What is life cycle cost analysis in simple terms?

Life cycle cost analysis adds up everything an asset costs from purchase to disposal and converts it to today's money. You can then compare options fairly, even when one costs more up front.

How is LCCA different from total cost of ownership?

Total cost of ownership totals the costs of owning an asset. LCCA usually adds discounting over a defined study period and ranks competing options. Many teams use the two terms loosely.

What discount rate should I use for equipment decisions?

Use the rate your finance team sets for investments, often tied to cost of capital. Match it to your dollar type, and test a range, because the ranking can change.

When should I replace equipment instead of repairing it?

Replace when the present value of keeping the asset, including repairs, energy, and downtime, exceeds the present value of replacing it. Rules of thumb, such as repair cost above half of replacement value, are only quick screens.
