Preventive vs Corrective Maintenance: What a 43/57 Split Tells You About Your Maintenance Maturity

Calendar
Duration:
9 min
calendar today
Published on
October 8, 2026
Featured Image

Preventive vs corrective maintenance is the balance between work you plan before a failure and work you do after one. A 43/57 split means 43% of your jobs are preventive and 57% are corrective. It tells you the team now measures its work, but breakdowns still set the agenda. Most reliability benchmarks put mature programs at 70% to 80% or more planned work.

This guide explains what each side of the split signals and scores it on a five-stage maturity scorecard. It then walks through a real Cryotos client whose 43/57 split came from nine months of live data, the challenge they faced, and how Cryotos solved it.

Key Takeaways

  • Read the split as a signal: A 43/57 ratio means failures still lead the workload, but the team is finally measuring it.
  • Know the benchmark: Many practitioners treat 80% planned work as world-class and 70/30 as a solid goal for most plants.
  • Real data, real result: A marine robotics client logged 117 preventive and 155 corrective jobs in 2026 and still reached 96% asset availability with Cryotos.
  • Climb in order: Protect critical assets first, then remove repeat failures, then move toward condition-based work.

Preventive vs Corrective Maintenance: Key Differences

Preventive maintenance is scheduled work done before a failure to keep an asset in good condition. It runs on a calendar, runtime hours, or meter readings, and the standard definition covers inspections, lubrication, adjustments, and part swaps.

Corrective maintenance is work done to restore an asset after a fault or failure is found. Corrective maintenance can be planned, such as a defect found on an inspection, or urgent, such as a breakdown in the middle of a shift.

FactorPreventive MaintenanceCorrective Maintenance
TriggerCalendar, runtime hours or meter readingFault, defect or breakdown
TimingBefore failureAfter failure or defect is found
DowntimePlanned and usually shortOften unplanned and longer
Cost profilePredictable labor and partsOvertime, rush parts and lost output
Best fitCritical assets with known wear patternsLow-risk assets with spares or a run-to-failure plan
Main KPIPM complianceMTTR and repeat failures

Neither type is wrong on its own. The goal is the right mix for each asset, based on how critical it is and how it fails.

What a 43/57 Preventive vs Corrective Maintenance Split Means

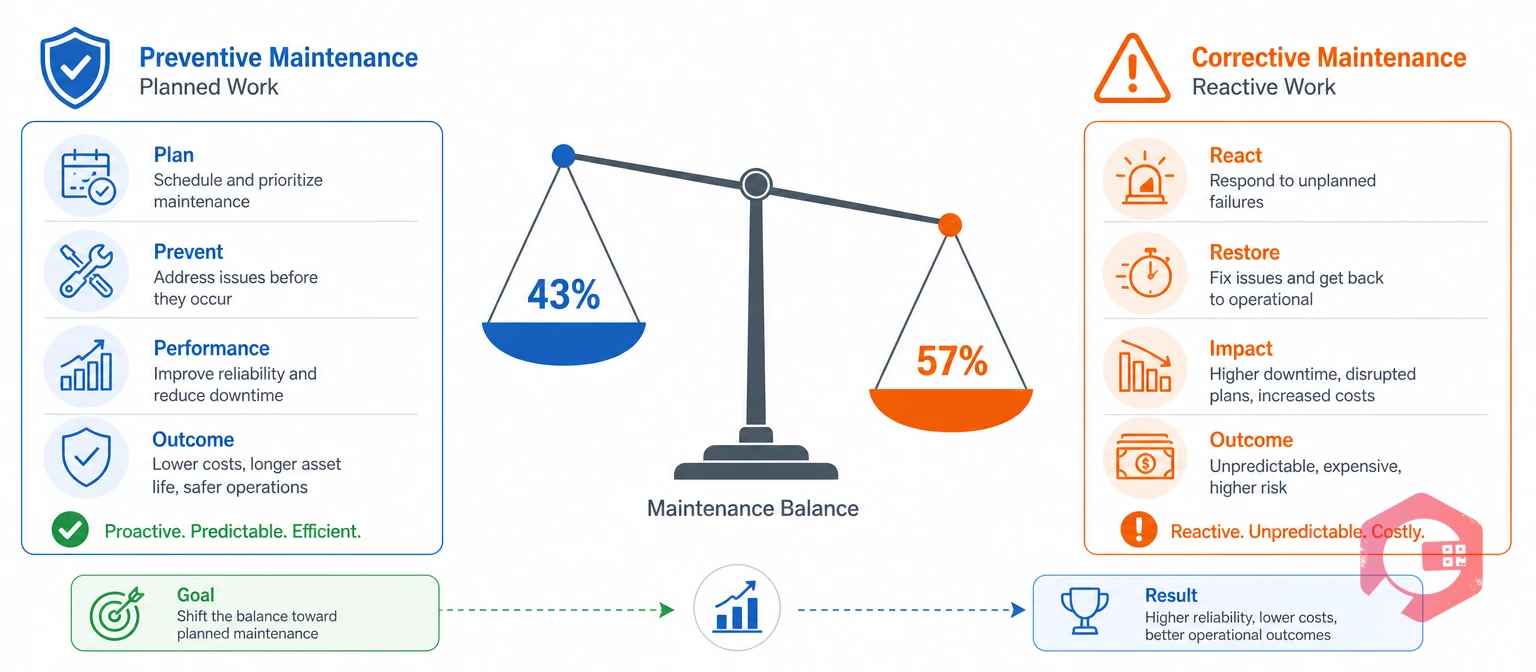

The 43/57 preventive versus corrective maintenance split concept | Cryotos

A 43/57 preventive vs corrective maintenance split means your team spends more time fixing failures than stopping them. It sits below the 50% line where planned work takes the lead. It is also far below the 80/20 ratio that many reliability teams call world-class.

Why the split matters more in 2026

  • Downtime is expensive: Siemens' True Cost of Downtime 2024 report estimated that unplanned downtime costs the world's 500 largest companies about $1.4 trillion a year, close to 11% of their revenue.
  • Prevention pays back: The US Department of Energy's O&M Best Practices Guide estimates that a working preventive program can save 12% to 18% compared with a purely reactive approach.
  • Standards reward planning: Asset management standards such as ISO 55000 and SMRP benchmarks favor planned, documented work over firefighting.

Why a 43/57 split is not always a crisis

The ratio is a signal, not a verdict. A high corrective share can mean real failures, but it can also mean a team finally logs small faults that paper records used to miss. Read the split next to unplanned maintenance hours, repeat failures, and critical breakdowns before you judge it.

Want to check your own ratio? Use the free planned maintenance percentage calculator to see where your team stands today.

The Preventive vs Corrective Maintenance Maturity Scorecard

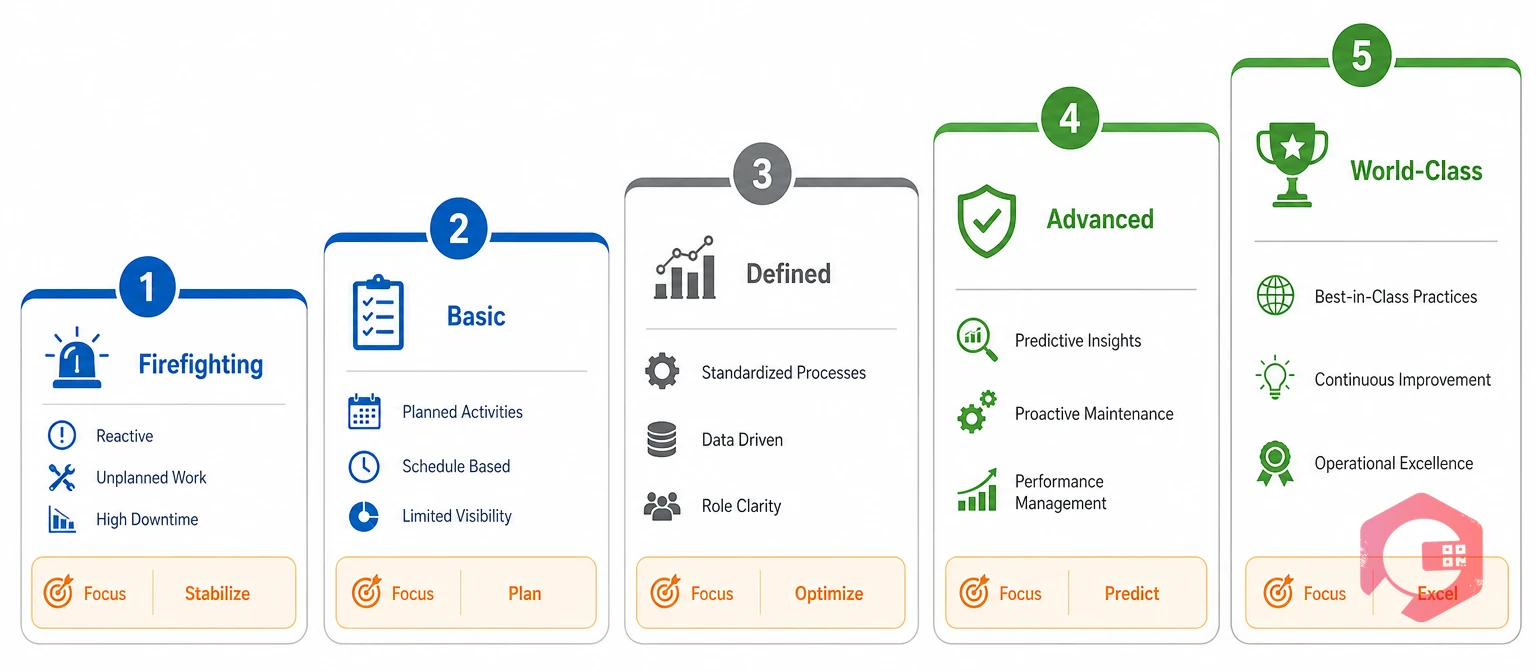

Five-stage preventive vs corrective maintenance maturity scorecard | Cryotos

The scorecard below maps your preventive share to a maturity stage. Find your row, then look at the next move, not the end goal.

StagePM ShareCM ShareWhat It SignalsNext Move
1. FirefightingUnder 30%Over 70%Breakdowns set the agenda; few reliable recordsLog every job digitally
2. Reactive-Leaning30% to 49%51% to 70%Work is measured, but failures still leadAdd PMs to critical assets first
3. Balanced50% to 69%31% to 50%PMs run on time and repeat failures fallRun root cause reviews on repeats
4. Planned70% to 84%16% to 30%Most work is scheduled and backlog is steadyShift time-based PMs to condition-based checks
5. World-Class85% and above15% or lessCorrective work is mostly planned repairs found on inspectionsTune intervals with failure data

A 43/57 split lands at Stage 2. Most maintenance teams at this stage already hold the data they need, and the next gain comes from pointing it at the right assets. That is where maintenance management software earns its place.

The Client Challenge Behind a Real 43/57 Split

The 43/57 split in this article comes from a real Cryotos customer: a marine robotics and underwater inspection company that inspects ports, dams, ships, and pipelines with remotely operated vehicles (ROVs). From January to September 2026, the team raised 272 requests, made up of 117 preventive jobs (43%) and 155 corrective work orders (57%).

Getting that number at all was the first win. Before it moved to a Computerized Maintenance Management System in November 2019, the company ran maintenance on paper and Excel and faced four connected problems.

  • Lost detail: Handwritten work orders missed key facts, so nobody could tell a one-off thruster fault from a repeat one.
  • No downtime visibility: Without reliable outage records, the team could not measure how available each ROV really was.
  • A mixed, complex fleet: ROVs, winches, tethers, and workshop machines such as compressors and a pressure chamber each needed their own procedures.
  • Updates by phone and email: Status lived in calls and message threads, and each department kept its own version of the truth.

The major challenge was simple to state and hard to fix. The team could not see its own preventive vs corrective maintenance balance, so it could not manage it.

How Cryotos Solved the Challenge

Cryotos solved the challenge by putting every preventive and corrective job into one system with the same level of detail. Each fix below maps to one of the gaps the team faced.

  • ROV-specific breakdown work orders: Every fault is logged against the right asset, with a timestamp and the technician's name.
  • Mandatory downtime logging: A corrective job cannot close until outage time is recorded, and Cryotos downtime tracking turns it into MTTR, MTBF, and availability.
  • 8D root cause reports: Repeat or critical failures go through an eight-step review, so the cause is removed, not just repaired.
  • Dedicated PM templates: ROVs, winch and tether systems, and workshop machines each run on their own checklists and schedules.
  • One shared record: Comments, spare requests, permits, and a weekly maintenance report replaced calls and email chains.

Results the client reports after moving to Cryotos

  • 96% asset availability: The ROV fleet is credited with 96% availability and reliability.
  • At least 25% fewer critical breakdowns: Better tracking and 8D follow-up cut critical incidents by a minimum of 25%.
  • A live maturity KPI: The 43/57 ratio is now a number the team can track month by month instead of a guess.

Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. For this client, the lesson is that a 57% corrective share and 96% availability can sit side by side when every failure is logged, explained, and designed out.

How to Move Your Maintenance Ratio Toward 70/30

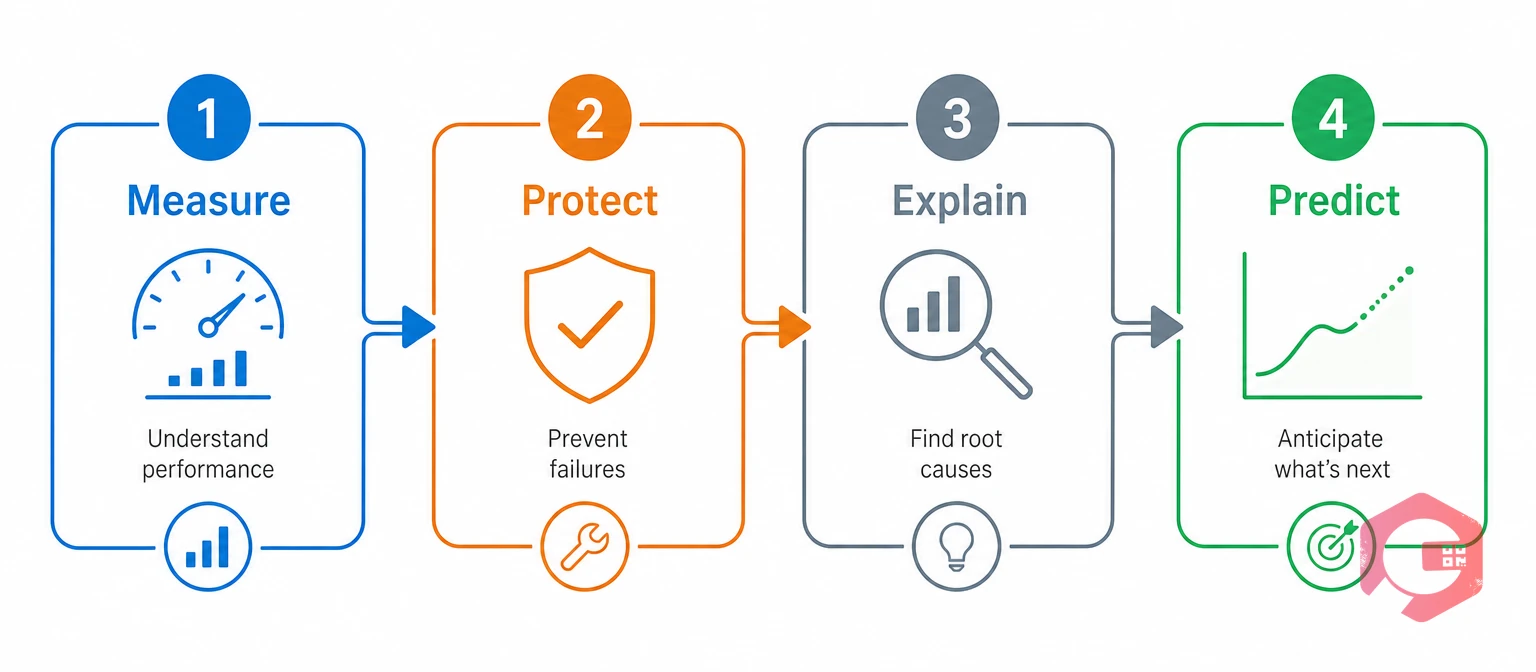

Four-step PM-CM maturity ladder: measure, protect, explain, predict | Cryotos

You shift the preventive vs corrective maintenance ratio by protecting critical assets first, not by adding PMs everywhere. Teams that successfully move from Stage 2 to Stage 3 usually climb four rungs in order.

The PM-CM Maturity Ladder:

  • Measure: Capture every preventive and corrective job with the same fields, including asset, cause, and downtime.
  • Protect: Put PMs on the assets whose failure costs the most in safety, output, or repair spend.
  • Explain: Run root cause analysis on every repeat or critical failure and turn the fix into a task.
  • Predict: Use meter readings and condition checks to time work just before failure, not on a fixed date.

Practical moves for the next 90 days

  • Rank your top 20 assets: Score them by safety, output, and repair cost, then check which ones have no PM at all.
  • Turn repeat fixes into PMs: Any corrective job seen three times on one asset should trigger a new inspection task in your preventive maintenance software.
  • Split planned and urgent corrective work: A defect found on an inspection is a win, so tag it apart from a breakdown.
  • Review the ratio monthly: A common mistake is checking it once a year, when the trend is already old news.

Steady gains each quarter last longer than a leap to 80/20. Chasing the target too fast usually floods technicians with low-value PMs that nobody finishes.

Frequently Asked Questions

What is a good preventive vs corrective maintenance ratio for most facilities?

Many reliability practitioners treat 80% planned and 20% reactive work as world-class, and 70/30 as a solid goal for most plants. The right ratio still depends on asset criticality, since some low-risk assets are cheaper to run to failure.

Is a 43/57 preventive to corrective split a bad sign?

It shows a reactive-leaning program, but it is not always bad. If the team logs every fault honestly and critical breakdowns are falling, the split is a strong baseline to improve from.

How do I calculate my preventive vs corrective maintenance split?

Count the preventive and corrective jobs closed in the same period, then divide each by the total. For example, 117 preventive and 155 corrective jobs out of 272 gives a 43/57 split.

Does work found during a preventive inspection count as corrective maintenance?

Yes, a defect found on an inspection is corrective work, but it is planned corrective work. Track it apart from breakdowns, because a rise in inspection findings often means your PMs are catching problems early.

How can a CMMS improve my preventive vs corrective maintenance balance?

A CMMS schedules PMs on time, logs every corrective job with downtime and cause, and reports the split by asset and month. That view shows exactly where a new PM or a root cause review will do the most good.
