How to Control Maintenance Spend with Project-Based Budget Tracking

Calendar
Duration:
9 min read
calendar today
Published on
July 28, 2026
Featured Image

Key Takeaways

  • Project-based budget tracking ties a maintenance budget to one specific job — a shutdown, a refurbishment, a capex upgrade — and deducts real costs from it as the work happens.
  • Real-time deduction beats month-end math. Spend only becomes visible the moment work orders and parts post against the same budget, not after a spreadsheet update weeks later.
  • Splitting the budget by category — labor, parts, other costs — catches an overrun a single lump-sum total would hide until it's too late to fix.
  • A CMMS with a project and budget module turns this into an automatic process, using the same system that already runs your work orders.

Project-based budget tracking sets a fixed budget for one maintenance project — a shutdown, a facility upgrade, a capital refurbishment — and pulls labor, parts, and other costs from that budget the moment work is done. It replaces the common habit of logging spend in a spreadsheet that gets updated weeks after the money is already gone. Done well, it gives maintenance teams a live answer to the question finance always asks: are we still on budget, and if not, where did it go?

What Is Project-Based Budget Tracking in Maintenance?

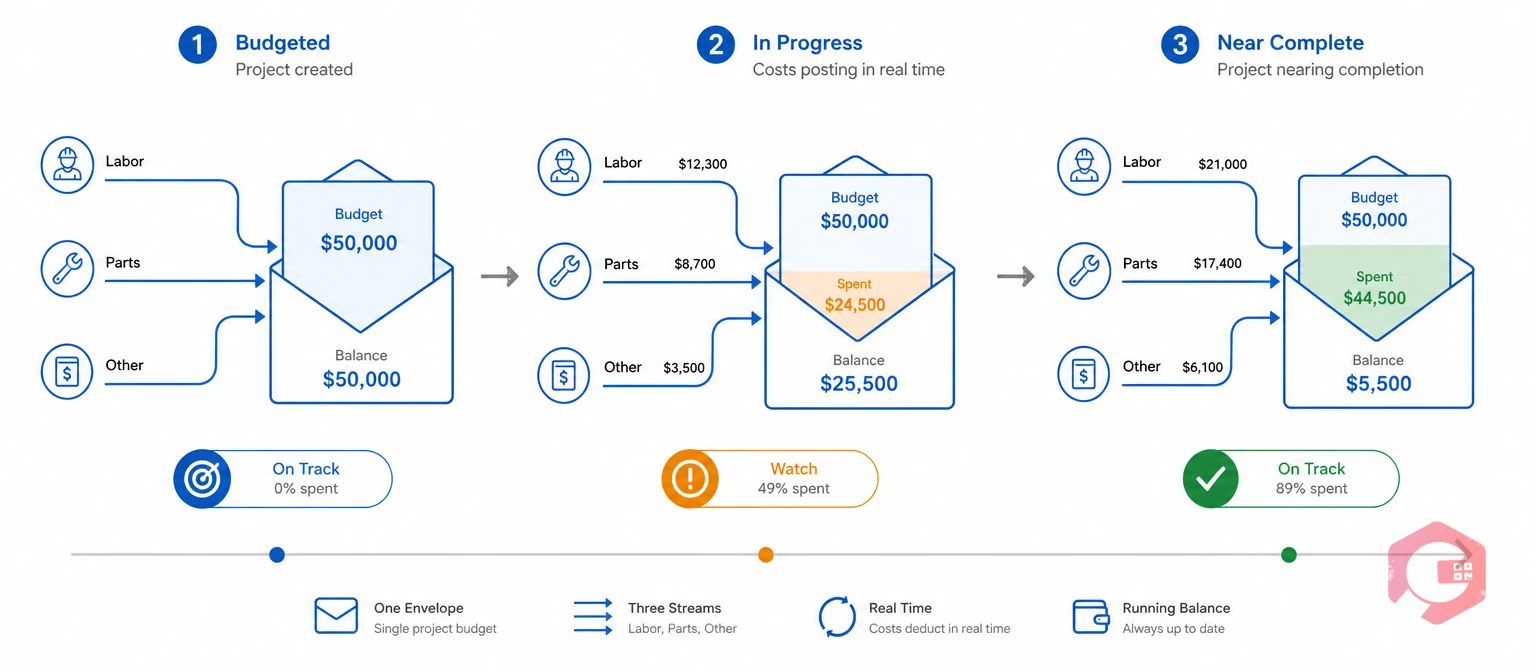

How project-based budget tracking deducts labor, parts and other costs in real time | Cryotos

Project-based budget tracking is tying a maintenance budget to one project and tracking spend against it in real time. Instead of one annual maintenance budget covering an entire site, each project — a line upgrade, a shutdown, a compliance retrofit — gets its own budget, its own milestones, and its own running total.

This matters because maintenance spend rarely comes from one source. A single project can draw on technician labor, spare parts pulled from inventory, and a contractor invoice for specialist work. Tracking those three cost streams against one project total is what lets a manager say exactly how much budget is left, and which category is burning through it fastest.

A general annual maintenance budget spreads spend across a full year of unrelated work orders. It rarely gets reviewed until the numbers are already in the red.

Why Traditional Maintenance Budgeting Falls Short

Traditional maintenance budgeting falls short because it tracks total spend against one broad annual figure, not against the specific job that caused the cost. A plant might know it has spent 60% of its annual budget by June. It rarely has a clear way to say which project, asset, or cost category drove that spend.

  • Blended costs hide the cause. Maintenance costs span routine upkeep, spare parts, labor, contractor fees, energy, and safety compliance. Logged against one annual number, a single overrunning project can quietly eat the budget meant for three other jobs.
  • Reviews come too late. Most teams find out about an overrun during a year-end review, not while the project is still active and the spend can still be corrected.
  • No project-level owner. When spend sits in one shared pool, no single person is accountable for a specific job going over budget.

The Society for Maintenance and Reliability Professionals benchmarks total maintenance cost at roughly 2-5% of replacement asset value each year for most industrial operations. Facilities that run above that range usually trace it back to spend they could not attribute to one clear cause until the year was already over.

The ISO 55000 asset management standard frames good maintenance spend as a balance of cost, risk, and performance. That balance is hard to strike when spend is only visible at the level of one annual total, not the project driving it.

The Four-Layer Project Budget Control Stack

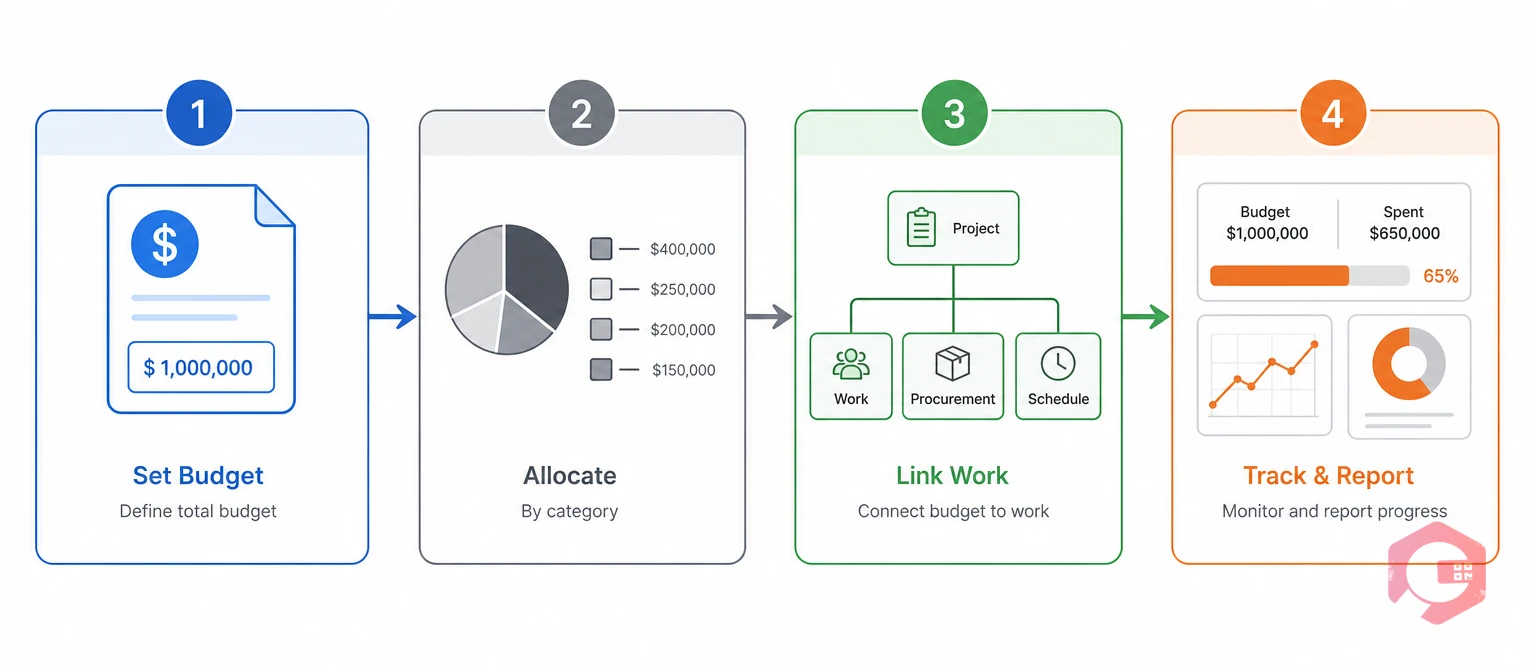

The four-layer project budget control stack: set, allocate, link, track | Cryotos

The Four-Layer Project Budget Control Stack: a way to turn any maintenance project into one with real spend control, built from four connected steps.

  • Set the Budget: Define a total budget for the project, plus a start date, end date, and milestones. Every other layer depends on this one.
  • Allocate by Category: Split that total across labor, parts, and other costs by percentage. This shows which category is overrunning, not just whether the total is.
  • Link the Work: Connect every work order and PM task tied to the project so its cost rolls up on its own, with no manual entry.
  • Track and Report: Check spend against budget on demand or on a set schedule, so drift gets caught while there's still time to fix it.

Each layer builds on the one before it. A project with no category split can still show a total that's over budget, but not why — and knowing why is the entire point.

Use a mean maintenance cost calculator to check what a similar project has cost in the past before setting next quarter's budget. That turns a guess into a number grounded in your own data.

How to Set Up Project-Based Budget Tracking Step by Step

Five steps to set up project-based budget tracking in a CMMS | Cryotos

Setting up project-based budget tracking starts with defining the project, then building the cost controls around it. Here is the sequence maintenance teams use in practice.

  • Step 1 — Define the project and total budget. Name the project. Set a start date, an end date, and the total budget it can spend.
  • Step 2 — Set milestones. Break the project into phases with their own dates, so a multi-week shutdown stays on schedule, not just on budget.
  • Step 3 — Allocate budget by category. Split the total across labor, parts, and other costs by percentage, based on what a similar past project actually spent.
  • Step 4 — Link work orders and PM tasks. Tag every work order connected to the project, so completed work deducts from the right category on its own.
  • Step 5 — Review spend against budget. Check the project summary often — weekly during a fast-moving shutdown, monthly on a longer job — and flag any category trending over its share early.

A project that skips Step 3 still shows a running total, but it cannot say whether labor or parts is the problem. That is usually the more useful question during an active shutdown.

Project-Based Budgeting vs. Traditional Maintenance Budgeting

Project-based budgeting and traditional annual budgeting differ most in when an overrun becomes visible, and how precisely it can be traced. The table below breaks down the differences maintenance teams run into most often.

DimensionProject-Based BudgetingTraditional Annual Budgeting
Budget scopeOne defined project with its own start and end dateOne total covering a full year of unrelated work
When overruns surfaceIn real time, as costs post against the projectUsually at month-end or year-end review
Cost visibilityBy category: labor, parts, other costsLump sum, rarely broken down by cause
AccountabilityClear owner per project and per milestoneShared across the whole maintenance department
Best fit forShutdowns, refurbishments, capex work, retrofitsSteady-state routine maintenance with stable spend

Most facilities run both models side by side: a stable annual budget for routine PM work, and project-based tracking layered on top for anything with a defined start, end, and dedicated spend.

How Cryotos Supports Project-Based Budget Tracking

Cryotos supports project-based budget tracking through its Project and Budget module. Teams set up a project with a total budget, milestones, and category allocations. The system then deducts real costs on its own as linked work orders close, so parts, labor, and other costs subtract from the project's running total with no manual reconciliation.

Parts consumed against a project draw from the same inventory management data that tracks stock valuation. The cost hitting the project budget reflects actual parts cost, not a rough estimate. Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. Fewer emergency repairs also means fewer unplanned hits to a project's budget.

Once a project closes out, the report builder turns the project summary into a recurring report. Schedule it weekly during an active shutdown, or monthly on a longer capital project, so budget oversight does not depend on someone remembering to open a dashboard.

Common Mistakes That Blow Up Maintenance Budgets

Five common mistakes that blow up maintenance budgets | Cryotos

Most maintenance budget overruns trace back to a handful of repeat mistakes, not genuinely unpredictable costs.

  • Tracking one lump-sum total instead of categories. A project that looks "on budget" overall can still have labor running 40% over while parts sit under — invisible until the category split is broken out.
  • Leaving work orders untagged. A work order that is never linked to its project loses that cost from the running total, understating true spend.
  • Reviewing spend only at project close. By the time a final report shows an overrun, the money is already spent. Reviews need to happen while the project is still active.
  • Ignoring contractor and energy costs. A budget built only around labor and parts misses the contractor invoices and energy spend that broader asset management practice shows as real line items over an asset's life.
  • No baseline from past projects. Setting a budget without checking what a similar project cost last time turns budgeting into a guess instead of a forecast.

Most teams that successfully control project spend catch these five patterns early, usually within the first project or two after adopting category-level tracking.

Frequently Asked Questions

What is project-based budget tracking in maintenance?

Project-based budget tracking sets a dedicated budget for one maintenance project — like a shutdown or refurbishment — and deducts actual labor, parts, and other costs from that budget as work is completed, instead of logging all spend against one general annual total.

How is project-based budgeting different from a regular maintenance budget?

A regular maintenance budget covers a full year of routine, largely unrelated work orders. Project-based budgeting ties a specific budget to one defined project with its own start date, end date, and milestones, so you can see exactly what a single project cost rather than a blended annual figure.

Can I track maintenance spend by category, not just total cost?

Yes. Allocating a project's budget by percentage across labor, parts, and other costs is one of the most effective ways to catch an overrun early, since a category running hot shows up well before the total budget is gone.

What should I do if a maintenance project is going over budget?

Check which cost category is driving the overrun first: labor, parts, or other costs. The fix differs by cause. A labor overrun might mean reassigning technicians or reviewing overtime. A parts overrun often points to emergency purchases that a better inventory reorder threshold could have prevented.

Do I need a CMMS to do project-based budget tracking?

You can track a project budget in a spreadsheet, but every cost still has to be entered by hand after the fact. That delay is exactly what lets overruns go unnoticed. A CMMS with a built-in project and budget module deducts costs on its own as linked work orders close, so the budget stays current with no extra data entry.

Controlling maintenance spend comes down to tracking costs at the level where decisions actually get made: the project, not the annual total. Schedule a free demo to see how Cryotos ties project budgets directly to your work orders, parts inventory, and reporting in one system.
