Strategies to Optimize Shutdowns, Turnarounds, and Outages

Calendar
Duration:
9 min read
calendar today
Published on
May 26, 2026
Featured Image

Shutdowns, turnarounds, and outages (STO) are planned maintenance events where an entire plant, unit, or critical piece of equipment is taken offline for inspection, repair, or overhaul. Done well, they protect asset reliability and safety. Done poorly, they drain budgets, extend timelines, and cost millions in lost production.

According to a McKinsey report on turnaround performance, industrial companies consistently overrun STO budgets by 10–30%, and schedule overruns average 15–20%. The root cause is almost always poor planning, weak scope management, or lack of real-time visibility during execution.

This guide walks you through proven strategies to plan, execute, and close out shutdowns, turnarounds, and outages so your team hits scope, schedule, and cost targets every time.

What Are Shutdowns, Turnarounds, and Outages?

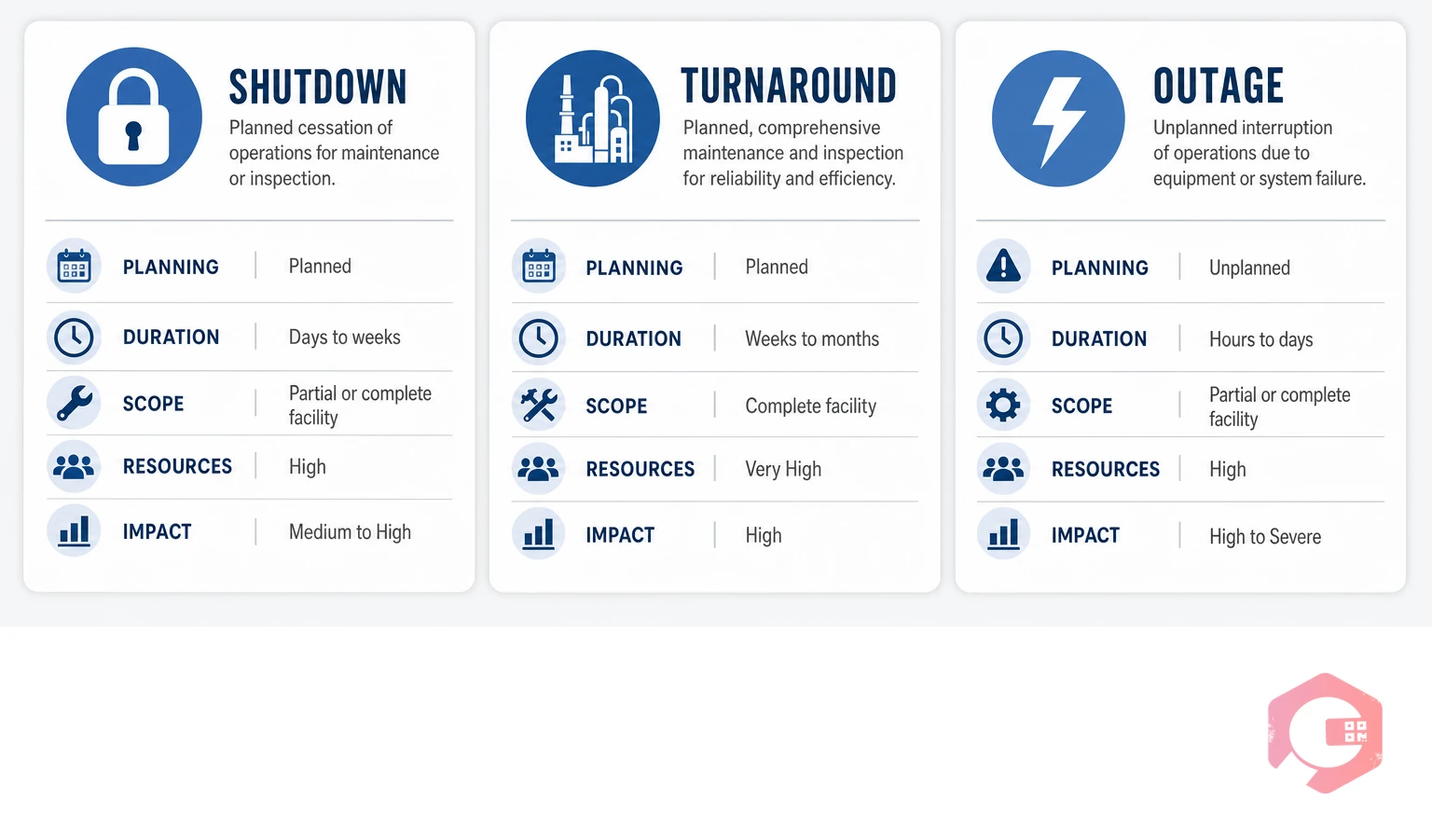

Shutdown vs Turnaround vs Outage comparison | Cryotos

Before getting into strategy, it helps to be clear on what each term means — they are often used interchangeably, but they have distinct profiles:

  • Shutdown: A planned stop of production or operations for maintenance, inspection, or regulatory compliance. Typically covers a specific unit or system.
  • Turnaround (TAR): A comprehensive, scheduled overhaul of an entire plant or major process unit. Turnarounds are infrequent (every 2–5 years), high-cost, and involve hundreds or thousands of work orders executed in parallel.
  • Outage: Common in power generation and utilities, an outage is a planned or unplanned stoppage for maintenance or repair. Planned outages follow a similar preparation cycle to turnarounds.

All three share a common challenge: maximum work must be completed in minimum time, with zero safety incidents and on-budget execution. That demands structured preparation months in advance, not days.

Why STO Events Fail: Common Pitfalls

4 common reasons STO events fail | Cryotos

Most cost and schedule overruns trace back to a handful of recurring failures. Understanding them is the first step to avoiding them.

Scope Creep

Late additions to the work scope are the single biggest driver of overruns. When new jobs are discovered during execution without a formal scope-change process, they consume float time, trigger resource conflicts, and push out critical-path tasks. Every job added during execution costs three to five times more than if it had been planned beforehand.

Poor Materials Management

A work order without parts is a guaranteed delay. Incorrect or missing materials — gaskets, seals, valves, specialty fasteners — stop craft workers mid-job and extend total outage duration. Industry data from the Maintenance World community suggests that 20–30% of craft labor hours on turnarounds are wasted waiting for parts.

Inadequate Contractor Coordination

TARs rely on a mix of internal crews and dozens of specialty contractors. Without clear role definitions, permit coordination, and shared scheduling systems, contractors duplicate work, queue for permits at the same time, and create safety hazards through simultaneous operations.

Weak Permit-to-Work Systems

Manual, paper-based permit-to-work processes create bottlenecks at the permit desk and increase the risk of errors. When LOTO procedures are paper-based, verification is slow, and simultaneous isolations become hard to track.

Insufficient Post-Event Analysis

Teams rush back to production and skip lessons-learned capture. The same planning mistakes repeat on the next TAR because no institutional knowledge was documented.

Phase 1: Long-Range Planning (12–18 Months Out)

The difference between a well-run turnaround and a chaotic one is decided in the planning phase, not during execution. High-performing organizations start formal planning 12–18 months before the event date.

Define Scope Early and Freeze It

Start with a comprehensive scope identification process. Use inspection findings, reliability data, regulatory requirements, and predictive maintenance alerts to build the initial work list. Set a hard scope freeze date — typically 3–4 months before the event — and enforce it through a formal change-management process after that date.

Every scope addition after freeze must go through a review that documents the reason, the cost impact, and the schedule impact before approval. This single discipline prevents most overruns.

Develop the Critical Path Schedule

Build a detailed, logic-linked schedule in a CPM (Critical Path Method) tool. Identify the longest path from first vessel opening to final handover. Any task on the critical path that slips pushes the restart date. Protect the critical path by pre-positioning resources, pre-ordering long-lead materials, and identifying float on non-critical paths that can absorb scope additions.

Establish the Resource Plan

Model the labor histogram — daily crew requirements by craft discipline — and match it against contractor capacity. Peak labor during a large TAR can exceed 1,000 workers. Stagger shifts, plan laydown areas, and coordinate with contractors early so they can recruit and mobilize the right headcount.

Phase 2: Materials and Procurement (6–12 Months Out)

Parts shortages cause more TAR delays than any other single factor. A disciplined materials management process eliminates them.

Bill of Materials Verification

For every work package in scope, verify the bill of materials against current equipment specifications. Drawings and data sheets go stale over years of operation. Sending a technician to physically verify tag numbers, flange ratings, and gasket dimensions before the procurement order is placed prevents the wrong parts from arriving on the job.

Kitting and Pre-Staging

Pre-kit parts and materials by work package. When the job starts, everything the craft team needs — consumables, spare parts, specialty tools — is staged at a designated laydown point, ready to pick up. Kitting eliminates the time workers spend searching the warehouse during the event. Cryotos's spare parts inventory software makes it straightforward to build kits against work orders and track what has been issued versus what is still in stock.

Inventory Replenishment Alerts

For critical consumables — seals, gaskets, packing material — set minimum stock thresholds so reorder triggers fire automatically before items run out. A real-time inventory management system with threshold alerts prevents the mid-event emergency where the team discovers a fast-moving consumable is exhausted.

Phase 3: Work Package Preparation (2–4 Months Out)

A work package is the document set that tells the crew everything they need to do their job: scope description, step-by-step procedure, isolation requirements, safety permits, drawings, parts list, and estimated hours. Poor work packages are the most common source of craft inefficiency during execution.

Standardize Work Package Templates

Use standardized templates for common job types — heat exchanger bundle pull, pump overhaul, vessel inspection, valve replacement. Standardization cuts preparation time and reduces errors. It also makes it easier for contractors who are not familiar with the site to execute jobs safely.

Integrate Permit-to-Work into the Work Package

The isolation certificate and permit-to-work documents should be part of the work package, not a separate queue the crew has to join after arriving at the job site. When permits are prepared in advance and linked to the work order, the crew can walk up to the job ready to start instead of waiting 45 minutes at the permit desk. Cryotos's built-in permit-to-work workflow automates the issuance and tracking of permits linked to work orders, which is especially valuable when hundreds of permits are active simultaneously.

Review and Validate Procedures

Have an experienced technician or reliability engineer walk down each work package before the event and verify that the procedure matches field conditions. Drawings may not reflect the last modification. Valve tags may have changed. A short pre-event walkdown prevents job stoppages caused by outdated documentation.

Phase 4: Execution Management

Once the event starts, the focus shifts from planning to real-time control. The goal is maximum wrench time — the percentage of hours workers spend actually working versus waiting, travelling, or looking for information.

Daily Progress Meetings

Hold a short daily stand-up meeting — ideally twice per day during peak execution — that covers progress against the critical path, emerging issues, resource constraints, and permit status. Keep it to 30 minutes. The purpose is to identify problems early enough to act, not to review everything.

Real-Time Work Order Tracking

Track work order completion in real time, not at end of shift. When supervisors update job status on a mobile app as each job completes, the control room sees live progress against the schedule and can redeploy resources to bottlenecks before they become critical. Cryotos's work order management module, combined with the mobile app, gives field supervisors instant update capability and gives planners a live view of progress from the control room.

Scope Change Control

Even with a hard scope freeze, discoveries during execution will generate change requests — a corroded fitting that needs replacement, a bearing that's worse than expected. The execution team needs a fast, documented change process: log the finding, estimate the impact, get approval, issue the work order. Every change should be tracked against a contingency reserve so the cost and schedule impact remains visible.

Contractor Coordination and Safety

During peak execution, simultaneous operations create the highest risk window. Use a shared coordination board — physical or digital — that shows who is working where, what isolations are active, and where hot work is in progress. The OSHA lockout/tagout standard (29 CFR 1910.147) requires that energy control procedures are documented and verified before any maintenance on equipment that could unexpectedly energize. Digital LOTO tracking makes compliance verifiable and auditable.

Phase 5: Closeout and Lessons Learned

The closeout phase is consistently underinvested. Teams are eager to restart production and skip the structured review that would make the next event cheaper and faster.

Punch List Management

Every item that was not completed to specification during the event goes on a formal punch list. Categorize items by priority: Category A (must be resolved before startup), Category B (can be deferred to next outage window), Category C (noted for long-range planning). Track each punch list item to closure with a responsible owner and target date.

Cost Capture and Variance Analysis

Compare actual cost and hours against the estimate at both the overall and individual work-package level. Understanding where the estimates were wrong — overruns concentrated in specific job types, crafts, or contractors — gives the estimating team the data to improve next time. Cryotos's report builder can generate post-event variance reports across all work orders so planners have clean data without manual spreadsheet aggregation.

Formal Lessons Learned Review

Within two weeks of restart, run a structured lessons-learned workshop with planners, supervisors, contractors, and operations. Capture what worked, what failed, and what to change. Store the output in a shared knowledge base — not in someone's personal folder — so it is accessible to the team planning the next event. Cryotos's AI-powered knowledge base is built for exactly this use case: capturing institutional knowledge and making it searchable for the next planning cycle.

How CMMS Improves STO Performance

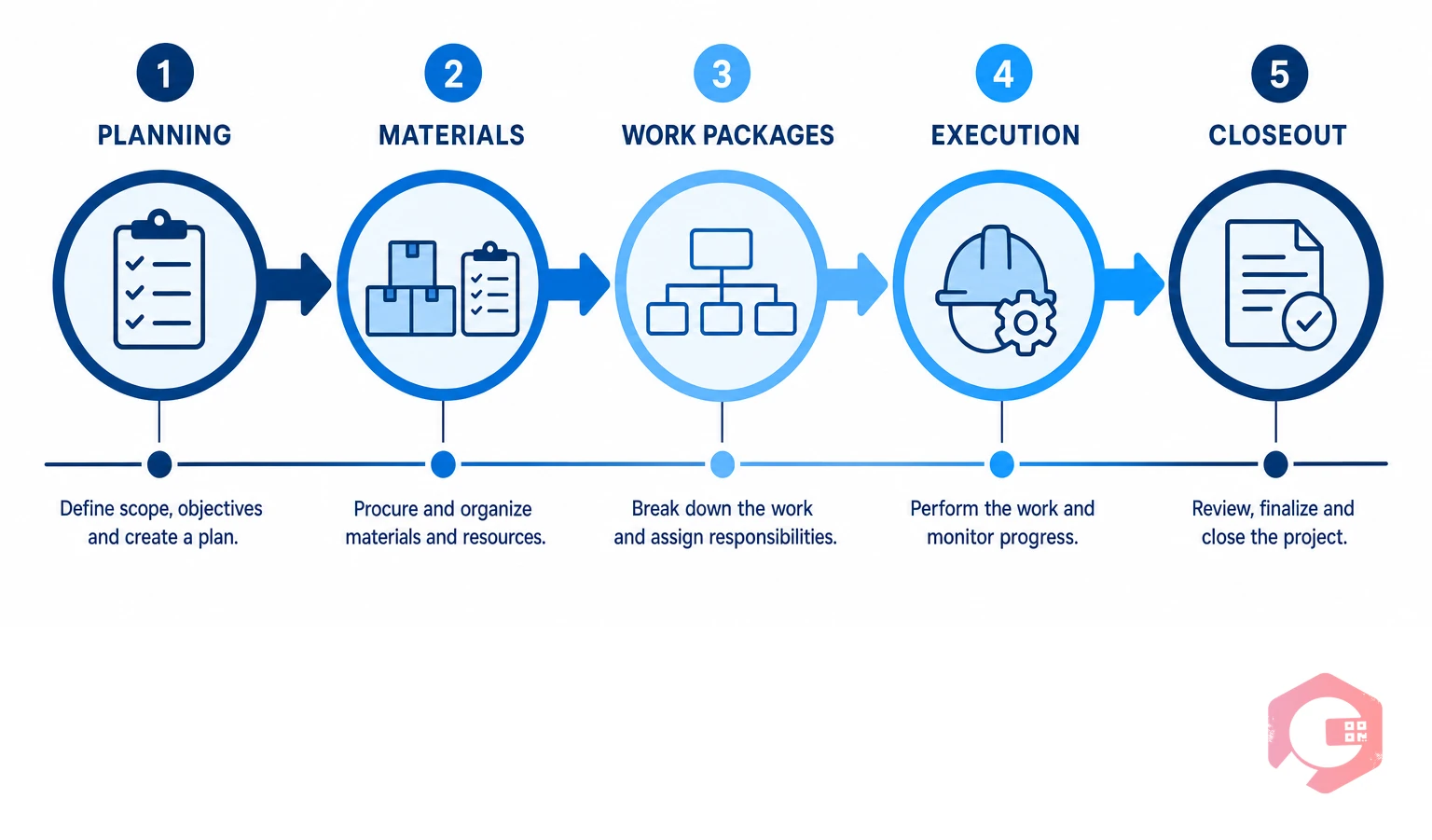

5-phase STO planning timeline: planning, materials, work packages, execution, closeout | Cryotos

A modern maintenance management software platform ties every phase of an STO event together in one system. Instead of planning in spreadsheets, tracking in whiteboards, and reporting in PowerPoint, teams work from a single source of truth.

  • Scope management: All work orders are created, reviewed, and approved in the system. Scope freeze is enforced through workflow rules that require authorization for any post-freeze addition.
  • Materials management: Parts are kitted against work orders, stock levels are tracked in real time, and reorder alerts fire automatically. No more mid-event parts hunts.
  • Permit-to-work: Permits are created, issued, and closed digitally, linked to the specific work order and isolation point. Simultaneous operations are visible on a live dashboard.
  • Progress tracking: Mobile updates from the field give planners a live view of work order completion against the schedule. Resource redeployment decisions are based on facts, not guesses.
  • Reporting: Post-event cost and schedule variance reports are generated automatically from work order data, not assembled manually from contractor invoices.

Organizations using a purpose-built CMMS for STO planning consistently report 10–20% reductions in total event cost and duration compared to spreadsheet-driven approaches.

Key Metrics to Track for STO Success

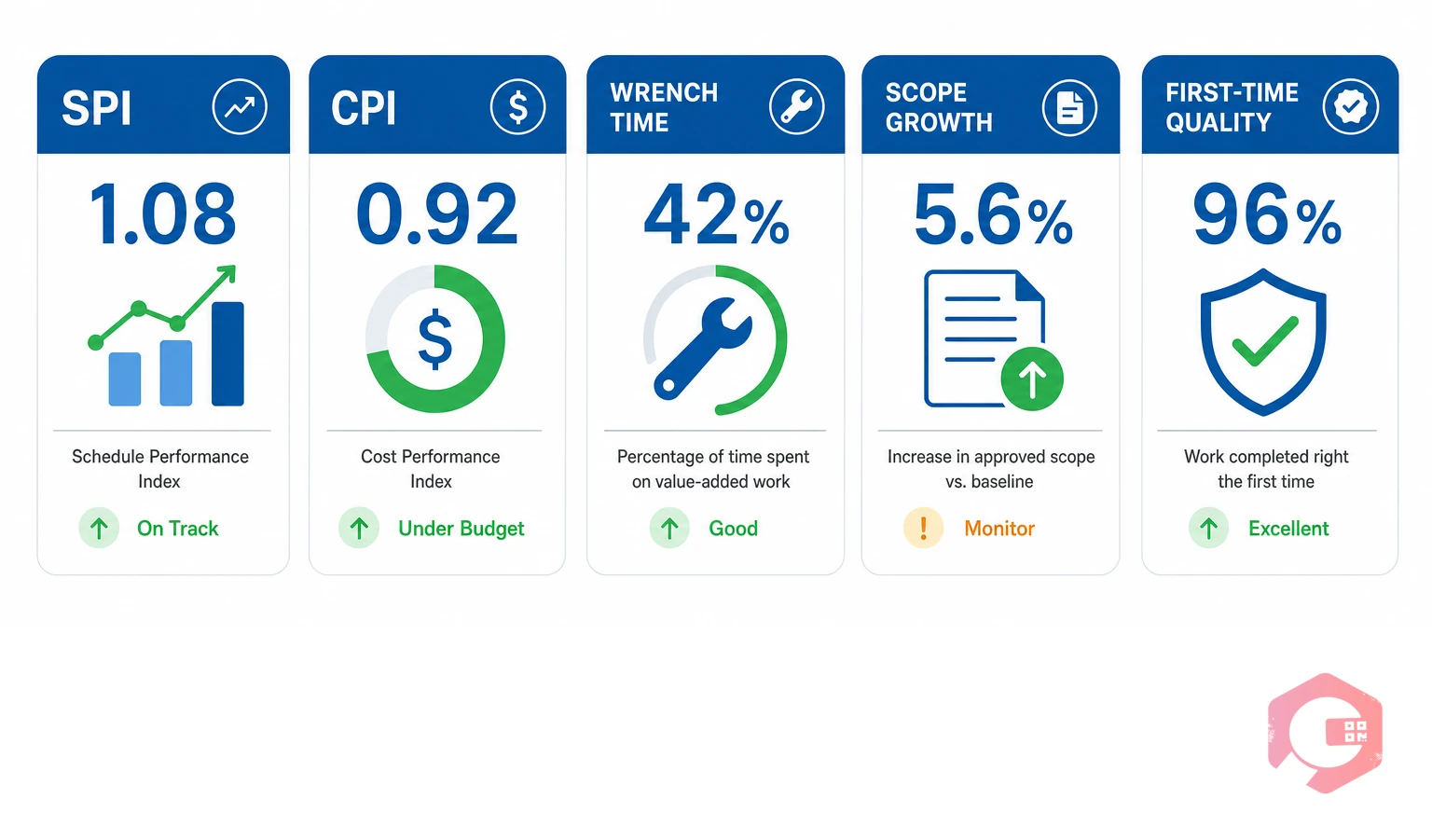

5 key STO performance metrics: SPI, CPI, Wrench Time, Scope Growth, First-Time Quality | Cryotos

You can't improve what you don't measure. These are the metrics that matter most for STO performance:

  • Schedule Performance Index (SPI): Earned value divided by planned value. SPI below 1.0 means the event is running behind schedule.
  • Cost Performance Index (CPI): Earned value divided by actual cost. CPI below 1.0 means cost is running above plan.
  • Wrench Time: The percentage of paid hours where craft workers are actively doing productive work. Industry average is 25–35%; high-performing events reach 50–60%. Use Cryotos's wrench time calculator to benchmark your team.
  • Scope Growth Rate: The percentage increase in work orders from the scope freeze date to event completion. A growth rate above 10% signals poor scope identification during planning.
  • First-Time Quality Rate: The percentage of jobs completed correctly without rework. Rework during an event is expensive because it consumes labor that was allocated to other critical-path jobs.
  • Safety Incident Rate: Total recordable incidents per 200,000 hours worked. The correlation between safety performance and schedule performance is well documented — events that run safely also tend to run on schedule.

Frequently Asked Questions

What is the difference between a shutdown and a turnaround?

A shutdown typically refers to stopping a specific unit or system for maintenance, while a turnaround is a comprehensive, plant-wide overhaul that is scheduled years in advance and involves a much larger scope of work, contractor workforce, and budget. Both require the same disciplined planning process, but turnarounds demand more rigorous scope management, resource planning, and coordination because of their scale.

How far in advance should you start planning a turnaround?

For a major turnaround, formal planning should begin 12–18 months before the event date. Scope identification starts at 12 months, materials procurement begins at 6–9 months, and detailed work package preparation runs from 2–4 months out. Starting late on any of these phases cascades into scope overruns, parts shortages, and contractor availability problems during execution.

What is scope creep and how do you prevent it?

Scope creep is the addition of work after the scope freeze date, either from opportunistic requests or from discoveries made during execution. You prevent it by setting a hard freeze date, creating a formal change control process for any post-freeze additions, and requiring documented approval with cost and schedule impact for every change. Tracking scope growth rate as a KPI after each event gives you data to improve scope identification in the next planning cycle.

Can a CMMS be used for turnaround management?

Yes. A modern CMMS handles work order creation, scheduling, permit-to-work, materials management, progress tracking, and post-event reporting — all the core functions of turnaround management. The advantage over dedicated TAR software is that the same system is used for routine maintenance year-round, so the asset and work history data is already in place when planning begins. Cryotos is designed to support both day-to-day maintenance operations and complex planned events like turnarounds and outages.

What safety standards apply to shutdown and turnaround work?

Key standards include OSHA 29 CFR 1910.147 (lockout/tagout), OSHA 1910.146 (confined space entry), and OSHA 1910.119 (process safety management for highly hazardous chemicals). In regulated industries, facilities must also comply with the EPA Risk Management Program (RMP) and relevant API recommended practices for inspection. All isolation, permit-to-work, and confined space procedures should be verified and documented before any work begins.

Shutdowns, turnarounds, and outages are among the highest-risk, highest-cost events in industrial maintenance — but they are also among the most predictable. Every overrun has a root cause, and every root cause has a countermeasure. Cryotos gives your team the planning, execution, and reporting tools to run every STO event on scope, on schedule, and on budget. Book a demo to see how leading industrial operators use Cryotos to take the unpredictability out of their next turnaround.
