Why Do Reliability-Centered Maintenance Programs Fail?

Calendar
Duration:
13 min
calendar today
Published on
October 28, 2026
Featured Image

Reliability-centered maintenance programs fail in the majority of cases — not because the methodology is flawed, but because the outputs of the analysis never become operational. Industry practitioners estimate that 50–70% of reliability-centered maintenance implementations fail to achieve their intended outcomes within two to three years of initiation. The causes are almost never technical. They are structural: the gap between completing a rigorous FMEA analysis and consistently delivering the resulting tasks at scale is where most programmes quietly collapse.

This guide names the eight root causes — with the warning signs that tell you a programme is heading toward each one before it fully fails.

Key Takeaways

  • Analysis ≠ programme: A completed FMEA analysis has zero operational value until every selected task exists as a live, auto-generated work order in a maintenance management system.
  • The CMMS gap is the most common failure point: RCM tasks that are never loaded into the operational system — or loaded incorrectly — cannot prevent failures, regardless of how rigorous the analysis was.
  • RCM is iterative by design: A programme that completes one analysis and freezes degrades within 18 months; the feedback loop from work order data back to the failure mode library is what makes RCM improve over time.
  • Measurement determines survival: Programmes that cannot show MTBF improvement data within 12 months of go-live lose management support and funding before outcomes materialise.

Failure Cause 1: Treating Reliability-Centered Maintenance Analysis as the End Goal

The implementation gap between completed RCM analysis and live work orders | Cryotos

The most common reliability-centered maintenance failure is treating the FMEA analysis as the programme’s goal rather than its starting point. Organisations invest months of engineer time in structured analysis workshops, produce detailed workbooks documenting hundreds of failure modes and their associated tasks, and then close the project. The analysis is complete. The programme has failed.

An FMEA analysis is the specification for a maintenance programme — not the programme itself. Until the selected tasks are configured as recurring work orders in the operational system, they have no effect on asset reliability. Organisations that celebrate the completion of the analysis as programme success have confused the map with the territory.

Warning Signs

  • The project plan shows “RCM analysis complete” as the final milestone with no downstream configuration steps in any maintenance system.
  • RCM outputs are stored in PDF, Excel, or SharePoint and maintenance planners have not seen them.
  • No new PM work orders were created in the operational maintenance system during or after the analysis period.

Failure Cause 2: Scope Paralysis — Analysing Everything Before Implementing Anything

Scope paralysis occurs when an organisation defines success as completing RCM analysis for every asset in the plant before implementing any tasks. A thorough FMEA for a single complex asset takes 20–40 hours of team analysis. Applied to 2,000 assets, this becomes a multi-year project before any benefit is realised.

The correct approach prioritises by criticality: identify the 20% of assets driving 80% of downtime, implement tasks for those assets first, measure outcomes, then extend scope. Most programmes that attempt full-plant analysis before any implementation run out of budget or management patience and are abandoned before any tasks go live.

Warning Signs

  • The RCM project covers all assets with no defined priority tier or implementation phase separate from analysis.
  • The RCM team is 100% allocated to analysis with no time or resource planned for CMMS configuration.
  • The programme has been running for 12+ months and no new PM tasks have been activated in the maintenance system.

Failure Cause 3: The Failure Mode Library Never Closes the Loop

RCM is designed to be iterative — the initial analysis is a starting point, not a permanent answer. After implementation, actual failure data should continuously update the failure mode library: confirming failure frequencies, identifying missed failure modes, and retiring tasks for failures that never occur in practice.

Most failed reliability-centered maintenance programmes are static. The analysis is done once, tasks are implemented, and the failure mode library is never revisited. Five years later, the programme maintains assumptions from the original analysis rather than responding to how assets actually behave. The FMEA methodology itself demands iteration — a programme that does not update its analysis is not running RCM, it is running an ageing PM schedule with a better origin story.

Warning Signs

  • No defined review cycle exists for updating the failure mode library after the initial analysis.
  • Work order failure codes are not structured to link back to the failure mode the task was designed to address.
  • Technicians who close PM work orders record “completed” with no finding data that distinguishes “failure detected” from “no finding”.

Before implementing your RCM programme, establish your baseline reliability data. Use the MTBF calculator to calculate your current mean time between failures for each priority asset — the reference point for measuring post-RCM improvement.

Failure Cause 4: No CMMS Integration — The Implementation Gap

The reliability-centered maintenance implementation gap is the failure to translate RCM task outputs into live, correctly configured work orders in the operational maintenance system. This is the highest-frequency, highest-impact failure cause in real-world RCM programmes, and it is almost never discussed as the distinct failure mode it represents.

Three variants of this failure occur in practice:

  • Tasks are never loaded at all: RCM outputs remain in the analysis document and no corresponding PM work orders are created in the maintenance system.
  • Tasks are loaded incorrectly: On-condition tasks are configured as time-based tasks because the CMMS does not support condition-triggered work orders, or because the configuration was not done by someone who understood the difference.
  • Tasks lack essential context: Work orders carry no failure mode description, no acceptance criteria, and no indication of what the technician should record — making the task impossible to execute correctly.

Use preventive maintenance software that supports both time-based and condition-triggered work orders, and that can link each PM task to the specific failure mode it addresses. Without that link, the CMMS cannot close the feedback loop even when the right tasks are loaded.

Failure Cause 5: No Measurement of Task Effectiveness

A reliability-centered maintenance programme without measurement cannot learn, cannot improve, and cannot justify its continued investment. The SMRP Best Practices Metrics framework gives clear guidance on what to track. Yet most RCM programmes define success as PM completion rate alone — a measure of effort, not outcome.

Four KPIs drive RCM programme health: PM completion rate by RCM cohort (effort); on-condition finding rate — what share of on-condition tasks detect a developing failure (task quality); MTBF trend vs. pre-RCM baseline (outcome); and maintenance cost per output unit vs. baseline (financial return). Without the second and third measures, a programme cannot tell which tasks work from those with the wrong interval, wrong trigger, or a failure mode that never occurs.

Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround — outcomes that only become visible when MTBF and downtime data is being tracked and compared to baselines. A maintenance KPI dashboard that auto-generates these metrics from work order data is the difference between a programme that can prove its value and one that cannot.

Failure Cause 6: Cultural Rejection by the Operations Team

RCM analysis conducted without the involvement of the technicians and supervisors who will execute the resulting tasks almost always produces cultural rejection. Reliability engineers who run analysis workshops without operations staff create an adversarial dynamic. Technicians receive work orders from an analysis they never saw, describing failure modes they were never asked about.

The result is compliance without engagement — tasks signed off but not properly done. Findings go unrecorded because nobody explained what the data is for. Over time, the maintenance team routes around the RCM-generated tasks and the programme becomes invisible in practice even as it appears complete on paper.

Warning Signs

  • Technicians were not represented in any RCM analysis workshop.
  • Maintenance supervisors have not reviewed the RCM task list and cannot explain why specific tasks were selected.
  • No training was provided on what the new task descriptions mean, what acceptance criteria apply, or why the finding data matters.

Failure Cause 7: Management Commitment Collapses Before Outcomes Are Visible

RCM has a delayed payoff structure that most organisations underestimate: the investment is front-loaded, and measurable outcomes arrive 12–18 months after tasks go live. When a budget review hits at month 9 with no measurable improvements, commitment erodes. Resources shift. The programme loses its sponsor and ends.

Programmes that survive had a sponsor who understood the 18-month timeline upfront. Regular interim metrics — on-condition finding rate, failure mode detection rate — showed the programme was working before MTBF numbers improved.

Failure Cause 8: Analysis Quality Too Low to Be Operational

Analysis quality failure occurs when the FMEA is done but the output does not meet SAE JA1011 — the formal RCM evaluation standard. The most common quality failures are: failure modes described at system level rather than mechanism level; intervals set by gut feel rather than P-F interval analysis; and consequence ratings that do not justify the task investment.

Nowlan and Heap’s original reliability-centered maintenance study found that only 11% of failure modes follow the “bathtub curve” that time-based PM addresses. The other 89% require different task types. Applying time-based tasks to all failure modes is structurally wrong.

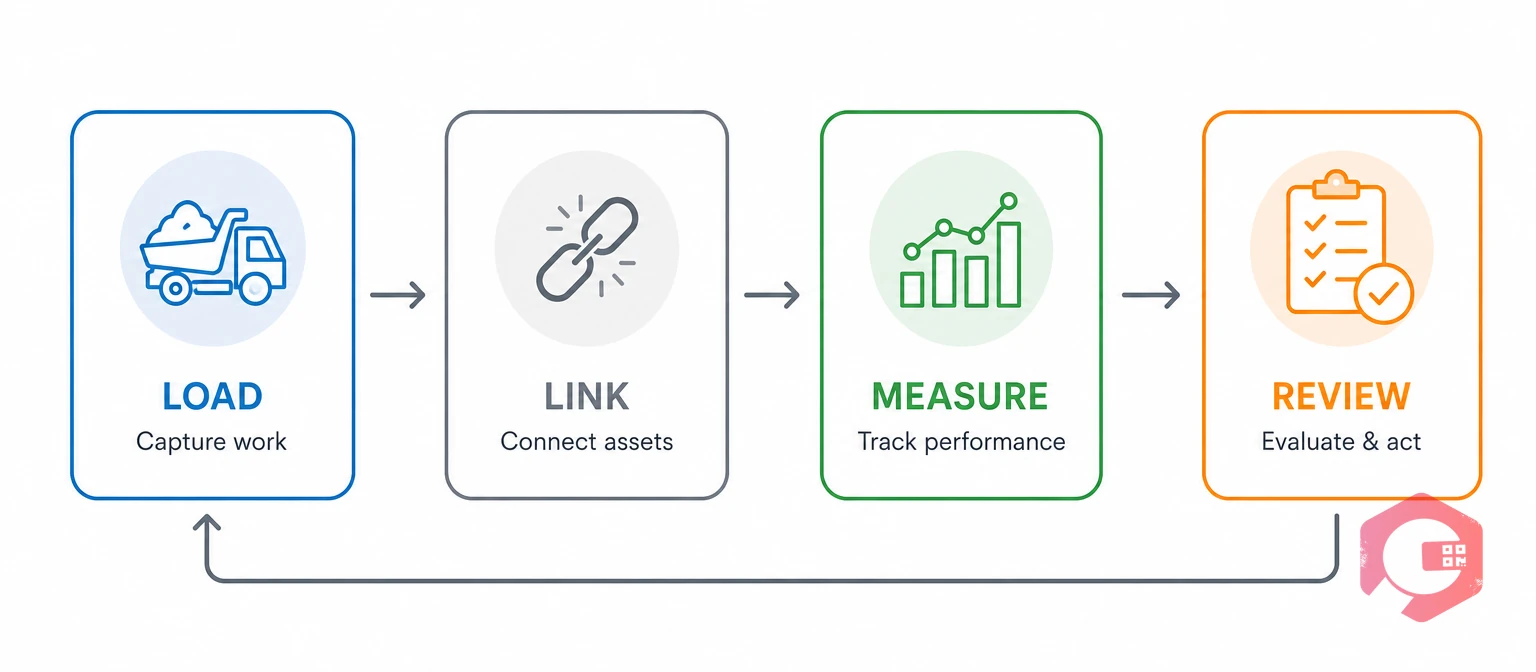

The LOAD-LINK-MEASURE-REVIEW framework for RCM programme recovery | Cryotos

The four most damaging failure causes — analysis without operationalization, CMMS implementation gap, no feedback loop, and no measurement — share a structural solution. The LOAD-LINK-MEASURE-REVIEW framework addresses all four in a sequence that can be applied to a new programme or used to rescue a failing one.

The LOAD-LINK-MEASURE-REVIEW Framework:

  • LOAD: Transfer every RCM task output into the operational maintenance system as a live, correctly triggered work order — time-based, meter-based, or condition-triggered — before the analysis project closes. A task that is not in the CMMS does not exist operationally.
  • LINK: Attach each PM work order to the specific failure mode it targets. When the work order closes, the technician records the finding against that failure mode — detecting, not detecting, or false alarm. This link is the mechanism that makes the analysis iterative.
  • MEASURE: Track four KPIs quarterly: PM completion rate by RCM cohort; on-condition finding rate; MTBF trend versus pre-RCM baseline; maintenance cost per output unit versus baseline. These four numbers determine whether the programme is working and where to focus improvement effort.
  • REVIEW: Every 6 months, convene the RCM team to review MEASURE output. Update failure mode frequencies, retire tasks with no findings, add tasks for new failure modes found in reactive work orders. The analysis is a living document.

How Cryotos Prevents the Most Common RCM Failures

How Cryotos CMMS modules prevent the most common RCM failures | Cryotos

The structural failures that destroy most reliability-centered maintenance programmes are addressable at the system level. A Computerized Maintenance Management System that is designed to support RCM — not adapted from a generic PM scheduling tool — closes the gaps that cause programmes to collapse between the analysis and the outcome.

  • LOAD — PM Schedule Module: Every RCM task output is configured as a recurring PM work order in Cryotos, with the failure mode it targets, acceptance criteria, and responsible skill embedded in the work order. Tasks generate automatically on the defined trigger.
  • LINK — Work Order Failure Code Library: When a technician closes a Cryotos PM work order, the finding is recorded against the specific failure mode the task addresses — failure detected, no finding, or false alarm. This data feeds back to the failure mode library, making the analysis iterative without manual data entry.
  • MEASURE — BI Dashboard and Downtime Tracking: MTBF trend, PM completion rate, on-condition finding rate, and maintenance cost per asset are auto-generated from work order data in the Cryotos BI dashboard — no manual calculation required.
  • REVIEW — Report Builder and Expiration Reminders: The Report Builder generates the failure mode frequency report for each 6-month review cycle. The review date itself is scheduled as a tracked task in Cryotos — it happens because the system prompts it, not because someone remembers.

Most reliability-centered maintenance programmes that fail do so not because the analysis was wrong, but because nothing was in place to make the outputs survive contact with daily operations. Use enterprise asset management software designed to bridge the gap between reliability analysis and operational delivery.

Frequently Asked Questions

What percentage of RCM programs fail to achieve their goals?

Industry practitioners estimate that 50–70% of reliability-centered maintenance programmes fail to deliver their intended outcomes within two to three years. This reflects not analytical failure but implementation failure — programmes in which the analysis is completed but the resulting tasks are never operationalized, never measured, and never updated. The SAE JA1011 standard defines seven criteria that a process must meet to qualify as RCM. Programmes that meet fewer than all seven are far less likely to succeed long-term.

Can a failed RCM program be rescued and made to work?

Yes — and the LOAD-LINK-MEASURE-REVIEW framework provides a recovery path that can be applied at any programme stage. A programme that completed its analysis but never loaded tasks into the CMMS can start at LOAD. A programme that loaded tasks but has no feedback loop can start at LINK. A programme that has lost management support can start at MEASURE with a 90-day data sprint to demonstrate results from the tasks already in place.

What is the most common reason RCM analysis delivers no operational benefit?

The most common reason is that the analysis outputs were never loaded into the operational maintenance management system as scheduled work orders. The tasks exist on paper. No technician ever receives a work order from the analysis. This implementation gap causes more programme failures than all other causes combined.

Does using a CMMS make an RCM program more likely to succeed?

A CMMS significantly improves RCM programme survival when integrated into the process from the start — not added after the analysis is complete. The CMMS must support condition-triggered work orders, link PM tasks to failure modes, capture structured task findings, and report MTBF trends against pre-RCM baselines. A generic PM scheduling tool repurposed for RCM often lacks these capabilities. That is why the CMMS implementation gap remains the highest-frequency failure cause.

Reliability-centered maintenance programme failure is a solvable problem — but only if you address the root causes. Schedule a free demo to see how Cryotos supports the full LOAD-LINK-MEASURE-REVIEW cycle and keeps RCM programmes operational beyond the first year.
