The 16 major losses in TPM are a Japan Institute of Plant Maintenance (JIPM) framework that groups every source of wasted equipment time, labor, and material into three categories: eight equipment losses, five human losses, and three resource losses. Together they explain almost every point of hidden efficiency loss on a plant floor. Most of these losses never show up as a single line item on a report — they hide inside "normal" shift variance until a maintenance team starts tracking them individually. A plant running at what looks like 85% efficiency on paper can still be leaking output through six or seven of these categories at once, and nobody notices until the numbers get broken apart loss by loss.

Key Takeaways

  • The 16 losses split into three groups: eight equipment losses that drag down Overall Equipment Effectiveness (OEE), five human losses that cut labor productivity, and three resource losses tied to material, energy, and tooling.
  • Most losses are invisible without structured logging. Minor stoppages, speed shortfalls, and motion waste rarely trigger a work order on their own.
  • A CMMS turns each loss into a trackable data point tied to a specific asset, shift, and root cause instead of a vague monthly efficiency number.
  • Reducing the 16 losses compounds into OEE gains because Availability, Performance, and Quality — the three OEE components — capture all sixteen losses between them.

What Are the 16 Major Losses in TPM?

Three groups of 16 major losses in TPM: Equipment Losses, Human Losses and Resource Losses illustrated as concept cards | Cryotos

Total Productive Maintenance identifies sixteen loss categories that erode equipment effectiveness, workforce productivity, and material or energy efficiency across a plant. JIPM originally developed the framework to give maintenance and operations teams a shared vocabulary for losses that used to get lumped together as "downtime" or "inefficiency." Before the framework existed, a plant manager comparing two lines with the same OEE score had no way to know whether one line was losing time to breakdowns and the other to slow changeovers — the sixteen categories exist precisely to separate those causes.

Equipment Losses — Reduce OEE (8 Losses)

Four key equipment losses in TPM: Breakdown Loss, Setup Loss, Speed Loss, and Defect Loss illustrated as point cards | Cryotos
  • Failure/Breakdown Losses: Unplanned stoppages caused by mechanical, electrical, or component failure.
  • Setup and Adjustment Losses: Time lost during changeovers, die changes, and process adjustments between runs.
  • Cutting Tool/Blade Change Losses: Downtime from replacing worn or broken cutting tools, blades, or dies.
  • Startup/Warm-Up Losses: Reduced output while equipment ramps up to stable conditions after a stop.
  • Minor Stoppage and Idling Losses: Short, frequent stops — jams, sensor trips, misfeeds — that rarely get logged.
  • Speed Losses: The gap between an asset's designed speed and the speed it actually runs at.
  • Defect and Rework Losses: Time and material spent creating, finding, and reworking non-conforming output.
  • Planned Shutdown Losses: Output lost to scheduled maintenance, inspections, and planned downtime windows.

Human Losses — Reduce Labor Productivity (5 Losses)

Five human losses in TPM: Management, Motion, Line Organization, Logistics, and Measurement losses illustrated as point cards | Cryotos
  • Management Losses: Operator or technician time lost waiting on instructions, materials, tools, or approvals.
  • Motion Losses: Inefficient operator movement — walking, reaching, searching — that adds no value.
  • Line Organization Losses: Idle time created when one process in a line waits on an unbalanced process.
  • Logistics Losses: Time lost moving materials, parts, and tools between storage, machines, and work areas.
  • Measurement and Adjustment Losses: Time spent on quality checks, calibration, and in-process adjustments.

Resource Losses — Waste Materials, Energy, and Tooling (3 Losses)

  • Yield Losses: Raw material consumed beyond the theoretical minimum needed for good output.
  • Energy Losses: Power, steam, air, or fuel consumed without a matching gain in output.
  • Die, Jig, and Tool Losses: Cost of dies, jigs, and tooling replaced or repaired sooner than their expected service life.

TPM Loss-to-OEE Mapping Matrix

All sixteen losses ultimately register in one of the three OEE components: Availability, Performance, or Quality. Seeing which bucket a loss falls into helps a maintenance team decide whether the fix belongs to reliability engineering, process engineering, or the operator training program.

Loss CategoryExample LossOEE Component AffectedTypical CMMS Data Source
EquipmentFailure/BreakdownAvailabilityDowntime log by asset
EquipmentSetup/AdjustmentAvailabilityWork order category tag
EquipmentSpeed LossPerformanceActual vs. rated cycle time
EquipmentDefect and ReworkQualityDefect tag on batch/shift
HumanManagement LossPerformance (indirectly)Work assignment timestamps
ResourceEnergy LossCost, not OEE directlyAsset-level utility metering

Equipment losses map directly to OEE. Human and resource losses influence OEE indirectly by freeing up the time and materials that go into Availability, Performance, and Quality in the first place.

How Cryotos Tracks and Reduces the 16 Major Losses

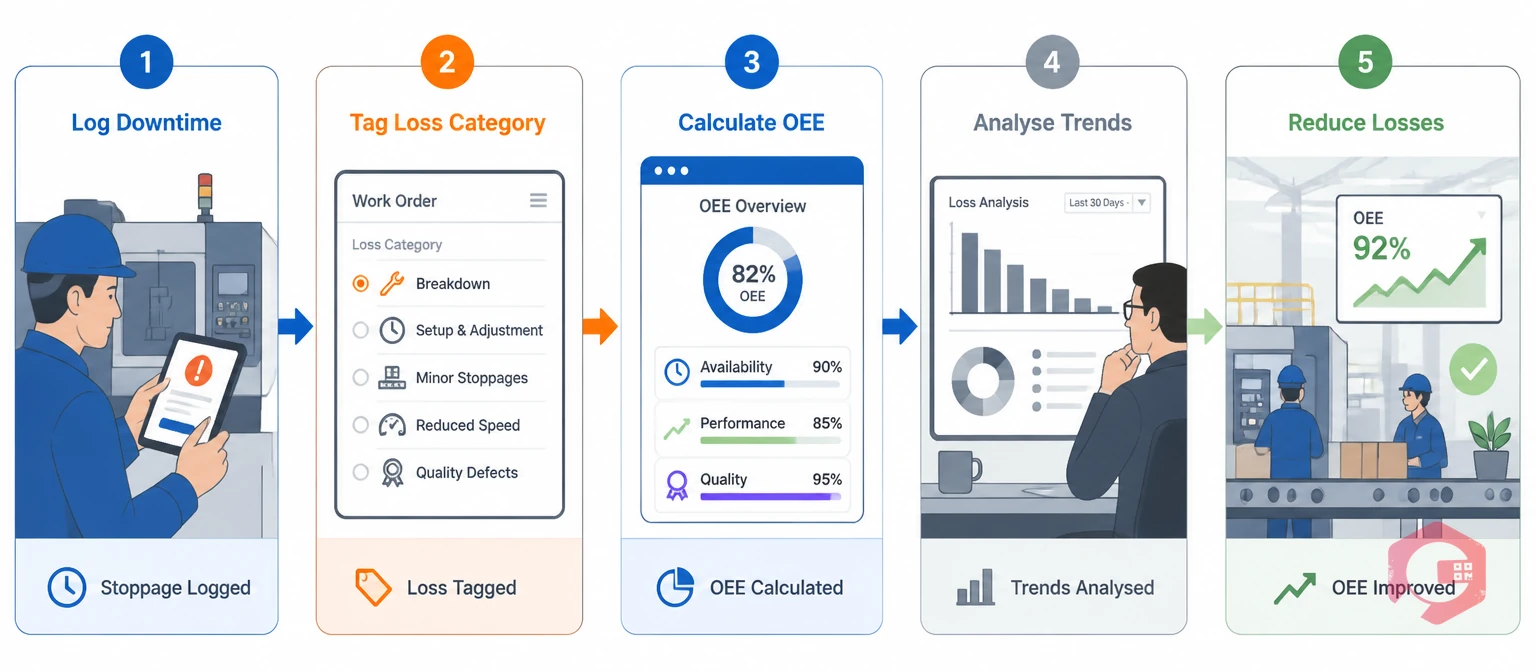

5-step CMMS process flow for tracking and reducing TPM losses: Log Downtime, Tag Category, Calculate OEE, Analyse Trends, Reduce Losses | Cryotos

Without a system built for it, most of the sixteen losses stay invisible — absorbed into "normal" operations until they compound into missed production targets and rising maintenance costs. A CMMS downtime tracking module gives maintenance and operations teams the infrastructure to log, categorize, and quantify each loss individually.

Real-Time Downtime and Failure Logging

Cryotos captures every stoppage the moment it happens — cause, duration, asset, and technician — through mobile work order updates. This turns Failure, Minor Stoppage, and Planned Shutdown Losses into structured, timestamped data instead of shift-report guesses.

OEE Calculation Across Availability, Performance, and Quality

Cryotos rolls up downtime, speed, and defect data into the three OEE components automatically. Maintenance managers can see exactly which of the eight equipment losses is dragging a specific asset's OEE down instead of reading one blended efficiency number.

Setup, Changeover, and Tool-Change Time Tracking

Work orders can be tagged by category — changeover, adjustment, tool change, startup — so each loss shows up as its own line item rather than folded into generic "downtime." Managers watch changeover time trend up or down per asset, line, or shift.

Defect and Rework Work Order Tagging

When an operator or inspector flags non-conforming output, Cryotos logs the defect against the asset, batch, and shift that produced it. That gives Defect and Rework Losses a direct link to their root cause instead of a scrap percentage buried in a monthly report.

Planned vs. Unplanned Maintenance Ratio Tracking

Cryotos tracks the ratio of planned maintenance to reactive work orders across every asset and line. As Failure and Minor Stoppage Losses decline through better PM scheduling, that ratio shifts measurably — a leading indicator, not just a lagging OEE score.

AI-Powered Loss Analytics Dashboard

Teams can ask the Cryotos BI dashboard in plain English: "Which assets had the highest speed losses last month?" The answer comes back as a chart, pulled straight from the report builder — no SQL, no spreadsheet, no waiting for a monthly report.

How Reducing the 16 Losses Impacts Plant Performance

Four plant performance outcomes from reducing TPM losses: Early Failure Detection, Shorter Changeover, Visible Stoppages, Less Rework | Cryotos

Once the sixteen losses are visible and tracked individually, the effect on plant performance compounds. The gain isn't one number — it shows up across OEE, labor productivity, and material consumption at the same time. Teams that only chase OEE as a single score tend to plateau, because a rising Quality component can quietly mask a falling Availability component. Breaking the score back down into its sixteen sources is what turns a stalled improvement program into one that keeps finding new ground.

  • Failures get caught early: A bearing that fails every 400 hours gets scheduled on a PM instead of failing mid-run, converting a Failure Loss into a cheaper Planned Shutdown Loss.
  • Changeover time shrinks: Tracking setup time per technician surfaces the slowest changeovers so best practices from the fastest ones get standardized across the team.
  • Minor stoppages become visible: Five-minute jams and below-rate running finally show up as a quantified output loss instead of disappearing into shift variance.
  • Rework declines: Linking defects to the asset and shift that caused them turns quality loss into an actionable root-cause list instead of a scrap-rate line item.
  • Human losses shrink: Digital work assignment cuts the waiting, searching, and material-handling time behind Management, Motion, and Logistics Losses.
  • Resource losses become manageable: Tying energy and material use to specific assets turns a plant-wide utility bill into an asset-level cost driver.

Cryotos's own downtime tracking customers report up to a 30% reduction in unplanned downtime and 25% faster repair times once loss data moves from paper logs into a structured system — evidence that visibility, not more staff, is usually the missing piece.

How to Start Tracking the 16 Major Losses in Your Plant

Most plants don't need a new framework meeting before they start — they need a way to log the losses that are already happening. The rollout usually works better in stages than as a single big-bang launch across every asset at once.

  • Pick one line or asset group first. Start with the equipment that already generates the most complaints about downtime or scrap, so the data has an obvious owner from day one.
  • Standardize the loss categories before go-live. Give operators and technicians a short, fixed list of loss codes tied to the 16 categories — free-text downtime reasons never roll up cleanly into a report.
  • Log minor stoppages, not just breakdowns. A five-minute jam feels too small to log, but a shift's worth of them can outweigh one major breakdown. Make logging fast enough that operators actually do it.
  • Review the data weekly, not monthly. Weekly review catches a drifting changeover time or a rising defect rate while it's still a small problem, not a quarter later.
  • Tie every loss back to an owner. A Motion Loss belongs to a supervisor rethinking workstation layout; a Speed Loss belongs to process engineering. Losses without an owner tend to stay losses.

None of this requires new hardware on day one. A work order management system that already captures asset, cause, and duration on every job is usually enough to start seeing the pattern within the first few weeks.

Frequently Asked Questions

What is the difference between the 16 major losses and the 7 wastes of lean?

The 16 major losses come from the TPM/JIPM tradition and focus specifically on equipment effectiveness, labor productivity, and resource use on the plant floor. The 7 wastes come from lean manufacturing and describe waste in any process, not just equipment-heavy ones. Many plants track both frameworks side by side.

Which of the 16 losses affects OEE the most?

There's no universal answer — it depends on the plant. Discrete manufacturers with older equipment often see Failure/Breakdown Losses dominate Availability, while high-speed lines more often lose ground to Speed Losses and Minor Stoppages under the Performance component.

Can a CMMS track all 16 major losses on its own?

A CMMS can capture and quantify all eight equipment losses and most human losses directly through work orders, downtime logs, and defect tagging. Resource losses like energy and yield typically need a metering or ERP integration feeding into the same system for full visibility.

How long does it take to see results from tracking the 16 losses?

Most teams see the biggest early wins — visibility into minor stoppages and changeover time — within the first one to two months of consistent logging. Failure-pattern insights and PM schedule adjustments usually take a full quarter of data to surface reliably.

Do all 16 losses apply to every industry?

Not equally. A continuous-process plant (chemicals, utilities) tends to feel Speed and Energy Losses more sharply, while a discrete manufacturer with frequent product changeovers feels Setup, Adjustment, and Cutting Tool Losses the most. The framework still applies everywhere — the weighting just shifts by industry.

Tracking the 16 major losses in TPM isn't a one-time audit — it's an ongoing discipline. Every shift logged and every defect tagged adds to a dataset that gets more actionable over time, and OEE climbs as a direct result of visibility rather than guesswork. Schedule a free demo to see how Cryotos maps these losses to your own assets.
