How to Convert OEM PM Recommendations into a CMMS Schedule

Calendar
Duration:
18 min read
calendar today
Published on
June 17, 2026
Featured Image

Converting OEM PM recommendations into a CMMS schedule means translating the maintenance intervals, task lists, and service procedures from an equipment manufacturer's manual into structured, automated work orders inside your computerised maintenance management system. Done correctly, this process turns a static document — typically a PDF or paper manual that lives in a drawer — into a live, self-executing maintenance programme that fires work orders at the right time, with the right instructions, assigned to the right technician. According to the Society for Maintenance and Reliability Professionals (SMRP), organisations that systematically load manufacturer recommendations into their CMMS reduce missed PM events by up to 35% compared with teams managing schedules manually. This guide walks through the full conversion process step by step.

Key Takeaways

  • OEM manuals are a starting point, not a final answer: Manufacturer intervals are set for average conditions — your operating environment, duty cycle, and criticality score must modify them before they go into the CMMS.
  • Every OEM task maps to four CMMS fields: Trigger type, interval value, task checklist, and assigned role — getting all four right is what separates a working schedule from one that generates ignored work orders.
  • Consolidate tasks before loading: Multiple OEM tasks with identical intervals on the same asset should be grouped into a single work order — fragmented scheduling wastes technician travel time and inflates work order counts.
  • The first 90 days are a calibration phase: OEM intervals loaded directly often need adjustment after your first quarter of real-world data — build that review into the implementation plan from day one.

Why OEM Recommendations Are a Starting Point, Not a Final Schedule

Four factors why OEM PM recommendations need real-world adjustment before loading into CMMS | Cryotos

Equipment manufacturers publish maintenance recommendations based on testing under controlled conditions — rated loads, stable ambient temperatures, clean environments, and standard operating cycles. Your facility almost certainly differs from those test conditions in at least one significant way.

A centrifugal pump manufacturer recommends bearing inspection every 2,000 operating hours. Your pump runs in a hot, humid environment at 110% of its rated flow rate for 18 hours a day. The OEM interval was set for a pump running at 75% load in a climate-controlled test cell. Applying it unchanged to your asset creates a real risk of failure before the next scheduled PM.

The reverse is equally common: a compressor rated for continuous industrial use may have an OEM oil change interval of 500 hours. In your application, it runs for 4 hours per day in a clean, temperature-controlled room. The 500-hour mark arrives after 125 working days. Your actual oil degradation rate is far slower than the OEM anticipated — and you are wasting parts and labour maintaining on a schedule designed for heavier use.

The right approach is to use OEM recommendations as the baseline, then adjust each interval based on three factors: your asset's actual operating conditions, its criticality score, and any failure history you have accumulated. Load the OEM baseline first, then calibrate.

Step 1: Extract and Structure the OEM Data

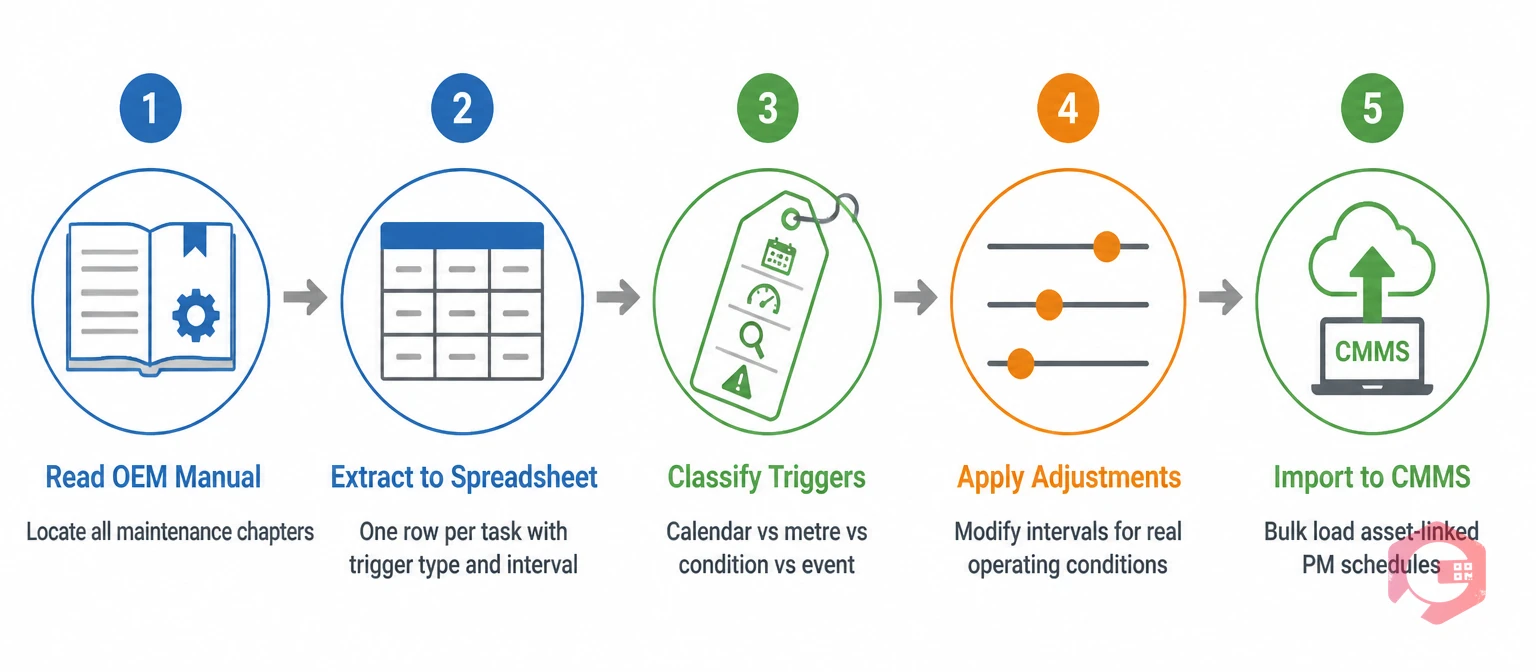

5-stage process flow for extracting OEM PM data and importing into CMMS schedule | Cryotos

Before you can load anything into a CMMS, you need to turn an unstructured manual into a structured dataset. Most OEM manuals are not written for CMMS import — they are written for technicians, with tasks scattered across multiple chapters, expressed in prose rather than structured fields.

Work through the manual systematically and extract the following for each maintenance task:

  • Task description: The specific action required — inspect, lubricate, replace, calibrate, test. Be precise. "Check belts" is not a task description. "Inspect drive belts for cracking, fraying, and tension loss; replace if tension deflection exceeds 10mm" is.
  • Trigger type: Is the task calendar-based (every 3 months), usage-based (every 500 operating hours), or condition-based (when vibration exceeds a set threshold)? Identify which type the OEM intends — many manuals mix all three without labelling them.
  • Interval value: The specific number — 3 months, 500 hours, 10,000 cycles. Record the exact figure the OEM specifies, not a rounded approximation.
  • Parts required: List every consumable, filter, or replacement component the task requires, with the OEM part number where provided. This becomes your CMMS parts list for the work order.
  • Special tools or safety requirements: Any lockout/tagout requirement, torque specification, calibration equipment, or PPE requirement the OEM specifies. These belong in the task checklist, not in a separate document.

A spreadsheet works well for this extraction phase. One row per task, with columns for each field above. You will import from this into your preventive maintenance software in the next step — having it structured now makes the import clean and fast.

Plan for 30–90 minutes per asset depending on manual complexity. A simple pump with 10 maintenance tasks takes 30 minutes to extract correctly. A complex CNC machining centre with 80+ tasks across multiple subsystems may take a full afternoon.

Step 2: Classify Each Task by Trigger Type

Not all OEM tasks should go into the CMMS as the same trigger type. Getting the trigger classification right is what determines whether your PM programme is efficient or wasteful.

  • Calendar triggers (time-based): Use for tasks that degrade with time regardless of usage — lubricant shelf life, rubber seal hardening, battery backup testing, compliance inspections. The CMMS fires the work order on a fixed date recurrence. Example: "Replace hydraulic fluid every 12 months."
  • Metre triggers (usage-based): Use for tasks where wear correlates directly with operation — bearing inspections, oil changes, belt checks, filter replacements on variable-utilisation equipment. The CMMS fires the work order when the asset's hour metre or cycle counter reaches the threshold. Example: "Inspect bearing every 1,000 operating hours." Use metre-based maintenance triggers for any asset where actual utilisation varies significantly between periods.
  • Condition triggers: Use for tasks where the OEM specifies a condition threshold rather than an interval — temperature, vibration, pressure differential, or oil contamination level. These require sensor integration and map to condition-based maintenance work order triggers in the CMMS. Example: "Replace air filter when pressure differential exceeds 0.5 bar."
  • Event triggers: Use for tasks the OEM specifies after a defined event — post-overhaul inspection, startup check after extended shutdown, or post-repair verification. These are not recurring schedules but one-time work orders linked to a parent event.

A single asset may have tasks across all four trigger types. A compressor, for example, might have monthly calendar-based safety checks, 500-hour metre-based oil changes, condition-based filter replacements, and a post-overhaul inspection protocol. Each maps to a different trigger type in the CMMS.

Use the MTBF calculator to benchmark your asset's observed failure intervals against the OEM metre-based thresholds — if real-world MTBF is significantly longer than the OEM interval implies, you have room to extend; if shorter, tighten before loading.

OEM Recommendations vs. Real-World Adjustments

Condition FactorOEM Baseline AssumptionAdjustment DirectionExample
Operating load75–80% of rated capacityShorten interval if running above rated loadPump at 110% rated flow → reduce bearing inspection from 2,000h to 1,200h
Ambient temperature15–25°C controlled environmentShorten interval in high heat; extend in cool environmentsCompressor in 45°C plant room → halve oil change interval
Dust and contaminationClean, low-particulate environmentShorten filter and lubrication intervals significantlyCement plant → filter PM every 2 weeks vs OEM monthly
Utilisation rateSingle-shift operationConvert to metre-based and shorten for 24/7 operation24/7 generator → oil change at 500h not 12 months
Asset criticalityStandard production assetShorten for critical assets; extend for non-criticalSingle-path cooling tower → tighten OEM interval by 25%

Apply these adjustments to your extracted task list before loading into the CMMS. Document each adjustment and its rationale — this becomes your evidence base when reviewing schedule performance at the 90-day mark.

Step 3: Build Task Checklists in the CMMS

A PM trigger that fires without a specific checklist produces inconsistent work. Two technicians responding to the same "500-hour bearing inspection" work order will do different things if there is no checklist — one will do a visual check, another will take a temperature reading, a third will pack grease without checking the existing grease condition first.

Every OEM-sourced PM task needs a structured checklist in the CMMS. Build each checklist directly from the OEM procedure, field by field:

  • Safety pre-check: List every lockout/tagout, isolation, or PPE requirement the OEM specifies. Make this the first mandatory step — technicians cannot skip it or mark the task complete without confirming it.
  • Inspection points: Convert each OEM inspection instruction into a discrete checklist item with a specific pass/fail criterion. "Inspect drive belt" becomes "Inspect drive belt — record tension deflection (pass: <10mm). Inspect for cracking or fraying (pass: none visible). Photo required."
  • Measurement fields: Where the OEM specifies readings — torque values, pressure readings, temperature checks, vibration measurements — add a numeric input field with the OEM specification range. The technician enters the actual reading; the CMMS flags out-of-range values automatically.
  • Parts consumption log: Add a parts field for every consumable the task requires. The technician confirms quantity used; the CMMS deducts from stock automatically via the maintenance checklist integration with inventory.

Detailed checklists loaded from OEM procedures also serve as on-site reference documents — technicians access them on their mobile devices at the machine, eliminating the need to carry paper manuals or return to the office to check a procedure.

Step 4: Consolidate and Load the Schedule

Before importing, review your extracted task list for consolidation opportunities. Multiple tasks with identical or near-identical intervals on the same asset should be grouped into a single work order rather than separate ones. A compressor with a 500-hour oil change, a 500-hour belt inspection, and a 500-hour coupling check should be one work order with three checklist sections — not three separate work orders that all arrive at the same time and require the same shutdown.

Fragmented scheduling is one of the most common CMMS mistakes when converting from paper-based OEM schedules. It inflates work order volume, requires multiple separate shutdowns where one would do, and makes compliance reporting harder. A single consolidated 500-hour PM work order with a comprehensive checklist is cleaner, faster to execute, and easier to track than three separate orders.

When loading into the CMMS, map each task to the correct asset record. Every PM in the system should be linked to a specific asset ID — not just an asset type or location. This asset linkage is what enables the CMMS to build an accurate maintenance history, track parts consumption per asset, and eventually surface MTBF trends that allow you to validate and refine your OEM-sourced intervals.

Cryotos's CMMS supports bulk import of PM schedules via Excel template — you can import the entire extracted task list in a single operation rather than creating each PM manually. The import maps directly to asset records, trigger types, intervals, and checklist templates in one pass.

Step 5: Calibrate After the First 90 Days

OEM intervals loaded directly into a CMMS are educated starting points. After 90 days of execution, your work order data will tell you whether those starting points are well-calibrated or need adjustment.

Pull these four data points from your CMMS at the 90-day mark:

  • PM findings at completion: Are technicians consistently finding near-perfect equipment — no wear, no contamination, nothing to adjust? That is a strong signal the interval is too short and the PM is unnecessary at this frequency. If technicians are finding significant wear, contamination, or out-of-spec readings, the interval may be too long.
  • Reactive work orders on PM-covered assets: If assets with a full OEM-sourced PM schedule are still generating reactive breakdown work orders, either the PM tasks are incomplete, the intervals are too long, or the checklists are not being executed correctly.
  • PM compliance rate: Are work orders completing on time? A low compliance rate often signals that the scheduled volume is too high for your current technician capacity — consolidation or interval extension may be needed.
  • Parts consumption vs. forecast: If actual parts consumption significantly exceeds the OEM-implied quantity, your assets are wearing faster than the OEM baseline assumes — a signal to tighten intervals, not just reorder parts faster.

According to Reliable Plant's guidance on PM programme development, most teams that load OEM-based schedules discover 20–30% of intervals need adjustment within the first 6 months — either tightened for harsh-environment assets or extended for light-duty applications. Build the 90-day review into your implementation plan from day one so it happens as a scheduled event, not an afterthought.

How Cryotos CMMS Supports OEM Schedule Conversion

Four Cryotos CMMS features that support OEM PM schedule conversion — trigger types, bulk import, mobile checklists, calibration reporting | Cryotos

Cryotos is built to handle the full OEM-to-CMMS conversion workflow without manual workarounds. The platform supports all four PM trigger types natively — calendar, metre-based, condition-based, and event-based — on a single asset simultaneously, so assets with mixed OEM trigger types load cleanly without splitting into separate systems.

The bulk Excel import feature handles large asset fleets efficiently. Maintenance teams managing 200+ assets across multiple sites can import their entire OEM-extracted task library in a single file — with asset linkage, trigger configuration, and checklist attachment all resolved in the import template rather than through manual CMMS entry. The planned downtime calendar view shows the aggregate PM load week-by-week after import, making it easy to identify front-loaded schedules before they create execution backlogs.

The checklist builder allows maintenance managers to build OEM-faithful task procedures directly in the CMMS, with mandatory photo fields, numeric measurement inputs, and parts consumption logging built into each checklist step. Technicians access checklists on their mobile devices — including in fully offline environments — so the OEM procedure is at the machine, not in an office drawer.

After the 90-day calibration phase, Cryotos's reporting layer surfaces the findings data, reactive work order patterns, and MTBF trends that drive evidence-based interval adjustments. The PM schedule evolves from an OEM starting point into a data-calibrated programme — without manual spreadsheet analysis. According to Plant Maintenance Resource Center, facilities using CMMS-driven PM interval analysis reduce total maintenance labour costs by 15–25% within 18 months of systematic OEM-to-CMMS conversion.

Frequently Asked Questions

What is the first step in converting OEM recommendations to a CMMS schedule?

Start by extracting every maintenance task from the OEM manual into a structured spreadsheet — one row per task, with columns for task description, trigger type (calendar/usage/condition), interval value, parts required, and safety requirements. This structured extract is what you import into the CMMS, and getting it clean before import saves significant rework later.

Should I load OEM intervals exactly as stated in the manual?

Use OEM intervals as your starting baseline, then adjust for your actual operating conditions before loading. Assets running above rated capacity, in high-temperature environments, or in dusty/corrosive conditions will need shorter intervals than the OEM specifies. Assets in light-duty, climate-controlled applications may support longer intervals. Always start conservative and extend with data — never the reverse.

How many tasks should a single PM work order contain?

Group all OEM tasks with the same interval into a single work order per asset rather than creating one work order per task. A compressor with 8 tasks all due at 500 hours should produce one 500-hour PM work order with 8 checklist items — not 8 separate work orders. This reduces scheduling complexity, prevents multiple shutdowns for tasks that could share one window, and keeps compliance reporting clean.

How long does it take to load OEM schedules for a large asset fleet?

With a well-prepared structured extract and a CMMS that supports bulk import (like Cryotos's Excel template import), a maintenance team can load 50–100 assets with full PM schedules in a single working day. Without bulk import, the same work takes weeks of manual data entry. Allow 30–90 minutes per asset for the extraction phase from OEM manuals, plus 1–2 days for import, verification, and initial compliance configuration.

The difference between a PM programme that runs itself and one that requires constant manual intervention comes down to how cleanly the OEM data was converted in the first place. Cryotos gives your team the import tools, trigger flexibility, checklist builder, and calibration reporting to turn manufacturer documentation into a live, self-executing maintenance schedule. Schedule a free demo to see how maintenance teams use Cryotos to convert OEM manuals into running CMMS schedules — often within a single working week.
