Predictive Recommendation Engine: Data Readiness and 90-Day Rollout Guide

Calendar
Duration:
10 min
calendar today
Published on
October 15, 2026
Featured Image

A predictive recommendation engine for manufacturing maintenance is a system that reads equipment data and work order history, then suggests the task, parts, and timing for each developing fault. How useful its advice is depends less on the algorithm and more on the data you feed it.

Most plants already have sensors and a work order system, yet their history is too messy to learn from. This guide shows you how to check data readiness, fix the gaps that matter, pick pilot assets, and roll out a predictive recommendation engine in 90 days.

Key Takeaways

  • Data comes before algorithms: Coded, linked work order history decides how good the advice will be.
  • Score before you connect: A one-hour readiness review shows which data gaps to fix first.
  • Pilot small: Ten to twenty critical rotating assets in one area give enough cases without overwhelming the team.
  • Rules first, patterns later: Simple condition rules deliver value in month one while your history improves.

What Does a Predictive Recommendation Engine Need to Work?

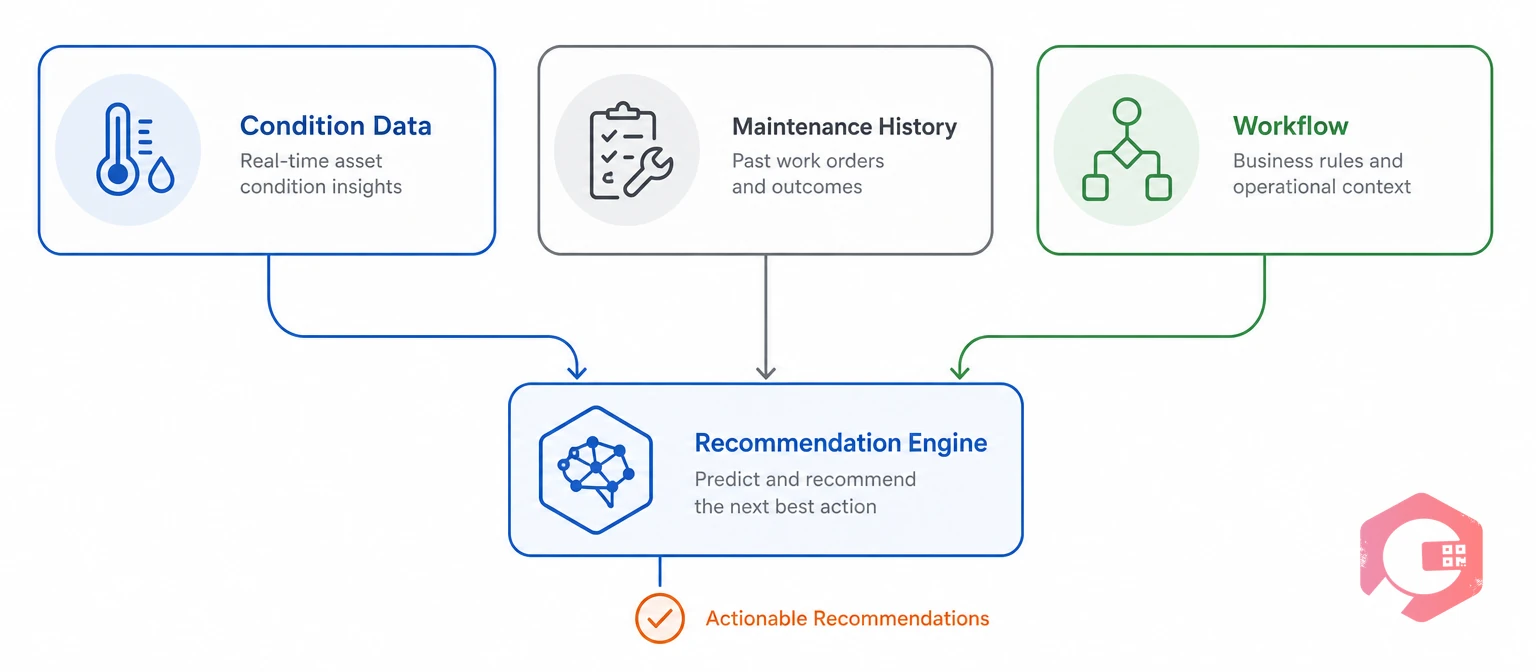

Three data inputs a predictive recommendation engine needs: condition data, maintenance history, workflow | Cryotos

A predictive recommendation engine needs three things: condition data that shows a change, history that shows what fixed it before, and a workflow that turns advice into approved work. It builds on predictive maintenance, and without all three inputs it either stays silent or gives advice nobody trusts.

Maintenance data readiness is the point where your records are complete, coded, and linked enough for software to learn from them. Standards already describe what good looks like. ISO 14224 sets a taxonomy for failure and maintenance data, and ISO 17359 gives general guidelines for condition monitoring programs.

  • Condition data: Vibration, temperature, pressure, current, and run hours from online sensors or condition monitoring routes.
  • Maintenance history: Failure modes, causes, actions taken, and parts used on each asset.
  • Context data: Spare parts stock, planned production stops, and asset criticality.

The engine borrows the idea behind a recommender system, but its past choices are your past repairs. Clean history is the biggest single factor in how good its advice becomes.

Data Readiness Scorecard for a Predictive Recommendation Engine

Score each data area before you connect anything. Run this scorecard in a one-hour review with your planner, a senior technician, and whoever owns the sensor data.

Data areaReady whenCommon gapFix first
Failure history12+ months of work orders with failure, cause, and action codesFree-text notes like "fixed" or "checked OK"Add coded dropdowns to work order close-out
Asset registerEach critical asset has a unique ID, location, and criticality ratingDuplicate or missing asset recordsClean the top 50 critical assets first
Condition dataReadings tagged to asset IDs with consistent units and time stampsSensors named by PLC tag, not by assetMap each tag to an asset record
Spare partsParts linked to the assets and repairs that use themParts stored only by item codeBuild a parts list for each critical asset
Production windowsPlanned stops shared with maintenance in advanceShutdowns decided at short noticePublish a monthly stop calendar
Feedback loopTechnicians record what they actually foundAs-found condition never capturedMake findings a mandatory field

Mark each row as ready, partly ready, or not ready. Most plants find that failure history is the weakest area, so start there.

Want a baseline before your pilot begins? Use the MTBF calculator to record the current time between failures on the assets you plan to cover.

The Data Readiness Ladder: Five Levels to Climb

Data readiness ladder with five levels: recorded, coded, linked, connected, learning | Cryotos

The Data Readiness Ladder shows where your plant stands and what to fix next. Each level builds on the one below, and the engine gives reliable advice from Level 4 upward.

The Data Readiness Ladder:

  • Level 1, Recorded: Work is logged in a system, even if the notes are free text.
  • Level 2, Coded: Failures, causes, and actions use standard codes instead of free text.
  • Level 3, Linked: Work orders, assets, parts, and readings all point to the same asset ID.
  • Level 4, Connected: Sensor and run-hour data flow in automatically and can trigger work.
  • Level 5, Learning: Technician findings feed back, so the advice improves over time.

Most plants sit between Level 1 and Level 2. You don't need Level 5 to start; you need Level 3 on your pilot assets and a clear plan to reach Level 4.

How to Clean Failure History Before You Start

Clean failure history means every closed work order on a pilot asset answers three questions: what failed, why, and what fixed it. Without those answers, the engine has nothing to match a new fault against.

A failure code is a standard label that records what failed, why it failed, and what was done. If you already have an FMEA for an asset, use its failure modes as your starting list.

Set up a short failure code list

  • Failure mode: Pick 10 to 15 codes per asset class, such as bearing wear, misalignment, seal leak, or electrical fault.
  • Cause: Add a cause code, such as poor lubrication, overload, wrong part, or operating error.
  • Action: Record what was done, such as replaced, adjusted, cleaned, or lubricated.
  • As-found condition: Capture what the technician actually saw, with a photo where possible.

How to back-fill the last 12 months of work orders

Go back through the last year of breakdowns on pilot assets and code each one. A planner and a senior technician can usually code around 100 work orders in a day.

Run a short root cause analysis on repeat failures, so the cause field holds the real reason and not just the symptom. Coded history is the fuel every recommendation runs on.

How to Choose Pilot Assets for a Predictive Recommendation Engine

The best pilot assets are critical, fail often enough to learn from, and give a measurable warning signal. Rotating equipment such as motors, pumps, fans, gearboxes, and compressors usually fits all three.

  • High criticality: A failure stops production, creates a safety risk, or costs a lot to repair.
  • Enough failure history: At least three or four recorded failures in the last few years.
  • A clear signal: Wear shows up early in vibration, temperature, current, or oil condition.
  • Easy access to data: Sensors already exist, or readings can be taken on a route.
  • A willing owner: The area supervisor wants to try the new way of working.

Start with 10 to 20 assets in one area. A small pilot is easier to clean, easier to review, and easier to defend when you ask for a wider rollout.

90-Day Rollout Plan for a Predictive Recommendation Engine

90-day rollout plan in three phases: get data ready, connect and write rules, review and refine | Cryotos

A 90-day rollout works best when you start with simple rules and add pattern matching only where history is strong. Rules deliver value in the first month while data quality improves in the background.

Days 1 to 30: get the data ready

  • Score readiness: Run the scorecard on every pilot asset.
  • Code history: Add failure, cause, and action codes to the last 12 months of work orders.
  • Link parts: Build a parts list for each pilot asset.

Days 31 to 60: connect and write rules

  • Connect readings: Bring sensor and run-hour data in through IoT meter reading from SCADA, PLCs, or edge devices.
  • Write rules: Link each condition to an action, such as "bearing temperature rising for 3 days means inspect lubrication."
  • Set approval: Route each recommendation to a planner before it becomes a work order.

Days 61 to 90: review and refine

  • Track results: Measure acceptance rate and confirmed findings every week.
  • Tune rules: Fix or remove rules that planners keep rejecting.
  • Add matching: Where five or more similar past cases exist, suggest the fix that worked before; prognostics models for remaining useful life can come later.

At day 90, choose the next area based on the numbers, not on enthusiasm.

Guardrails That Keep Technicians Trusting the Advice

Technicians follow advice they can check and ignore advice they can't. Guardrails make each recommendation explainable, reviewable, and safe.

  • Show the reason: Every suggestion lists the readings and past cases behind it.
  • Match action to confidence: Low-confidence advice triggers an inspection, not a part change.
  • Keep a human approver: A planner approves work through workflow automation before it is scheduled.
  • Respect safety rules: Recommendations never skip OSHA lockout steps, permits, or standard procedures.
  • Capture feedback: Rejected advice needs a short reason, so rules can be corrected.

Operations that successfully scale these programs treat a planner's "no" as useful data, not as a failure of the system.

KPIs to Track During Your Pilot

Pilot KPIs should show whether the advice is trusted, accurate, and reducing breakdowns. Track them monthly against the baseline you took before day one.

Acceptance rate is the share of recommendations that planners approve before scheduling. It is the earliest sign of whether the engine is earning trust.

  • Acceptance rate: Below 50% usually means the rules need work.
  • Confirmed findings: The share of jobs where technicians found the predicted problem.
  • Warning lead time: The days between the first recommendation and the expected failure.
  • Unplanned downtime: Breakdown hours on pilot assets compared with the baseline.
  • Planned work ratio: The share of maintenance hours that were planned; many reliability teams target 80% or more.

Acceptance and confirmed findings usually rise before downtime falls, so give the first quarter time to show results.

How Cryotos Supports a Predictive Recommendation Engine

A Computerized Maintenance Management System holds the history, parts, and workflows a predictive recommendation engine depends on. Cryotos helps plants climb the Data Readiness Ladder on their pilot assets.

  • Coded work orders: 5 Whys root cause records and mandatory close-out fields keep failure history usable.
  • Sensor-triggered work: SCADA, PLC, and edge readings can raise condition-based work orders.
  • Parts readiness: Spare parts inventory software with minimum-level alerts shows whether a recommended fix can start.
  • Past fixes at the job: The AI-powered knowledge base gives technicians earlier solutions and procedures.
  • Fast findings: AI work order creation by voice or photo captures what technicians found.

Maintenance teams using Cryotos have reported up to 30% reduction in unplanned downtime and 25% faster repair turnaround. Most plants begin with critical rotating equipment in one area.

Frequently Asked Questions

How do I know if my maintenance data is ready for a predictive recommendation engine?

Check whether closed work orders on your critical assets record what failed, why, and what fixed it, using standard codes. If most of them are free text, code the last 12 months before you connect sensors.

How many assets should a predictive maintenance pilot include?

Ten to twenty critical assets in one area is usually enough. That gives you enough cases to learn from while keeping cleanup and review manageable.

What failure codes should a manufacturing plant use for maintenance?

Use a short list of failure mode, cause, and action codes for each asset class. ISO 14224 is a useful reference taxonomy that you can simplify to 10 to 15 codes per class.

Can we start if only some of our assets have sensors?

Yes. Route-based readings and run hours from a PLC can feed the same rules. Add online sensors later on the assets where early warning matters most.

How long does it take before maintenance recommendations become useful?

Simple rules can give useful advice within the first 30 to 60 days. Pattern matching improves as more coded cases build up, usually over several months.

Who should approve maintenance recommendations before work is scheduled?

A planner or reliability engineer should approve each one before it becomes a work order. Technicians should be able to add findings and reject advice with a short reason.

Better data turns warnings into the right job at the right time. Schedule a free demo to see how Cryotos prepares your plant's maintenance data for predictive recommendations.
